How Long Does It Take to Get a Building Permit in San Jose

Planning an ADU, addition, or remodel and wondering how long to get a building permit in San Jose? The honest answer is anywhere from one business day to six months, and the spread traces almost entirely to project complexity, submittal completeness, and where the PBCE queue sits on the day the application lands. Our team has pulled permits across dozens of residential projects in San Jose, and the patterns are consistent enough to give reliable estimates — which is exactly what any credible construction schedule demands. A thorough understanding of the full custom home permits and approvals process in San Jose is the prerequisite for building a timeline that holds.

Building permit timeline for San Jose residential projects showing how long to get a building permit in San Jose
Figure 1 — Permit timelines in San Jose vary significantly by project type and review pathway.

San Jose's Department of Planning, Building and Code Enforcement (PBCE) processes residential permits under California Building Code Title 24, layered with local amendments covering seismic, energy, and accessibility requirements. Spring and summer review queues consistently run three to four weeks longer than winter cycles — a variable our team bakes into every project schedule from the first planning conversation, not as an afterthought.

The single most decisive factor is whether a project qualifies for Over-the-Counter (OTC) approval or gets routed to full plan check. That one routing determination compresses or extends the entire permit window by eight to twelve weeks, and most people don't understand how the decision gets made until they're already waiting on a response.

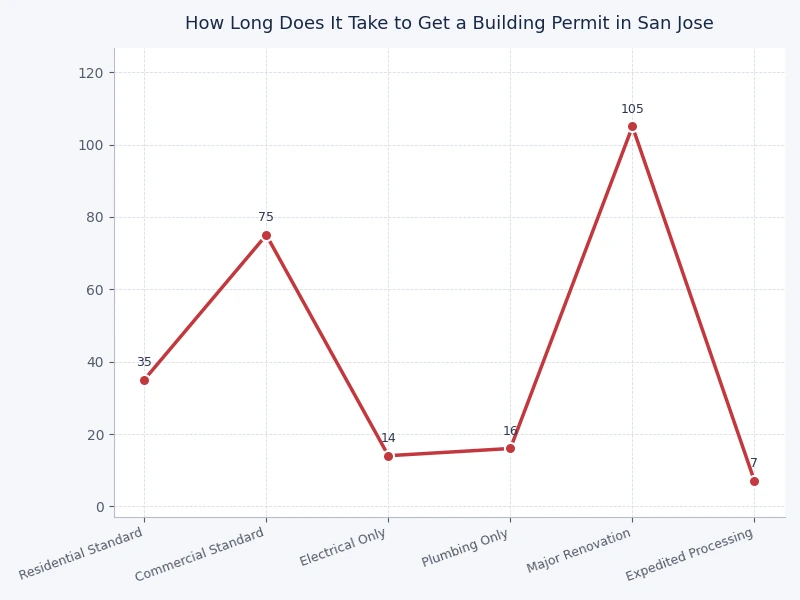

Chart showing average San Jose building permit timelines by project type and review pathway
Figure 2 — Average permit timelines by project category in San Jose, based on our team's project history.

Simple vs. Complex: How Project Scope Shapes the Timeline

The PBCE assigns every submittal to one of two tracks almost immediately upon intake: OTC or routed plan check. What determines that assignment is not arbitrary — it follows a clear logic based on structural involvement, new square footage, and MEP scope.

Projects That Move Fast

Straightforward work — water heater replacements, electrical panel upgrades, simple deck additions without structural modifications — typically qualifies for same-day or next-day OTC approval when the submittal package arrives complete. A clean OTC package is the fastest path through the PBCE system, full stop. Our team submits OTC candidates in person at the PBCE counter rather than through the ePermits portal when timing is tight, because counter staff can flag corrections on the spot and avoid triggering a digital correction cycle that adds days to a process that should take hours.

Projects That Require Full Plan Check

Anything involving structural work, new square footage, ADU conversions, or significant MEP additions goes to routed plan check. The standard residential review cycle runs fifteen to twenty-one business days for first comments. A second correction round adds another ten to fifteen business days. Projects drawing fire department review or Title 24 energy comments can generate a third round. Three correction cycles on a room addition push total permit time past four months without anyone making a single procedural error — the system simply works that way.

  • ADU conversions (garage, basement, attached): 6–12 weeks typical
  • Room additions under 500 sq ft: 8–14 weeks
  • Custom new construction: 16–28 weeks
  • Solar and battery storage (standalone): 3–7 business days via SolarApp+
Pre-application meetings with PBCE plan reviewers are free and frequently eliminate one full correction cycle — our team treats them as non-optional on any project above $100K in construction value.

Real Project Timelines We've Tracked in San Jose

Our experience across ADU builds, room additions, and custom homes in San Jose produces a data set that cuts through the generic ranges published in most permitting guides. The numbers below reflect actual elapsed time from submittal to permit issuance, not PBCE's advertised targets.

ADU and Garage Conversion Projects

Garage-to-ADU conversions in established San Jose neighborhoods have consistently run eight to eleven weeks when structural drawings are clean and Title 24 energy calculations arrive pre-approved. Our fastest permit was six weeks on a detached garage conversion in Willow Glen with zero correction comments; our longest was nineteen weeks on an attached conversion that triggered a DSA accessibility review comment on the path-of-travel to the primary dwelling. Most project teams underestimate how often an ADU conversion triggers ADA path-of-travel requirements on the existing structure, and our team now flags that exposure during design, not after submittal. The full scope of what's involved is covered in our guide to garage to ADU conversion in San Jose.

Room Additions and Custom Homes

Room additions in the 300–600 sq ft range have landed in the ten-to-fourteen-week range for first-permit issuance when geotechnical and structural documentation align from the start. Custom ground-up projects operate in an entirely different category — twenty to twenty-eight weeks is realistic when design-review overlay districts or discretionary approval conditions apply. The Berryessa corridor and Almaden Valley have both seen particularly heavy queue loads over recent construction cycles, adding two to four weeks above the citywide average.

When Permit Speed Is Critical to the Build Schedule

Most permit delays are inconvenient. Some are genuinely costly, and knowing which scenarios carry structural financial risk helps prioritize where to invest in expediting services and pre-submittal preparation.

Financing and Rate Lock Windows

Construction loan rate locks typically run sixty to ninety days. A permit delay that pushes past the lock expiration forces a relock at current market rates, which can materially change project economics on a fixed-budget build. Our team consistently advises starting the permit process before finalizing financing terms, specifically to reduce this risk — not the other way around.

Contractor Scheduling and Crew Availability

Quality subcontractors in the Bay Area book out eight to twelve weeks in advance. A permit that arrives three weeks late can displace the entire project by four months when the original crew slot gets filled by another job. Factoring realistic permit timelines into the contractor scheduling conversation from the first planning meeting is standard practice for our team, and it prevents the most avoidable category of project delay we encounter.

San Jose's paid expedited plan check service can cut standard review times roughly in half — it is worth serious evaluation on any project where financing or contractor scheduling creates a hard mobilization deadline.

Permit Myths That Cost San Jose Homeowners Months

Our advisory team corrects permit misconceptions in nearly every initial client consultation. Several of these myths cause direct, measurable delays when homeowners or contractors act on them without understanding the reality behind the assumption.

Myth: Pre-Approved ADU Plans Are Always Faster

San Jose maintains a library of pre-approved ADU plan sets, and the intent is genuine time savings. In practice, pre-approved packages still require site-specific review for setbacks, utility connections, and soils conditions — meaning the savings are often modest and sometimes nonexistent. Our team has seen pre-approved submittals run as long as fully custom-drawn packages when site conditions generate review flags from the plan checker.

Myth: Minor Work Doesn't Need a Permit

This is the most expensive misconception in residential construction, and our team sees the consequences of it regularly. Work completed without a permit that surfaces during a sale, a subsequent inspection, or a neighbor complaint triggers a retroactive permit process that is slower, more invasive, and more expensive than the original permit would have been. Our detailed breakdown of common code violations in San Jose home remodels covers exactly what this retroactive process looks like in practice, and the pattern is consistent: unpermitted work compounds costs at every stage of discovery.

Over-the-Counter vs. Full Plan Check: A Direct Comparison

The routing determination is binary, but understanding the criteria for each path allows project teams to structure scopes and submittals to qualify for OTC wherever it's legitimately achievable — and to set accurate expectations when full plan check is unavoidable.

Factor Over-the-Counter (OTC) Full Plan Check
Typical approval time Same day – 3 business days 15–21 business days per round
Project types Water heaters, panels, decks, fences, minor mechanical ADUs, additions, structural work, new construction
Correction cycles Resolved at counter, same visit 1–3 rounds typical; each adds 10–21 days
Expedite available N/A — already fast Yes, for additional fee (50–75% premium)
Structural drawings required Usually no Always yes
Title 24 energy calc required Rarely Almost always

Our team structures project scopes to keep non-structural improvements on a separate permit from structural work whenever it's legitimate to do so — this preserves OTC eligibility for the simpler scope elements and keeps the critical path as short as possible.

The expedited plan check premium is almost always recovered in avoided carrying costs and crew reallocation fees when a financing window or hard contractor start date is in play — the math favors paying it.

Permit Fees and Hidden Costs to Budget For

Permit fees in San Jose are calculated as a percentage of declared construction value using the PBCE's adopted fee schedule, and the totals consistently surprise first-time applicants who've only looked at the base building permit fee without accounting for all the supporting line items.

Standard Fee Structure

Residential building permit fees in San Jose typically run 1.5% to 3% of the declared construction value, encompassing plan check, building, electrical, mechanical, and plumbing permits. Most project budgets our team reviews underestimate permit fees by 40–60%, which creates a genuine cash-flow problem when the PBCE invoice arrives mid-project and the budget has already been allocated.

Impact Fees and Additional Line Items

  • School impact fees: approximately $4.79 per sq ft residential (varies by district)
  • Park dedication fees: applies to new residential units, including ADUs
  • Sewer and water connection fees: $15,000–$30,000 range for new ADU units
  • Geotechnical report: $2,500–$5,000 when required by plan check comments
  • Title 24 energy compliance (CalCERTS): $300–$800 per submittal
  • State Strong Motion Instrumentation fee: small but frequently overlooked

Our advisory services include a full permit fee projection as part of every pre-construction cost analysis, specifically because these line items are among the most consistently underestimated in residential project budgets across every project type we work on. Knowing the real permit cost before breaking ground changes project viability calculations in material ways.

Frequently Asked Questions

For a standard garage-to-ADU conversion with clean structural drawings and complete Title 24 energy calculations, our team has consistently seen permit issuance in eight to eleven weeks from initial submittal. First correction rounds add ten to fifteen business days each, making submittal quality the primary driver of total elapsed time.
OTC (Over-the-Counter) approval is handled at the PBCE counter, typically same-day to three business days, and applies to simpler work without structural components. Full plan check routes to departmental reviewers and takes fifteen to twenty-one business days per review round, applicable to ADUs, additions, and all new construction.
Yes, PBCE offers paid expedited review that typically cuts standard plan check times by forty to fifty percent. The fee premium runs 50–75% above standard plan check costs. On projects where a financing rate lock or hard contractor start date is in play, the fee is almost always less than the cost of a delayed construction start.
Most residential projects see one to two correction rounds. Projects involving fire department review, energy compliance comments, or accessibility path-of-travel issues can generate three rounds. Each round adds ten to twenty-one business days, which is why submittal completeness and pre-application meetings matter so significantly to total elapsed time.
A room addition typically requires a building permit for structural work, an electrical permit, a mechanical permit for HVAC, and a plumbing permit if any plumbing is included. All are submitted as a single package and reviewed concurrently, though each department may issue separate correction comments that must be addressed in the same resubmittal.
In theory yes, but in practice the time savings are often modest. Pre-approved plan packages still require site-specific review for setbacks, utility connections, and geotechnical conditions. Our team has seen pre-approved submittals run as long as fully custom-drawn packages on sites where non-standard conditions generate plan check comments.
Budget 1.5% to 3% of construction value for permit fees, putting a $200,000 project at $3,000 to $6,000 in combined building, plan check, electrical, mechanical, and plumbing fees. School impact fees, park dedication fees, and sewer connection fees are additional and can add $15,000 to $30,000 for projects that create new dwelling units.
Unpermitted work discovered during a sale, inspection, or complaint triggers a retroactive permit process that is consistently slower and more expensive than pulling the permit upfront. PBCE may require destructive investigation to verify compliance, double permit fees apply in many cases, and work found to be non-compliant may need to be partially demolished and rebuilt to current code standards.

Final Thoughts

Understanding how long to get a building permit in San Jose — and what actually drives that timeline — is the kind of foundational knowledge that separates projects that execute on schedule from those that spend months reacting to avoidable delays. Our team's approach starts with a permit pathway assessment and fee projection before any design work begins, because the permit process shapes every downstream decision on scope, financing, and contractor scheduling. Anyone ready to move forward on an ADU, addition, or custom home in the Bay Area can reach our team through the 9Builders advisory page to get a realistic, project-specific permit timeline before committing to a construction budget.

Related Posts

What Triggers a Building Code Inspection in California

What Triggers a Building Code Inspection in California

Discover what triggers a building code inspection in California, from new construction and major ren...

Read More →
Title 24 Energy Compliance for Bay Area Home Additions

Title 24 Energy Compliance for Bay Area Home Additions

Meet Title 24 energy compliance requirements for your Bay Area home addition with expert guidance on...

Read More →
How to Get a Retroactive Permit for Unpermitted Work in the Bay Area

How to Get a Retroactive Permit for Unpermitted Work in the Bay Area

Unpermitted work in the Bay Area? Learn how to obtain a retroactive permit—step-by-step—to legalize ...

Read More →

Ready to Start Your Project?

Contact us today for a free consultation and estimate.

Get Started
