Custom Home Permits and Approvals Process in San Jose
Getting custom home building permits in San Jose requires navigating a multi-step approval process through the city's Planning, Building, and Code Enforcement Department — and most projects take four to six months from initial application to final permit issuance. Whether you're building from the ground up or replacing an existing structure, understanding each phase saves you from costly delays. Working with an experienced custom home builder in San Jose who knows the local permitting landscape gives you a significant head start. This guide breaks down every stage of the process, from pre-application meetings to final inspections, so you can move forward with clarity.
San Jose operates under Title 20 of its Municipal Code, which governs zoning, land use, and building standards across the city. For custom homes, you'll deal with both planning entitlements (zoning approval, design review) and building permits (structural, mechanical, electrical, plumbing). These run on separate tracks, and confusing the two is one of the most common mistakes homeowners make.
The stakes are real. Building without proper permits in California carries fines, forced demolition orders, and serious complications when you try to sell. The process takes patience, but every step exists for a reason — and knowing what to expect puts you in control.
Common Permit Myths That Cost San Jose Homeowners Time and Money
Misinformation about custom home building permits in San Jose circulates widely — and acting on bad advice can add months to your timeline. Here are the myths that trip up homeowners most often.
Myth: One Permit Covers Everything
A single building permit does not authorize your entire project. Custom homes in San Jose require separate permits for grading, building, electrical, plumbing, and mechanical work. Some projects also need a tree removal permit, an encroachment permit for work near public right-of-way, or a stormwater management permit. Each has its own application, fee, and review timeline.
Myth: Your Architect's Plans Are Enough to Get Started
Architectural drawings are just one piece of the submission package. San Jose requires structural engineering calculations, a Title 24 energy compliance report, a soils report (geotechnical investigation), and a site survey at minimum. If your lot sits in a special overlay zone — hillside, flood plain, or historic district — you'll need additional studies. Submitting incomplete packages is the single biggest cause of delays.
Myth: Zoning Approval Means You Can Build
Planning entitlements and building permits are separate approvals. You can receive full zoning clearance and still wait months for your building permit. Zoning confirms your project is allowed on the lot. The building permit confirms your design meets structural, fire, and safety codes. You need both before breaking ground.
Myth: The Process Is the Same Across Santa Clara County
Each city in the county runs its own permitting department with different fees, timelines, and requirements. San Jose's process differs meaningfully from Sunnyvale, Santa Clara, or Campbell. Bay Area building permit costs vary significantly from one jurisdiction to the next, so don't assume your neighbor's experience in another city applies to yours.
How to Fix Permit Delays and Application Rejections
Even well-prepared applications hit snags. The key is responding quickly and correctly when they do.
Understanding Plan Check Corrections
After you submit your building permit application, a plan checker reviews your drawings against current codes. San Jose uses the California Building Code with local amendments. The plan checker issues a correction letter listing every item that needs revision. Common correction items include:
- Inadequate fire-rated assemblies between the garage and living spaces
- Missing or incorrect Title 24 energy calculations
- Structural details that don't match the engineer's calculations
- Setback violations caught during detailed review
- Incomplete accessibility compliance (required even for single-family)
- Missing waterproofing details for below-grade construction
Respond to every item in the correction letter — not just the ones you agree with. If you disagree with a correction, provide code references supporting your position. Ignoring items or submitting partial responses sends your application to the back of the review queue.
When Your Application Gets Rejected Outright
Outright rejections are less common than correction letters, but they happen. Typical causes include submitting to the wrong department, proposing a use not permitted under current zoning, or missing mandatory pre-application steps. If your project requires a variance or conditional use permit, that process must be completed before you apply for building permits.
Dealing with Neighbor Objections
Custom homes that require design review or a public hearing give neighbors an opportunity to comment. Objections about height, privacy, or shadowing can slow approvals. Address potential concerns proactively by reviewing your floor plan for common Bay Area mistakes that trigger neighbor complaints — oversized second stories and poorly placed windows rank high on the list.
Documents and Resources You Need Before Applying
Walking into the permit office prepared cuts weeks off your timeline. Here's the complete documentation checklist for a San Jose custom home.
Required Submittal Documents
| Document | Who Prepares It | Typical Cost | Lead Time |
|---|---|---|---|
| Architectural plans (full set) | Licensed architect | $15,000–$50,000+ | 8–16 weeks |
| Structural engineering | Licensed structural engineer | $3,000–$10,000 | 3–6 weeks |
| Title 24 energy report | Energy consultant | $1,500–$3,500 | 1–2 weeks |
| Geotechnical (soils) report | Geotechnical engineer | $3,000–$6,000 | 3–5 weeks |
| ALTA/topographic survey | Licensed surveyor | $2,000–$5,000 | 2–4 weeks |
| Stormwater control plan | Civil engineer | $2,000–$5,000 | 2–4 weeks |
| Arborist report (if trees present) | Certified arborist | $500–$2,000 | 1–2 weeks |
| School district fee receipt | Homeowner | $4.79/sq ft (varies) | 1–2 weeks |

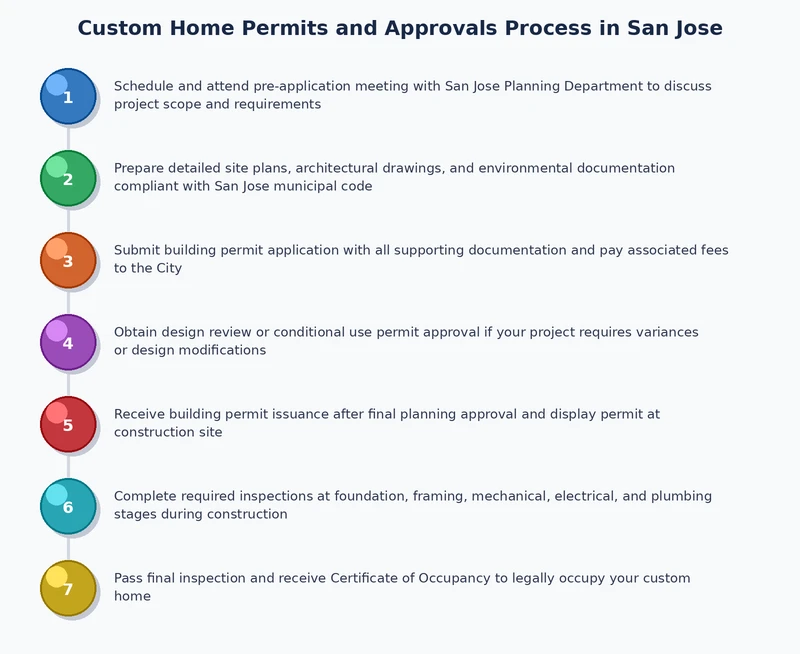

Pre-Application Meeting
San Jose offers pre-application meetings where staff reviews your preliminary plans and flags potential issues before you invest in full construction documents. This meeting is optional but strongly recommended for custom homes. It costs a modest fee, takes about an hour, and can prevent thousands of dollars in redesign work. Bring your site plan, preliminary floor plans, and a list of specific questions.
Special Permits and Overlays
Your lot's zoning designation determines which additional approvals you need. Lots in hillside areas require a Hillside Development Permit. Properties near creeks or wetlands trigger riparian corridor setback rules. Historic districts add design review layers. Before you commit to a lot, research its zoning thoroughly — understanding what's allowed on your parcel is a core part of choosing a lot for a custom home in San Jose.
Insider Strategies for a Smoother Custom Home Permit Process
Experienced builders and architects in San Jose have learned which practices consistently speed up approvals. These are the strategies that make a measurable difference.
Submit Digitally Through the Online Portal
San Jose accepts electronic plan submissions through its online permitting portal. Digital submissions typically receive initial review assignments faster than paper submissions. Upload high-resolution PDFs with clearly labeled sheets and a complete index. Blurry scans or missing sheet numbers create immediate delays.
Coordinate Your Consultants Early
Your architect, structural engineer, energy consultant, and civil engineer all need to work from the same base drawings. Discrepancies between consultant documents — different building footprints on the site plan versus the floor plan, for example — trigger correction letters. Hold a kickoff meeting with all consultants before anyone starts drafting.
Plan Around Seasonal Volume
San Jose's permit office sees predictable volume spikes. Applications surge in early spring as homeowners rush to start summer construction. Review times stretch during these peaks. If your timeline allows it, submitting in late fall or early winter often means faster turnaround. This is worth factoring into your overall custom home build timeline in San Jose.
Hire a Permit Expediter
Permit expediters are professionals who specialize in navigating municipal bureaucracies. They physically visit the permit office, track your application status, and resolve minor issues on the spot. For custom homes with complex approvals, an expediter's fee ($2,000–$5,000) often pays for itself in time savings. Ask your builder whether they work with one.
Lessons from Real San Jose Custom Home Projects
Permit timelines on paper and permit timelines in practice are rarely the same thing. These scenarios, drawn from common patterns in San Jose custom home builds, illustrate what actually happens.
The Hillside Lot That Added Four Months
A homeowner purchased a hillside lot in East San Jose, expecting standard permitting timelines. The lot's slope exceeded 20%, triggering a Hillside Development Permit and additional geotechnical requirements. The city required:
- A detailed grading plan with cut-and-fill calculations
- A geology report in addition to the standard soils report
- A drainage study showing post-construction runoff patterns
- A visual impact analysis from neighboring properties
The extra studies and review cycles added four months and roughly $18,000 in consultant fees. The lesson: research your lot's overlay zones before purchasing.
The Tree Removal Complication
San Jose's tree ordinance protects certain species and sizes of trees. One project required removing three heritage oaks to accommodate the building footprint. The tree removal permit process involved public notice, a hearing, and a mitigation plan requiring 12 replacement trees. The tree permits alone took six weeks, but the homeowner had started the process concurrently with plan check — a smart move that prevented a sequential delay.
The Design Review Fast Track
A homeowner building a single-story custom home in a standard residential zone discovered that projects under 20 feet in height and within all setback requirements qualified for administrative design review rather than a full hearing. This streamlined path saved roughly six weeks. If you're weighing your options, a single-story versus two-story custom home decision has real permitting implications beyond just construction costs.
Planning Your Custom Home Building Permits San Jose Timeline
Permits are the long pole in the tent for most San Jose custom home projects. Building your timeline around realistic permit durations — not optimistic ones — prevents cascading schedule problems.
Phase-by-Phase Timeline Breakdown
- Pre-design research and lot analysis: 2–4 weeks. Verify zoning, research overlays, attend pre-application meeting.
- Design and engineering: 10–20 weeks. Architect develops plans; consultants produce reports in parallel.
- Planning entitlements (if required): 4–16 weeks. Varies widely based on review type — administrative versus public hearing.
- Building permit plan check: 8–14 weeks for initial review. Add 3–6 weeks per correction cycle.
- Permit issuance: 1–2 weeks after plan check approval. Pay remaining fees, obtain the physical permit card.
Building in Buffer Time
Add a minimum 20% time buffer to every phase. If plan check is quoted at 10 weeks, plan for 12. If your engineer says three weeks for structural calculations, tell your architect to expect four. These buffers compound — and they're the difference between a realistic schedule and a fantasy one.
Coordinating Permits with Construction Financing
Construction loans have rate lock periods and draw schedules tied to project milestones. If your permit takes longer than expected, your rate lock can expire before you break ground. Discuss permit timeline risks with your lender early. Some lenders offer extended lock periods for custom home projects specifically because of permit uncertainty in high-demand markets like San Jose.
Keeping Permits Valid After Issuance
A San Jose building permit expires if you don't start construction within 180 days of issuance or if work stops for 180 consecutive days. Extensions are possible but not guaranteed. Plan your construction start date and contractor availability before you pull the permit — not after.
Frequently Asked Questions
Final Thoughts
The custom home permit process in San Jose is detailed and demanding, but it's entirely manageable when you understand each step before you take it. Start by scheduling a pre-application meeting with the city, assemble your consultant team early, and build realistic buffers into every phase of your timeline. If you're ready to move forward with your San Jose custom home project, reach out to a builder who has navigated this process many times — having someone in your corner who knows the local system inside and out is the single best investment you can make toward a smooth build.
Related Posts
Open Concept vs Traditional Layout for Custom Homes in San Jose
Explore the pros and cons of open concept vs traditional layouts for custom homes in San Jose to fin...
Read More →
How Foundation Type Affects Custom Home Cost in the Bay Area
Discover how slab, crawl space, and basement foundations impact your custom home building costs in t...
Read More →
Custom Home Builder Red Flags: What Bay Area Homeowners Should Watch For
Spot the warning signs of unreliable custom home builders in the Bay Area—learn key red flags to pro...
Read More →
