Bay Area Building Permit Costs: What to Budget For

Bay area building permit costs displayed on architectural plans spread across a contractor desk
Figure 1 — Permit fee schedules vary dramatically across Bay Area jurisdictions, making upfront research essential for accurate project budgeting.

A standard residential building permit in San Francisco now runs between $3,500 and $15,000 before plan review fees, school impact fees, and technology surcharges even enter the equation. Across the broader Bay Area, bay area building permit costs represent one of the most underestimated line items in residential construction budgets, routinely catching homeowners off guard when invoices arrive from city planning counters. Our team at 9Builders has processed permits in virtually every jurisdiction from San Jose to Oakland, and the variance in fee structures, processing timelines, and supplemental charges is staggering even by California standards. Understanding these costs before breaking ground on a home addition or ADU project prevents the kind of budget overruns that derail timelines and strain contractor relationships.

The permitting landscape in the nine-county Bay Area is fragmented by design, with each municipality setting its own fee schedules based on project valuation, square footage, or a hybrid of both methods. What follows is a comprehensive breakdown of where permit dollars actually go, how to anticipate total costs across project types, and where experienced builders find legitimate savings without compromising compliance.

Where Bay Area Building Permit Costs Apply

Residential vs. Commercial Fee Structures

Bay area building permit costs follow two fundamentally different calculation models depending on project classification. Residential permits in most jurisdictions use a valuation-based formula, typically applying the ICC building valuation data table to determine construction value, then assessing fees as a percentage of that figure. Commercial projects layer additional fees for ADA compliance review, fire department plan check, and environmental impact analysis that residential projects largely avoid. Our experience shows residential permit fees generally land between 1.5% and 3% of total construction value in most Bay Area cities, though outliers exist in both directions.

Jurisdiction-by-Jurisdiction Differences

The fee disparity across Bay Area municipalities is not trivial, and it directly affects project feasibility calculations for homeowners considering Title 24 energy code compliance for home additions. A $200,000 addition in Sunnyvale generates a fundamentally different permit bill than the identical scope in Oakland or Palo Alto, owing to differences in impact fees, plan review multipliers, and technology surcharges that each city applies independently.

Bar chart comparing building permit costs across major Bay Area cities for a typical home addition project
Figure 2 — Comparative permit fee ranges for a $250,000 residential addition across six Bay Area jurisdictions.
CityBase Permit FeePlan ReviewImpact FeesEstimated Total
San Jose$2,800–$4,200$1,800–$2,700$1,500–$6,000$6,100–$12,900
San Francisco$3,500–$6,000$2,200–$3,900$2,000–$8,500$7,700–$18,400
Oakland$2,500–$3,800$1,600–$2,500$1,200–$5,000$5,300–$11,300
Palo Alto$3,200–$5,500$2,000–$3,600$3,000–$9,000$8,200–$18,100
Sunnyvale$2,600–$4,000$1,700–$2,600$1,800–$5,500$6,100–$12,100
Fremont$2,400–$3,600$1,500–$2,300$1,400–$4,800$5,300–$10,700

School impact fees alone account for a significant portion of total permit costs in many South Bay cities, with rates currently set at roughly $4.79 per square foot of new residential construction statewide under Level I assessment, though individual districts can petition for higher Level II and Level III fees based on demonstrated enrollment impacts.

Simple Permits vs. Complex Entitlements

Over-the-Counter Permits

Not every project requires a full plan review cycle, and recognizing which scope items qualify for over-the-counter (OTC) permitting saves both time and money. Most Bay Area building departments issue OTC permits for water heater replacements, reroof projects under a certain square footage threshold, electrical panel upgrades, and like-for-like window replacements. These permits typically cost between $150 and $600 and can be obtained same-day at the planning counter. Our team frequently coordinates OTC permits for mechanical and plumbing sub-scopes within larger addition projects to keep those trade inspections on schedule while the primary structural permit moves through plan check.

Discretionary Review and Entitlement Costs

Projects requiring variance applications, conditional use permits, or design review board approval enter an entirely different cost tier that can dwarf the building permit itself. A variance application in San Francisco currently costs over $7,000 in filing fees alone, before accounting for required environmental review under CEQA or neighborhood notification requirements. Anyone pursuing a second-story addition in neighborhoods with single-story overlay districts should budget $8,000 to $25,000 for the entitlement process alone, spread across planning applications, environmental review, and potentially an appeal hearing. The California Department of Housing and Community Development maintains resources on streamlined approval pathways that bypass some discretionary reviews for qualifying housing projects.

Planning Permit Budgets Across Multi-Phase Projects

Phased Construction Permit Strategy

Large-scale remodels and whole-house renovations often benefit from strategic permit phasing, particularly when the total project scope triggers higher fee tiers or additional review requirements. Our team has found that separating a combined kitchen remodel and addition into two permits sometimes reduces total fees, because each individual permit falls below the valuation threshold where certain impact fees activate. This approach requires careful coordination with the building department, since inspectors need to understand the relationship between phased scopes, but it represents a legitimate budgeting strategy that experienced contractors employ regularly. Homeowners exploring financing options for home additions should factor permit phasing into their draw schedules and loan disbursement timelines.

Fee Escalation and Expiration Risks

Bay Area building departments adjust fee schedules annually, and most increases take effect on July 1 of each fiscal year. Projects submitted before the cutoff date lock in current rates, which creates a tangible financial incentive for early submission even when construction start dates are months away. Permit expiration presents another budget risk that many homeowners overlook entirely. Most jurisdictions expire building permits after 180 days of inactivity, and renewal fees typically run 50% of the original permit cost. A $10,000 permit that expires due to contractor scheduling delays generates a $5,000 renewal charge that comes directly out of the contingency budget, and our team has seen this scenario unfold on projects where financing delays pushed construction starts past the expiration window.

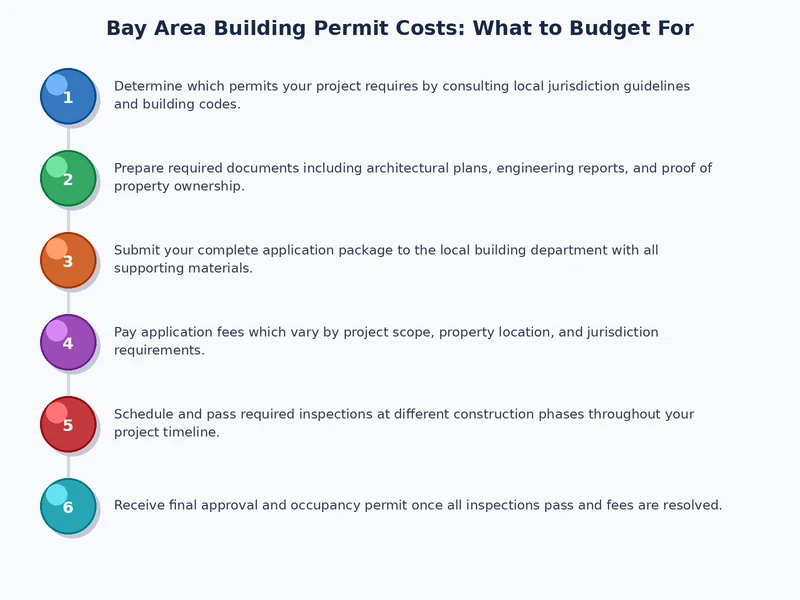

Process diagram showing the stages of Bay Area building permit application from submission through final inspection
Figure 3 — Typical Bay Area residential permit workflow from initial application through certificate of occupancy.

Reducing Permit Expenses Without Cutting Corners

Fee Waivers and ADU Exemptions

California state law (Government Code Section 65852.2) mandates that local agencies waive impact fees for ADUs under 750 square feet, and this exemption has saved our clients tens of thousands of dollars on qualifying projects across Santa Clara and Alameda counties. The fee waiver applies to school fees, park fees, and other development impact fees that would otherwise add $5,000 to $15,000 to a typical ADU permit package. Larger ADUs between 750 and 1,200 square feet receive proportionally reduced impact fees based on the unit's square footage relative to the primary dwelling. Anyone navigating the garage conversion permit process in San Jose should verify which fee exemptions apply to their specific conversion type, since detached conversions and attached conversions sometimes trigger different fee schedules.

Pre-Approved Plan Sets

Several Bay Area jurisdictions maintain libraries of pre-approved ADU plan sets that bypass full plan review, reducing both timeline and fees substantially. San Jose's pre-approved ADU program cuts plan review time from 8–12 weeks down to roughly 2 weeks, and the associated fee reduction reflects the diminished staff review burden. The trade-off is design flexibility, since pre-approved plans allow only minor modifications, but for homeowners whose primary concern is bay area building permit costs rather than bespoke architecture, these programs deliver genuine savings of $2,000 to $5,000 in review fees alone.

Navigating the Approval Process Efficiently

Plan Check Timelines and Resubmittals

Every plan check correction cycle adds cost, both in architect revision fees and in extended project carrying costs for homeowners paying rent elsewhere or servicing construction loans. Our data from over 200 Bay Area residential permits shows that first-pass approval rates hover around 15%, meaning virtually every project requires at least one correction cycle. The average project goes through 2.3 correction rounds before receiving approval, with each round adding 3–6 weeks to the timeline. Reducing correction cycles requires submitting complete, code-compliant plan sets from the outset, which means investing in experienced drafting professionals who understand local amendments to the California Building Code.

Expedited Review Options

Most Bay Area building departments offer expedited plan review for an additional fee, typically 50% to 100% above standard plan review charges. San Jose's expedited residential review currently promises 15 business days versus the standard 6–8 week timeline, at a premium of roughly 65% over base plan review fees. Our team recommends expedited review primarily when construction loan interest costs exceed the expedited fee premium, which happens more often than most people expect on projects above $300,000 in construction value. The math is straightforward: if a construction loan charges $2,500 per month in interest and expedited review saves 6 weeks, the $1,500 expedited premium pays for itself twice over.

Keeping Permits Current and Avoiding Penalties

Extensions and Renewals

Permit extensions require active management, and our project coordinators track expiration dates as rigorously as inspection schedules. Most jurisdictions grant one or two 180-day extensions upon request, provided the applicant demonstrates ongoing construction progress. The extension fee structure varies, with some cities charging a flat administrative fee of $200–$500 and others assessing a percentage-based renewal. After exhausting available extensions, the permit expires and the entire application process restarts at current fee schedules, which may have increased since the original filing date.

Penalties for Unpermitted Work

The financial consequences of unpermitted construction in the Bay Area extend far beyond the retroactive permit fees themselves, which typically carry a penalty multiplier of 2x to 5x the original permit cost. Title companies flag unpermitted work during property sales, and lenders increasingly require permit verification before funding purchases or refinances. Our team has guided numerous homeowners through the retroactive permitting process, and the total cost of legalizing unpermitted work routinely exceeds what proper permits would have cost by a factor of three to five, once engineering reports, code-upgrade requirements, and penalty fees are factored together.

Frequently Asked Questions

A home addition permit in San Jose generally ranges from $6,100 to $12,900 total, including the base building permit, plan review fees, and applicable impact fees. The exact amount depends on the project's construction valuation and square footage, with school impact fees and park fees representing the largest variable components beyond the base permit charge.
California state law requires local agencies to waive development impact fees for ADUs under 750 square feet, which can save $5,000 to $15,000 depending on the jurisdiction. ADUs between 750 and 1,200 square feet receive proportionally reduced impact fees. The base building permit and plan review fees still apply regardless of unit size.
Standard plan review takes 6 to 12 weeks for the initial review cycle in most Bay Area cities, with each correction round adding another 3 to 6 weeks. Most projects require 2 to 3 correction cycles, putting total approval timelines at 3 to 6 months. Expedited review options can reduce the initial review to 10 to 15 business days for an additional fee.
Most Bay Area jurisdictions expire permits after 180 days of inactivity, with renewal fees typically running 50% of the original permit cost. After exhausting available extensions (usually one or two 180-day periods), the permit expires entirely and a new application must be filed at current fee schedules, potentially at higher rates than the original filing.
Retroactive permit fees in the Bay Area carry penalty multipliers of 2x to 5x the original permit cost, and the total expense of legalizing unpermitted work typically exceeds proper permitting costs by three to five times once engineering evaluations, code upgrades, and administrative penalties are included. Unpermitted work also creates complications during property sales, refinancing, and insurance claims.

Key Takeaways

  • Bay area building permit costs for residential additions typically range from $5,300 to $18,400 depending on jurisdiction, with San Francisco and Palo Alto sitting at the high end and East Bay cities generally offering more moderate fee structures.
  • ADU projects under 750 square feet qualify for state-mandated impact fee waivers that can save $5,000 to $15,000, making smaller accessory dwelling units significantly more cost-effective from a permitting standpoint.
  • Every plan check correction cycle adds 3–6 weeks and increases soft costs, so investing in experienced drafting professionals who understand local code amendments pays for itself through reduced resubmittals.
  • Permit expiration and fee escalation represent hidden budget risks that proactive timeline management and early submission strategies can effectively neutralize.

Related Posts

What Happens If You Build Without a Permit in California

What Happens If You Build Without a Permit in California

Building without a permit in California can lead to fines, forced demolition, and issues selling you...

Read More →
Unpermitted ADU in San Jose: How to Legalize It

Unpermitted ADU in San Jose: How to Legalize It

Learn how to legalize your unpermitted ADU in San Jose with a step-by-step guide covering permits, i...

Read More →
