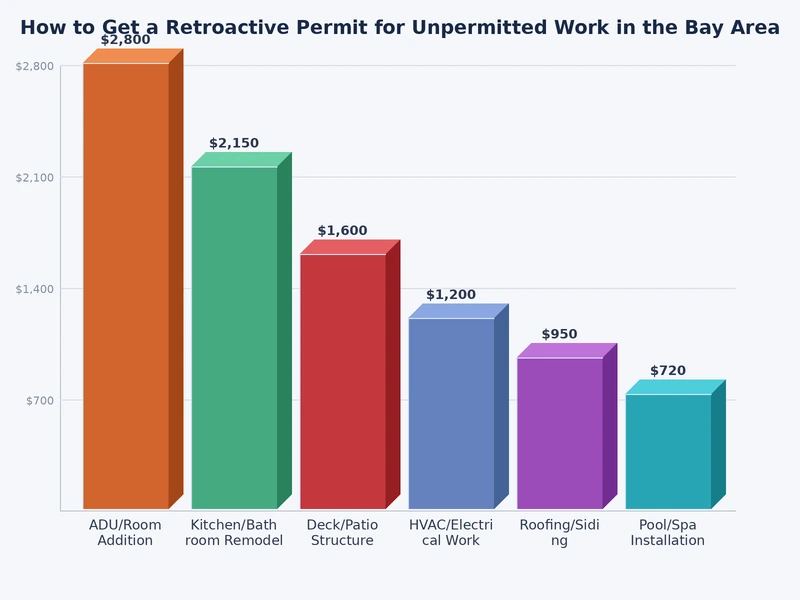

How to Get a Retroactive Permit for Unpermitted Work in the Bay Area
You can get a retroactive building permit in California — and in most Bay Area cities, it's a straightforward process if you know how to approach it. Unpermitted work doesn't have to follow you forever. Whether you're trying to sell, refinance, or just sleep at night knowing your addition is code-compliant, the legalization pathway exists. Our team at 9Builders advisory walks homeowners through exactly this process regularly.
Unpermitted work is more common than you think across the Bay Area. Decades of owner-built additions, DIY garage conversions, and contractor shortcuts have left hundreds of thousands of homes with work that was never inspected. The good news: building departments aren't looking to punish you. They want the work brought up to code — full stop.
Here's what you need to know to get through the process efficiently, without spending more than necessary on demolition, re-work, or delays.
What You Can Resolve Right Away
Not all unpermitted work requires months of bureaucracy. Some situations have genuinely fast paths to resolution — start here before assuming the worst.
Minor Single-Trade Work
If the unpermitted work is limited to a few outlets, a bathroom exhaust fan, or a hose bib, many building departments let you pull a simple permit, schedule one inspection, and close it out within a few weeks. No demolition required — just access for the inspector.
- Single-trade permits (electrical, plumbing, mechanical) are typically over-the-counter in San Jose and Santa Clara
- Inspectors can often verify in-place without opening walls if the work is visible or accessible
- Fees are usually under $500 for limited-scope work
Work That Was Never Permit-Required
Know what's actually unpermitted before you panic. California Building Code exempts a lot of work from permits entirely — painting, flooring, cabinet replacement, and most landscaping. You don't owe a retroactive permit for work that never needed one. Check your jurisdiction's exemption list before filing anything. Familiarizing yourself with the most common code violations in San Jose home remodels helps you quickly separate real permit issues from cosmetic work that inspectors won't even flag.
Quick check: If the work doesn't affect structural elements, electrical panels, gas lines, or the building envelope, there's a real chance it was never permit-required to begin with.
Recent Garage Conversions Under Amnesty Programs
California's ADU laws significantly loosened requirements for garage-to-living-space conversions. If your unpermitted conversion is relatively recent, corrections often involve just egress windows, smoke detectors, and insulation upgrades. Several Bay Area cities now run streamlined ADU amnesty programs specifically for this work type — reduced fees, simplified inspections, no penalty multipliers.
The Real Trade-offs of Legalizing Unpermitted Work
Pursuing a retroactive building permit in California isn't always the obvious right call. You need to understand what you're trading before committing.
| Factor | Pursuing Retroactive Permit | Leaving It Unpermitted |
|---|---|---|
| Resale value | Full value captured; buyers have no leverage | Buyers demand 10–25% price reduction or walk |
| Refinancing / HELOC | Legalized sqft may count toward appraisal | Lender may require correction before funding |
| Property tax | Assessor may adjust upward at legalization | Risk of back-assessment if discovered |
| Insurance claims | Covered at full replacement value | Insurer may deny or reduce claims for unpermitted areas |
| Code compliance risk | Resolved — clean title history | Neighbor complaint or permit pull forces correction on their timeline |
| Upfront cost | $2,000–$20,000+ depending on scope and corrections | $0 now, potentially much more under forced remediation |
The math usually favors legalization if you're within 3–5 years of selling or refinancing. If you're staying put for 20 years and the work is genuinely safe, the calculus is murkier — but neighbor complaints and permit pulls by future contractors can force your hand at the worst possible time.
Pro tip: If you're selling, disclose the unpermitted work upfront. Buyers who discover it themselves during inspection negotiate far harder than buyers who knew going in.
Step-by-Step Game Plan for the Retroactive Permit Process
This is the actual workflow. Don't skip steps — shortcuts here cost more time, not less.
Step 1: Document Everything First
- Photograph all accessible structural, electrical, plumbing, and mechanical elements
- Measure and sketch the unpermitted space — floor plan, ceiling height, wall locations
- Gather any existing plans, contracts, or photos from when the work was done
- Pull your property's permit history from the city's online portal — know what IS permitted before your pre-app meeting
Step 2: Pre-Application Meeting with the Building Department
This is your most valuable hour. Most Bay Area cities offer free or low-cost pre-application meetings. Bring your documentation and ask directly: what's the legalization pathway, what inspections are required, and what code standard applies. San Jose, Santa Clara, and most Peninsula cities apply current code to retroactive permits — not the code from when the work was done. This matters enormously for electrical panels, seismic requirements, and energy efficiency.
Step 3: Hire a Licensed Contractor or Architect
You can pull the permit yourself as an owner-builder in California, but for retroactive work involving anything structural or multi-trade, hire someone who knows what the inspector will look for. The permit application needs accurate as-built drawings, and submitting incorrect plans creates costly revisions. Get the scope right before submitting — not after.
Step 4: Submit Plans and Permit Application
- Projects over 120 sq ft or involving structural work typically require stamped engineering drawings
- Submit via the city's online portal — San Jose uses eTRAKiT; Santa Clara has its own system
- Expect 4–12 week plan check for complex projects; over-the-counter same-day for simple trades
- Budget for plan check fees: typically 65–80% of the permit fee, credited at permit issuance
Step 5: Inspections and Corrections
The inspector will tell you what needs to be opened for verification. Expect to expose at least some in-wall work on any structural or multi-trade project. Use the Bay Area building inspection checklist to prep before each visit — showing up organized signals professionalism and often leads to faster sign-off. When you get a correction notice, fix it fast. Every week of delay extends your timeline and adds carrying cost.
Step 6: Final Sign-Off and Certificate of Occupancy
Once all inspection cards are signed, the city issues final permit sign-off. For any converted space used as habitable area — bedroom, office, ADU — you'll also need a Certificate of Occupancy. Keep all paperwork permanently. Title companies and lenders will ask for it at every future transaction.
Real Scenarios Bay Area Homeowners Actually Face
Theory is useful. Real situations are more useful. Here are the four scenarios we see most often.
The Unpermitted Garage Conversion
This is the most common situation in San Jose, Sunnyvale, and Santa Clara. A previous owner converted the garage to a bedroom or rental unit without permits, and now you're selling. The typical process: pull the permit, get as-built drawings, schedule inspections for egress, electrical, insulation, and smoke/CO detection. Understand the garage conversion building codes and setbacks in San Jose before assuming everything is fixable — setback violations are a separate, bigger problem than permit violations. If the conversion is being used as an ADU, the retroactive permit path aligns closely with Santa Clara County ADU permit requirements, and amnesty programs may apply.
The Unpermitted Room Addition
Additions without permits are the highest-risk category. They often involve foundation work, structural connections, and roofline changes — all of which inspectors scrutinize hard. Expect to open walls, expose the foundation connection, and possibly upgrade the electrical panel. Budget $8,000–$25,000 for corrections on a 200–400 sq ft addition, depending on condition and how far the work deviates from current code.
The Red-Tagged Property
If your property already has a red tag, the retroactive permit process is mandatory — not optional. The process for removing a red tag in San Jose runs through the same building department workflow, but with stricter timelines and active enforcement. Don't ignore red tags. They don't expire. They follow the property through every future sale.
Warning: A red tag on an unpermitted ADU or converted space can trigger stop-use orders affecting your entire property — not just the flagged area. Get professional guidance before proceeding on your own.
The Inherited Unpermitted Work
You bought the house, then discovered the previous owner's addition was never permitted. You still own the liability. California law is clear: unpermitted work transfers with the property. The silver lining is that building departments generally treat new owners more leniently than the original unpermitted builder — but you still have to fix it on the current code standard.
Best Practices for Navigating Retroactive Permits
These are the moves that separate homeowners who get through the process smoothly from those who spend twice as long and twice as much.
Be Transparent with the Building Department
Don't minimize the scope. Building departments deal with unpermitted work daily — they're not surprised and they're not out to punish you. Trying to obscure the work in your application gets flagged during inspection and creates an adversarial relationship you don't want. Full disclosure upfront is faster and cheaper.
Fix Obvious Deficiencies Before Inspection
- Have a licensed contractor walk the space before submitting — they'll catch corrections the inspector will flag
- Address missing smoke detectors, open electrical boxes, and visible violations before the inspector arrives
- For any work that needs a structural engineer, get the report before submitting — it speeds plan check significantly
Understand the Penalty Fee Structure
San Jose charges up to 4x the standard permit fee for after-the-fact permits. Santa Clara charges a flat penalty. Fremont, Oakland, and most other Bay Area cities have their own multipliers. Factor these into your budget before starting — surprises at the permit counter stall projects and strain contractor relationships.
According to the California Department of Consumer Affairs, homeowners who work with licensed contractors on retroactive permits have significantly higher first-attempt approval rates and fewer costly re-submissions.
Document the Corrected Work
Photograph everything before closing up walls. If you ever sell, refinance, or face a future inspection issue, a visual record of your corrected work is real insurance. Store photos alongside your permit paperwork — permanently, not in a drawer you'll lose track of.
When a Retroactive Building Permit in California Is Your Best Move
Certain triggers make the retroactive permit path clearly the right call. Don't wait for the city or a buyer to force it.
You're Selling Within Five Years
Unpermitted work is a deal-killer for a significant portion of Bay Area buyers. Even buyers who say they'll accept it change their minds when their lender or agent pushes back. Legalizing before listing removes negotiating leverage from buyers and lets you price on full square footage — not a discounted "as-is" number.
You're Renting Out a Converted Space
Renting out an unpermitted ADU, garage conversion, or basement unit creates serious liability. If a tenant is injured in a space that was never inspected, your insurance may not cover it. Getting that space properly permitted and inspected is non-negotiable if you're collecting rent from it. Review the full permitting picture in our guide on garage to ADU conversion in San Jose before signing any lease.
You're Planning Additional Work
If you want to remodel, expand, or pull any new permit on a property with existing unpermitted additions, the building department will often require you to legalize the prior work first. Get ahead of it before your next project starts — not during it, when timelines and budgets are already committed.
You Have Structural Safety Concerns
If the unpermitted work touches the foundation, shear walls, or roof structure, get it inspected regardless of permit status. Bay Area seismic risk makes this non-optional. A structural engineer can evaluate the work, document compliance, and their report becomes the backbone of your retroactive permit application.
Frequently Asked Questions
The cheapest retroactive permit you'll ever pull is the one you pursue proactively — before the city, a buyer, or a bad inspection forces your hand.
Related Posts
What Triggers a Building Code Inspection in California
Discover what triggers a building code inspection in California, from new construction and major ren...
Read More →
Title 24 Energy Compliance for Bay Area Home Additions
Meet Title 24 energy compliance requirements for your Bay Area home addition with expert guidance on...
Read More →
Owner-Builder Permit in California: Rules and Risks to Know
Learn California's owner-builder permit rules, eligibility requirements, legal risks, and what to kn...
Read More →
