What Triggers a Building Code Inspection in California

Building code inspections in California are triggered by permit applications, active construction, and complaints about work done without authorization. Knowing what triggers building code inspection is the single most effective way to keep a project on schedule — and out of legal trouble. Property owners who ignore inspection requirements often face stop-work orders, fines, and forced demolition of completed work. For a deeper look at avoiding those outcomes, the 9Builders advisory service walks Bay Area homeowners through compliance before a single permit is filed.

building code inspection checklist and permit documents for California construction project
Figure 1 — A permit application and inspection checklist are the starting point for any compliant California construction project.

California operates under the California Building Standards Code (Title 24), a set of regulations adopted statewide and locally amended by cities and counties. Every jurisdiction — from San Jose to Oakland — enforces these rules through mandatory inspections tied to permitted work. The inspection is not optional. It is a legal checkpoint built into the permit process.

Inspections happen at predictable moments, but also unexpectedly. A neighbor's complaint, an insurance claim, or a property sale can all bring an inspector to the door. The sections below break down each scenario in detail.

bar chart showing the most common triggers for building code inspections in California by category
Figure 2 — Common triggers for building code inspections in California, ranked by frequency reported in Bay Area jurisdictions.

Primary Triggers: What Sets an Inspection in Motion

The most straightforward answer to what triggers building code inspection is this: a permit. Every time a homeowner or contractor pulls a permit in California, the issuing jurisdiction schedules one or more inspections as a condition of that permit. No permit, no scheduled inspection — but that is not the same as no consequences.

Permit Issuance and Construction Milestones

California's Health and Safety Code requires inspections at defined stages of construction. These are not suggestions. When a foundation is poured, an inspector must sign off before framing begins. When framing is complete, another inspector checks structural members, insulation, and rough electrical before drywall is installed. Each inspection milestone acts as a legal gate — work cannot legally proceed to the next phase without approval.

The types of inspections attached to a permit depend on the scope of work. A simple electrical panel upgrade triggers an electrical inspection. A full bathroom addition triggers foundation, framing, plumbing, electrical, insulation, and final inspections. The permit application itself identifies which checkpoints apply.

Pro tip: Request the full inspection checklist from the building department at permit issuance — not after framing is done. Surprises at the rough inspection stage are among the most expensive delays on a project.

Complaints and Code Enforcement Visits

Permits are not the only trigger. Neighbor complaints are a common and often overlooked source of inspections. Any resident can file a complaint with a city's code enforcement division. Officers then conduct a site visit. If unpermitted work is discovered, the property owner faces a compliance order — and typically must either obtain a retroactive permit or remove the work entirely.

Homeowners dealing with this situation can find a detailed breakdown of the process in How to Get a Retroactive Permit for Unpermitted Work in the Bay Area. The short version: retroactive permits are possible but costly, and they still require a passing inspection.

Other non-permit triggers include insurance company site visits after a claim, bank inspections during a refinance or home equity loan, and municipal sweeps of properties flagged during permit record audits.

Inspections Across the Construction Timeline

Most permitted projects in California involve multiple inspections spread across the project's life. The sequence follows the logic of construction: inspectors need to see work before it is covered up.

Scheduled Inspections at Each Phase

Residential construction typically follows this inspection sequence:

Inspection Type When It Occurs What Inspector Reviews Triggered By
Foundation / Slab Before concrete pour Rebar, forms, vapor barrier Building permit
Rough Framing After framing, before drywall Structural members, shear walls Building permit
Rough Electrical Before insulation/drywall Wiring, panel connections Electrical permit
Rough Plumbing Before walls are closed Drain, supply, venting lines Plumbing permit
Insulation Before drywall R-values, Title 24 compliance Building / energy permit
Final Project completion All systems, egress, smoke alarms All permits

Each inspection is requested by the permit holder — not automatically scheduled. The contractor or owner must call or submit an online request, typically 24 to 48 hours before the desired inspection window.

Final Inspection and Certificate of Occupancy

The final inspection is the most consequential checkpoint. A passed final releases the Certificate of Occupancy (CO) — the document that legally authorizes a space to be occupied or used. Without a CO, a new ADU cannot be rented, a converted garage cannot serve as living space, and a newly built room addition technically cannot be used.

Bay Area jurisdictions have tightened final inspection requirements in recent years, particularly around energy compliance. Insulation values, window performance, and HVAC efficiency are all checked against the Title 24 standards. Homeowners planning additions should review Title 24 Energy Compliance for Bay Area Home Additions before scheduling that final.

Project Types That Almost Always Require Inspection

Certain project categories generate inspections at a higher rate than others. Understanding these scenarios helps owners prepare early.

ADUs and Garage Conversions

Accessory dwelling units (ADUs) — secondary housing units on a residential lot — are among the most heavily inspected project types in California. State law mandates specific habitability standards for ADUs, and local jurisdictions add their own requirements on top. Every ADU project triggers a minimum of four inspections: foundation or slab, rough framing, rough MEP (mechanical, electrical, plumbing), and final.

Garage conversions follow the same path. Converting an attached or detached garage into livable space requires a change-of-occupancy permit, which triggers a full inspection sequence. The building must meet residential fire, egress, ventilation, and insulation standards. Owners pursuing this path should consult the Owner-Builder Permit in California: Rules and Risks to Know guide before deciding to manage the project without a licensed contractor.

Warning: Listing an unpermitted ADU or garage conversion as a bedroom on a rental listing is a code enforcement red flag — and one of the most common triggers for a surprise inspection visit.

Remodels and Room Additions

Kitchen and bathroom remodels that involve moving walls, adding circuits, or relocating plumbing lines all require permits — and therefore inspections. A cosmetic renovation (new tile, paint, cabinet hardware) generally does not. The determining factor is whether the work affects structural, electrical, plumbing, or mechanical systems.

Room additions always require permits. They involve foundation work, new framing, and new MEP rough-in — all of which must be inspected before concealment. A 200-square-foot addition to a San Jose home can easily involve six separate inspection visits before the final is scheduled.

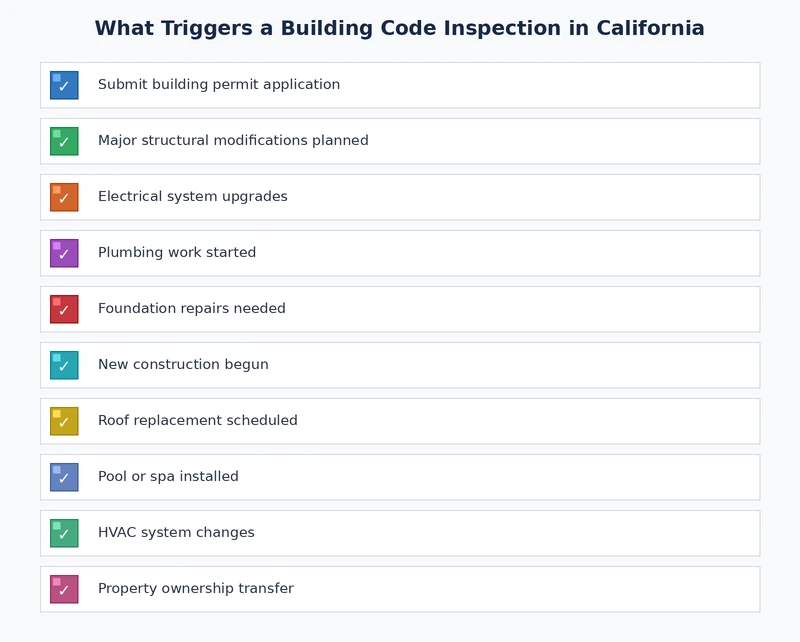

checklist of building code inspection triggers and project phases for California homeowners
Figure 3 — Inspection trigger checklist covering permit types, project phases, and common non-permit triggers for California residential construction.

Inspection Fees and the Cost of Non-Compliance

Inspections are not free. Every jurisdiction in California charges fees attached to the permit. Those fees cover the cost of plan review and field inspections. Owners who skip the permit process — intentionally or not — pay far more in the end.

How Inspection Fees Are Structured

Most Bay Area cities bundle inspection fees into the overall permit fee, calculated as a percentage of the project's estimated construction value. A $100,000 kitchen remodel in San Jose might carry a total permit-and-inspection fee of $2,500 to $4,500 depending on scope. That figure covers all scheduled inspections in the permit cycle. Understanding the permit timeline matters as much as the cost — see How Long Does It Take to Get a Building Permit in San Jose for current processing timelines by project type.

Re-inspection Fees and Project Delays

A failed inspection generates a re-inspection fee. In San Jose, re-inspection fees currently run $200 to $350 per visit. More damaging than the fee is the delay. A failed rough framing inspection can stall a project for two to four weeks while corrections are made and the next inspection slot is scheduled. Failed inspections on fast-moving projects are among the most expensive mistakes a homeowner can make.

Properties where unpermitted work is discovered face a different cost structure entirely. Code enforcement cases require the owner to either legalize the work retroactively — with full permit and inspection compliance — or demolish it. In either case, the cost significantly exceeds what a permit would have cost at the outset.

Key Takeaways

  • Building code inspections in California are triggered primarily by permit applications, with mandatory checkpoints at foundation, rough framing, MEP rough-in, and final stages.
  • Non-permit triggers — including neighbor complaints, insurance visits, and property sales — can bring an inspector to a site without any active construction in progress.
  • ADUs, garage conversions, and room additions consistently generate the highest inspection volume due to their structural, electrical, and plumbing complexity.
  • Skipping permits to avoid inspections almost always costs more in re-inspection fees, code enforcement penalties, and potential demolition orders than the original permit would have.

Related Posts

Title 24 Energy Compliance for Bay Area Home Additions

Title 24 Energy Compliance for Bay Area Home Additions

Meet Title 24 energy compliance requirements for your Bay Area home addition with expert guidance on...

Read More →
How to Get a Retroactive Permit for Unpermitted Work in the Bay Area

How to Get a Retroactive Permit for Unpermitted Work in the Bay Area

Unpermitted work in the Bay Area? Learn how to obtain a retroactive permit—step-by-step—to legalize ...

Read More →
Owner-Builder Permit in California: Rules and Risks to Know

Owner-Builder Permit in California: Rules and Risks to Know
