Garage to ADU Conversion in San Jose: Complete Guide

Is an attached garage really the best use of prime Bay Area square footage, or could it be generating rental income and adding lasting property value instead? Most homeowners in Santa Clara County are discovering that the answer is clearly the latter — and a garage to ADU conversion in San Jose has become one of the most strategically sound investments available in today's real estate market. Our team has helped dozens of Bay Area families unlock this potential, and the outcomes consistently exceed expectations.

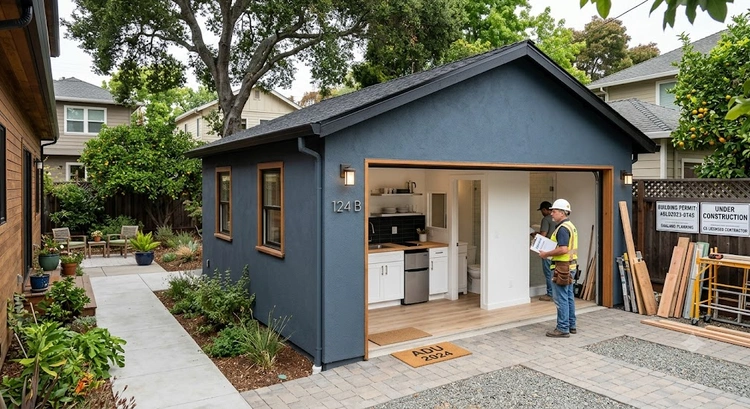

Completed garage to ADU conversion in San Jose with modern exterior finish and private entrance
Figure 1 — A finished garage ADU in San Jose with a private entrance and updated exterior facade.

Converting a garage into an accessory dwelling unit isn't a weekend project — it's a permitted construction process involving structural work, mechanical systems, and city approvals. That said, garages already come with footprints, roofs, and foundations, which gives every conversion a significant head start over building new from the ground up. Our experience consistently shows that garage conversions deliver the fastest timelines and most competitive cost-per-square-foot of any ADU type in the Bay Area.

San Jose's ADU regulations have evolved substantially in recent years, making conversions more accessible than ever before, and California law has eliminated owner-occupancy requirements statewide. For a thorough breakdown of what the full investment looks like, our guide on how much a garage conversion costs in San Jose is required reading before breaking ground on any project.

Bar chart comparing ADU types by average cost per square foot in San Jose
Figure 2 — Average cost per square foot comparison across ADU types in San Jose.

San Jose's ADU Landscape: Why Garages Win

The Regulatory Shift That Changed Everything

California's state ADU laws have dramatically simplified what cities like San Jose can require from homeowners pursuing conversions. San Jose now processes garage ADU permits under streamlined ministerial approval for units under 850 square feet. That means no discretionary review, no public hearings, and no design challenges from neighbors. Our team has watched permit timelines shrink from six months to as few as six weeks for qualifying projects, and that speed advantage compounds into real savings when subcontractors and financing are already lined up.

  • No owner-occupancy requirement — eliminated by California law statewide
  • Reduced or waived impact fees for conversions under 750 sq ft
  • San Jose allows up to three units on a single-family lot (primary + ADU + JADU)
  • Existing garage structures are exempt from current setback requirements during conversion

Why the Market Rewards Garage ADUs

San Jose's rental vacancy rate consistently hovers below 4%, creating persistent demand for the kind of private, self-contained living spaces that a converted garage provides best. A well-executed garage ADU typically adds $150,000–$250,000 in appraised value while generating $2,000–$3,200 per month in rental income depending on size and location. Our clients who convert attached garages for rental purposes typically recover their construction costs within five to eight years through rent alone, with property appreciation layered on top as a separate return.

Benefits and Real Limitations of Garage Conversions

The Strong Case for Converting

Pro Tip: Attached garages share a wall with the main house, which means existing electrical panels and plumbing lines are much closer — this proximity alone can reduce conversion costs by $8,000–$15,000 compared to a fully detached structure.
  • Lower starting cost — existing foundation, roof, and framing cut the build budget significantly
  • Faster permitting due to ministerial review for units under 850 square feet in San Jose
  • No new utility trenching required for attached garages with proximity to main house systems
  • Rental income qualifies as ordinary income with deductible depreciation benefits
  • Adds measurable resale value immediately upon certificate of occupancy

Honest Limitations Most People Don't Anticipate

  • Loss of enclosed parking may affect resale perception for certain buyer profiles in the future
  • Attached conversions require sound-proofing between shared walls, which adds both labor and material cost
  • Slab-on-grade foundations require a floor insulation system — the most frequently under-budgeted line item
  • HVAC must be fully independent from the main house to meet California mechanical code requirements
  • Detached conversions sometimes trigger full utility service lateral upgrades from the street

For homeowners weighing a detached structure specifically, our post on converting a detached garage into a rental unit in San Jose covers the unique permitting and structural considerations in detail.

How a Garage to ADU Conversion in San Jose Works

Phase 1: Pre-Construction Planning

  1. Site assessment — Our team evaluates ceiling height (7 ft minimum required), foundation condition, utility locations, and egress options before any drawings are produced
  2. Architectural drawings — A licensed architect produces floor plans, elevations, and Title 24 energy compliance documents specific to the project
  3. Permit submittal — Documents go to San Jose's Development Services Department; ministerial review typically takes 4–10 weeks depending on completeness of the application
  4. Contractor finalization — Our team recommends locking in subcontractors while permits process, since skilled trades in the Bay Area book out 6–10 weeks in advance

Phase 2: Structural and Envelope Work

  1. Garage door opening framed in with an insulated wall assembly, new window, and a separate entry door meeting egress requirements
  2. Ceiling raised or modified to meet habitable-space height requirements when existing framing falls short
  3. Spray foam or rigid insulation applied to slab, walls, and roof deck to achieve California Title 24 compliance
  4. New exterior cladding or stucco applied and matched to the existing main residence for visual cohesion

Phase 3: MEP and Finish Work

  1. Dedicated 100-amp electrical sub-panel installed to serve all ADU loads independently
  2. Plumbing rough-in for kitchen sink, bathroom fixtures, and on-demand water heater
  3. Mini-split heat pump system installed — the most efficient and code-compliant HVAC option for ADU-scale spaces
  4. Energy recovery ventilator (ERV) added to satisfy California mechanical code ventilation requirements
  5. Insulated drywall, LVP or tile flooring, cabinetry, and finish trim installed; final inspections and certificate of occupancy issued
Step-by-step process diagram for garage to ADU conversion in San Jose from permit to move-in
Figure 3 — The five-phase process from planning through certificate of occupancy for a San Jose garage ADU.

Key Materials and Systems in a Garage ADU Build

Insulation and Building Envelope

Floor insulation is the single most overlooked element in a garage conversion, and skipping it produces a cold, uncomfortable living space that no tenant will tolerate long-term. Our team defaults to a 2-inch XPS rigid board under sleepers with a plywood subfloor on top, or spray foam directly to the slab when ceiling height is too tight to accommodate a raised floor system. Getting this right at rough-in prevents thermal complaints and moisture issues for the life of the ADU.

Warning: R-13 fiberglass batts alone won't pass California's Title 24 for garage conversion walls — the code requires continuous insulation on above-grade mass walls, and batts without rigid exterior foam will fail inspection.
  • Walls: 2×6 framing with R-20 batts + R-5 rigid exterior continuous insulation
  • Slab: 2" XPS foam (R-10) under sleeper system, or closed-cell spray foam direct-to-slab
  • Roof/ceiling: R-38 blown-in cellulose or spray foam at rafter level for compliance
  • Windows: Dual-pane low-E vinyl — required in every California climate zone and aesthetically clean

Mechanical Systems

  • Mini-split heat pump — the definitive choice for ADUs; no ductwork, zoned control, qualifies for utility rebates from PG&E and Silicon Valley Clean Energy
  • On-demand tankless water heater — space-efficient and dramatically more cost-effective than tank units at ADU scale
  • ERV (energy recovery ventilator) — required in airtight ADU envelopes under California CMC Section 402
  • LED lighting throughout — required under Title 24 JA8 fixture standards and essentially universal practice at this point

Garage ADU vs. Other ADU Types: A Side-by-Side Look

Most people researching ADU options eventually need a direct comparison to make a confident decision. Our team's position is clear: attached garage conversions deliver the best return relative to cost and timeline for the majority of San Jose homeowners. The table below puts the numbers in context.

ADU Type Avg. Cost (San Jose) Permit Timeline Complexity Best For
Attached Garage Conversion$120,000–$180,0006–12 weeksModerateRental income, in-law suite
Detached Garage Conversion$140,000–$210,0008–16 weeksModerate–HighPrivate rental, home office
New Detached ADU$220,000–$380,00012–24 weeksHighMaximum income, custom layout
Interior/Basement ADU$130,000–$200,0008–14 weeksModerate–HighMulti-gen living, limited egress
JADU (Junior ADU)$40,000–$90,0003–6 weeksLowLow-budget shared-bathroom rental
Insight: JADUs are the fastest and cheapest path to a permitted rental unit, but they require a shared bathroom with the main house — most renters and most landlords find that arrangement unsustainable past the first lease cycle.

Long-Term Care for a Converted Garage ADU

Routine Maintenance Priorities

A garage ADU that was once an uninsulated storage space now functions as a fully conditioned residential unit, and its maintenance needs shift entirely to reflect that. Our comprehensive ADU maintenance guide for Bay Area homeowners goes deeper on every system, but the essentials break down cleanly into quarterly, annual, and five-year cycles that any property owner can follow.

  • Quarterly: Mini-split filter cleaning, smoke and CO detector testing, plumbing P-trap water refill if the ADU sits vacant
  • Annual: Full HVAC service, roof inspection, caulking check at all penetrations and window perimeters, tankless water heater flush
  • Five-year: Exterior paint or stucco inspection, water heater anode rod replacement, re-seal at any exposed concrete slab edges

Common Issues Specific to Converted Garages

  • Moisture intrusion at the former garage door header — often the first failure point when flashing was under-specified at rough-in
  • Slab cold spots beneath flooring, typically indicating incomplete XPS coverage under the sleeper system during construction
  • Mini-split refrigerant leaks at flare connections improperly torqued by installers — a licensed HVAC tech should verify connections at the first annual service visit
  • Settling at the former driveway apron creating a trip hazard at the new ADU entry — address early with concrete leveling compound or pavers before a tenant flags it

Frequently Asked Questions

Most garage ADU conversions in San Jose take 4–7 months from project start to certificate of occupancy. Permit review runs 6–12 weeks under ministerial approval, and active construction typically takes 8–14 weeks depending on scope and subcontractor scheduling. Attached garage conversions tend to finish faster than detached structures because utility connections are shorter.
Yes — San Jose requires all ADUs, including garage conversions, to have an exterior entrance that is independent from the primary dwelling's main entry. For attached garages, this typically means a new door opening cut into an available exterior wall, sized and positioned to meet California Building Code egress dimensions.
California Building Code requires a minimum finished ceiling height of 7 feet in all habitable rooms. Many single-car garages with standard 8-foot roof plates meet this requirement after drywall and ceiling finishes are installed. Homes with lower roof trusses may require structural modifications or a dropped roof assembly on part of the unit, which adds cost.
Yes. Once San Jose issues a certificate of occupancy, the unit is legally habitable and can be rented immediately. California law no longer requires the property owner to live on-site, so renting both the primary residence and the ADU simultaneously is fully permitted statewide.
San Jose waives development impact fees for ADUs under 750 square feet. Units between 750 and 850 square feet may incur partial fees depending on the specific fee schedule in effect at permit submittal. ADUs over 850 square feet are subject to full impact fee schedules, which can add $15,000–$35,000 to total project cost.
No — California law explicitly prohibits cities from requiring replacement parking when a garage is converted to an ADU. San Jose cannot mandate that homeowners build a new garage, carport, or off-street parking space to compensate for the converted enclosed parking. This is one of the most favorable provisions in the state's ADU framework.
For attached garages, a dedicated 100-amp sub-panel and plumbing branch connections from the existing main house lines are standard. Detached garages often require a new electrical service lateral from the street and sometimes a separate water meter, adding $8,000–$20,000 to total costs depending on distance from the street and existing service capacity.

Key Takeaways

  • A garage to ADU conversion in San Jose costs $120,000–$180,000 for attached structures and typically adds $150,000–$250,000 in appraised property value with strong ongoing rental income.
  • San Jose's streamlined ministerial permitting for ADUs under 850 square feet has cut approval timelines to as few as six weeks, making garage conversions faster to start than any other ADU type.
  • Floor insulation, a dedicated mini-split heat pump, and a 100-amp sub-panel are non-negotiable for a code-compliant, tenant-ready garage ADU — cutting corners on any of these creates long-term problems.
  • California law eliminates replacement parking requirements and owner-occupancy mandates, so a converted garage ADU can be legally rented immediately upon receiving a certificate of occupancy.

Related Posts

Garage Conversion Building Codes and Setback Rules in San Jose

Garage Conversion Building Codes and Setback Rules in San Jose

Navigate San Jose's garage conversion building codes and setback rules to ensure your ADU project me...

Read More →
Converting Your Garage into a Home Office in San Jose

Converting Your Garage into a Home Office in San Jose

Transform your San Jose garage into a productive home office with expert tips on permits, insulation...

Read More →
Garage Conversion Ventilation and HVAC Solutions for Bay Area Climate

Garage Conversion Ventilation and HVAC Solutions for Bay Area Climate

Upgrade your Bay Area garage conversion with the right ventilation and HVAC solutions to stay comfor...
