Fixed Price vs Time and Materials Contracts for Bay Area Remodels

When a client came to our team after a kitchen remodel ran $20,000 over the original bid, the first thing we examined wasn't the materials list or the labor hours — it was the contract. Understanding the difference between a fixed price vs time and materials contract is one of the most consequential decisions in any Bay Area remodel, and most homeowners make it without fully grasping the trade-offs involved. Our team at 9Builders has guided projects across San Jose, Oakland, Fremont, and the wider region, and the contract structure almost always determines whether a project closes smoothly or ends in a billing dispute. Our home remodeling services begin with helping clients understand this choice before any permits are pulled or work begins.

contractor reviewing fixed price vs time and materials contract documents for a Bay Area home remodel
Figure 1 — Choosing the right contract structure is one of the first decisions in any well-managed Bay Area remodel.

A fixed price contract (sometimes called a lump sum or stipulated sum contract) locks in a single agreed-upon total before work begins, giving homeowners a predictable number to plan around. A time and materials contract (T&M) bills for actual labor hours plus material costs as the project progresses, with the final number depending on how the work unfolds. Both structures are widely used in California residential construction, and both work well when matched to the right project type.

Before exploring the specifics of each contract type, it helps to understand how contractors build their estimates in the first place — our post on how to read a contractor's bid walks through the line items most people overlook, which provides useful context for evaluating any proposal.

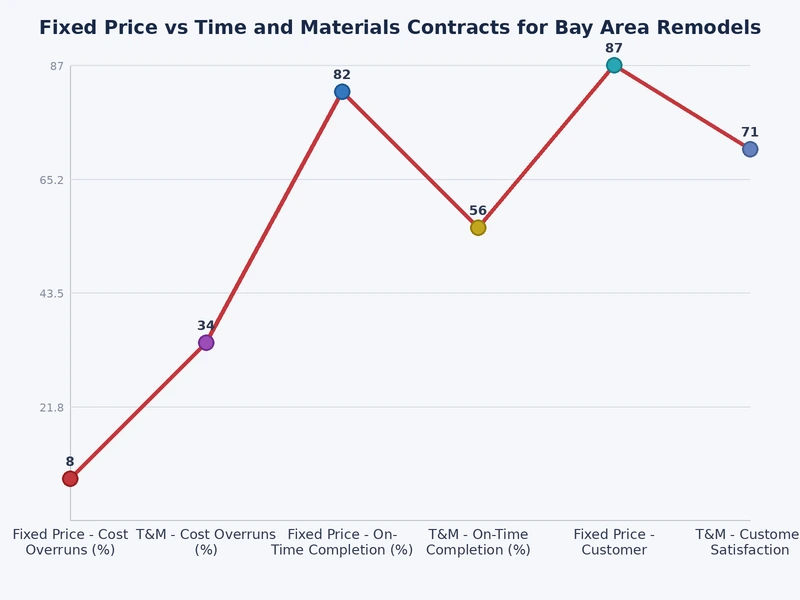

bar chart comparing fixed price vs time and materials contract cost outcomes for Bay Area remodels
Figure 2 — Cost outcome patterns differ significantly between fixed price and T&M contracts depending on project scope clarity.

Getting a Head Start: Choosing the Right Contract Early

When a Fixed Price Contract Tends to Work Best

Fixed price contracts perform most reliably when the project scope is fully defined before bidding begins, materials are already selected, and the contractor has enough information to price risk accurately. Kitchen and bathroom remodels with complete architectural drawings, a finalized materials list, and a clear timeline are strong candidates for this structure. Our team finds that a well-written fixed price agreement protects homeowners in projects where surprises are genuinely unlikely.

  • Full architectural drawings are complete before any bids are requested
  • Materials such as tile, fixtures, and cabinetry are already specified by brand and model
  • The site has been inspected and no hidden structural or mechanical conditions are expected
  • The homeowner needs a firm number for financing or loan approval purposes

When T&M Tends to Serve the Project Better

Time and materials contracts become the practical choice when the full scope only reveals itself after walls open or foundations are exposed. Older Bay Area homes frequently hide outdated knob-and-tube wiring, galvanized plumbing pipes, or unexpected structural problems — conditions that make it impossible for any contractor to offer a reliable fixed number upfront. Our experience shows that a T&M agreement paired with a not-to-exceed cap can actually reduce conflict in projects with genuine unknowns, because both parties share an accurate picture of costs as work progresses.

What Most People Get Wrong About These Contracts

The Idea That Fixed Price Always Means Lower Cost

One of the most persistent beliefs our team encounters is that fixed price contracts automatically produce a lower final bill. In practice, experienced contractors build contingency buffers into lump sum bids to protect themselves against unpredictable conditions. If the project runs smoothly, the contractor keeps that buffer as additional profit — and most homeowners effectively pay for a contingency they never needed. A T&M project that runs without complications will often cost less than a fixed price bid covering the same scope.

The Idea That T&M Is Always Riskier for Homeowners

T&M contracts have a reputation for runaway budgets, and that reputation is earned in poorly structured agreements — but it is not an inherent feature of the contract type. A well-written T&M agreement includes agreed labor rates per trade, a defined material markup percentage, a not-to-exceed ceiling, and weekly billing statements that allow for regular review. When those guardrails are in place, most people find T&M contracts more transparent than fixed price agreements, not less. Our team also recommends that anyone managing a renovation understand what triggers a building code inspection in California, since unexpected inspections can add scope and time to either contract type.

How to Structure Either Contract Wisely

Essential Clauses in a Fixed Price Agreement

A fixed price contract is only as protective as the scope of work document attached to it. Our team recommends that every fixed price agreement include a detailed scope with brand names and finish specifications, a written change order process that requires signed approval before any extra work begins, payment milestones tied to completed phases rather than calendar dates, and a clause specifying how hidden conditions will be handled and priced. The California Contractors State License Board outlines the minimum required elements for any residential contract, and a thorough scope document typically exceeds those minimums by a wide margin.

Essential Clauses in a T&M Agreement

T&M contracts require tighter written guardrails than fixed price agreements, because the cost is open-ended by default. Our team recommends:

  • A not-to-exceed cap that limits total cost without written authorization to proceed further
  • Agreed labor rates for each trade, listed by hour and position
  • A defined material markup percentage, typically between 10 and 20 percent
  • Weekly or biweekly itemized invoicing with receipts available on request
  • A clear process for authorizing any scope additions in writing before work begins

Fixed Price vs Time and Materials Contract: Side by Side

Breaking Down the Key Differences

Most remodeling decisions come down to how clearly the project is defined and how much financial uncertainty either party is prepared to absorb. The table below summarizes the core distinctions our team uses when helping clients match a contract structure to their specific project.

FactorFixed PriceTime & Materials
Budget predictabilityHigh — total cost locked before work beginsVariable — depends on hours, materials, and pace
Best project fitWell-defined scopes with complete drawingsProjects with unknowns or evolving scope
Contractor risk levelHigher — absorbs overruns (until change orders)Lower — actual costs pass through to homeowner
Homeowner risk levelChange orders can accumulate quicklyTotal cost uncertain without a cap clause
Cost transparencyLow — contractor margin is not disclosedHigh — labor rates and markups are itemized
Common Bay Area useKitchen, bath remodels, ADU builds with full plansOlder home renovations, discovery work, phased projects

For homeowners weighing larger-scale projects, our comparison of garage conversion vs room addition also addresses how scope clarity shapes cost estimates and which contract structure tends to suit each project path.

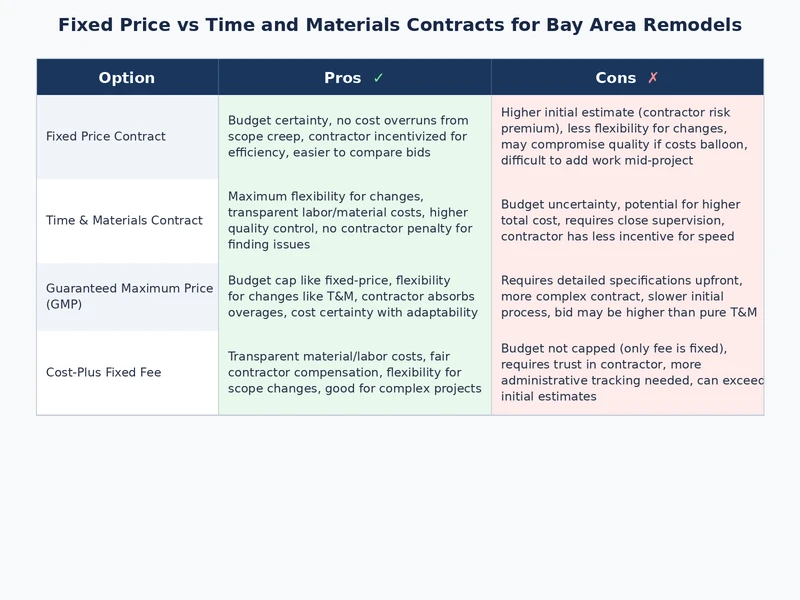

visual comparison of fixed price vs time and materials contract structures for Bay Area remodeling projects
Figure 3 — A side-by-side look at how fixed price and T&M contracts allocate risk and transparency across a remodeling project.

Where Things Tend to Go Wrong

Signing Before the Scope Is Complete

The most common error our team observes is a homeowner signing a fixed price contract before architectural drawings are finished or material selections are finalized. Contractors then add change orders for each decision made during construction, and the fixed price quickly becomes a meaningless starting point rather than a real ceiling. The final cost frequently exceeds what a well-structured T&M contract with a cap would have produced for the same project. Our recommendation is to treat a complete scope document as a prerequisite for signing any fixed price agreement, not an afterthought.

Skipping the Change Order Process

Verbal approvals for extra work rank among the top causes of construction disputes in California, and our team has seen this pattern play out repeatedly on both contract types. Any work outside the original scope should go through a signed written change order before work begins, regardless of how small the addition seems in the moment. A change order covering a $500 item today prevents a significant billing dispute at the close of the project. Anyone whose project uncovers unpermitted prior work should also review how to get a retroactive permit for unpermitted work in the Bay Area, since those situations routinely generate additional scope changes that need formal documentation.

Choosing the Wrong Structure for a Complex Project

Larger projects — ADU builds, full home additions, whole-house remodels — involve far more variables than a single-room renovation. Our team has seen homeowners lock into fixed price agreements on ADU builds only to face an extended series of change orders when city inspections require plan revisions or foundation work reveals unexpected soil conditions. For complex projects, a hybrid approach tends to serve most people better: a fixed price agreement covering design and permitting, followed by T&M with a cap for the construction phase. For anyone navigating the permitting process specifically, understanding owner-builder permit rules in California clarifies contractor accountability requirements that affect how either contract type is administered.

Keeping the Project on Track After Signing

Monitoring Progress Under Either Model

Signing a contract does not end the active management of a remodel — it begins a new phase of it. Under a fixed price agreement, tracking milestone payments against actual completed work is essential, because paying significantly ahead of progress creates leverage problems that are difficult to resolve later. Under T&M, weekly invoice review is the primary tool for catching billing errors or scope creep before they compound. Our team finds that clients who keep a written log of conversations with their contractor, ask questions about line items promptly, and document any verbal agreements in follow-up emails almost never end up in disputes at project closeout.

When Renegotiation Makes Sense

Mid-project renegotiation is not a sign that something has gone wrong — sometimes it reflects an honest response to conditions that neither party could have predicted. If a fixed price project encounters genuinely unforeseen conditions such as asbestos, corroded plumbing, or an undersized electrical panel, converting part of the remaining scope to T&M with a cap can be fairer to both parties than forcing the contractor to absorb costs that were not foreseeable at the time of bidding. The key is documenting the reason for the change clearly, putting the new terms in writing, and obtaining signatures from both parties before any additional work proceeds.

Frequently Asked Questions

A fixed price contract (or lump sum contract) sets a single total cost before work begins, so the homeowner knows the budget ceiling upfront. A time and materials contract bills for actual labor hours and material costs as work progresses, with the final number determined by how the project unfolds. Fixed price agreements offer cost predictability, while T&M agreements offer greater transparency into how money is being spent.
For kitchen and bathroom remodels where drawings are complete and materials are already selected, a fixed price contract tends to work well because the scope is well-defined and contractors can price the work accurately. For older homes where opening walls may reveal plumbing or electrical surprises, a T&M contract with a not-to-exceed cap often provides a more honest framework, since it avoids the large contingency buffers that contractors typically build into fixed price bids for uncertain conditions.
Yes, and our team sometimes recommends this approach for complex projects. A hybrid structure — fixed price for design and permitting, T&M with a cap for the construction phase — can work well when the scope is not fully clear until permits are approved and site conditions are confirmed. Any mid-project change to the contract structure should be documented in a formal written amendment signed by both parties before any new work begins.

Key Takeaways

  • A fixed price vs time and materials contract decision should be driven by how clearly the project scope is defined — not by habit or what the contractor prefers.
  • Fixed price bids include built-in contingency buffers that homeowners pay regardless of whether problems actually arise, meaning T&M can be the lower-cost option when conditions are genuinely uncertain.
  • Both contract types require strong written protections — a detailed scope for fixed price agreements and a not-to-exceed cap with itemized billing for T&M agreements.
  • A hybrid approach, pairing a fixed price design and permitting phase with a capped T&M construction phase, often serves complex Bay Area remodels better than either pure structure alone.

Related Posts

How to Set a Realistic Budget with Your Bay Area Contractor

How to Set a Realistic Budget with Your Bay Area Contractor

Plan your Bay Area renovation with confidence by learning how to set a realistic contractor budget t...

Read More →
How Contractor Licensing Works in California: What Homeowners Should Verify

How Contractor Licensing Works in California: What Homeowners Should Verify

Learn what California contractor licenses mean, how to verify them with the CSLB, and what homeowner...

Read More →
Red Flags When Hiring a Contractor for Home Additions in San Jose

Red Flags When Hiring a Contractor for Home Additions in San Jose

Spot the warning signs before you sign: key red flags to watch for when hiring a contractor for home...

Read More →

Ready to Start Your Project?

Contact us today for a free consultation and estimate.

Get Started
