Red Flags When Hiring a Contractor for Home Additions in San Jose
Nearly one in three construction projects in California results in a formal complaint with the Contractors State License Board — and home additions account for a disproportionate share of those disputes. Recognizing the red flags hiring a contractor for a home addition before the first check clears is the most important step anyone building in San Jose can take. Our team at 9Builders has been navigating the home additions process in the Bay Area for years, and the same warning signs appear in failed projects again and again, from Berryessa to Cambrian Park.
San Jose's seismic zone requirements, Title 24 energy compliance mandates, and layered permit process make home additions genuinely complex. A weak contractor doesn't just slow things down — they create structural liability, unpermitted work, and legal exposure that surfaces years later during resale or refinancing. The wrong hire costs more to fix than the original project ever would have.
Anyone considering a room addition, second-story build-out, or garage expansion in San Jose should treat contractor vetting as seriously as architectural design. The information below reflects what our team has seen on real job sites and in real contract disputes across the South Bay.
What Suspiciously Low Bids Actually Signal
Price is the first number most people notice when comparing estimates. A bid that lands 20–30% below every other contractor isn't a deal — it's a diagnosis. Our team has watched this play out on dozens of projects, and the root cause is almost always one of three things: missing scope, unlicensed labor, or a contractor planning to recover margin through change orders once work has started and backing out feels costly.
The Anatomy of a Too-Low Bid
Home additions in San Jose typically run $400–$650 per square foot for standard room additions, and considerably more for second-story builds or additions attached to an existing ADU footprint. When a bid lands well below that range, here is what our team looks for first:
- Missing permit costs — San Jose building permits for additions routinely run $8,000–$25,000 depending on scope. Contractors who omit this are treating it as a future "extra."
- No engineering allowance — Structural engineering, Title 24 energy compliance reports, and soils reports are not optional line items. Leaving them out of the bid is a lie by omission.
- Unlicensed subcontractors — Licensed electrical, plumbing, and framing subs cost real money. Low bids almost always cut corners on this first.
- Deliberate low-balling — Some contractors underbid specifically to win the contract, then manufacture reasons for change orders once walls are open and the client feels locked in. Our breakdown of comparing contractor bids in the Bay Area walks through the exact line items that expose this tactic.
Red Flags in the Bid Document Itself
| Bid Element | What a Solid Bid Looks Like | What a Red Flag Looks Like |
|---|---|---|
| Permits | Itemized with estimated city fees | Omitted entirely or listed as "TBD" |
| Material Specifications | Specific brand, grade, and quantity | Vague ("standard materials," "to be determined") |
| Payment Schedule | Tied to verifiable project milestones | Large upfront deposit exceeding 10% |
| Subcontractors | Named with license numbers listed | Not mentioned or described as "our crew" |
| Change Order Policy | Written approval required, rate specified | No mention of the change order process |
California law caps the initial deposit at 10% of the contract price or $1,000 — whichever is less. A contractor demanding $5,000 upfront before a single tool arrives is already operating outside the law, and that predicts exactly how they'll handle every disagreement that follows.
Red Flags in Licensing, Permits, and Insurance
This is where the most dangerous red flags hiring a contractor for a home addition actually live. Licensing and permit failures in San Jose create problems that surface at resale, during refinancing, or in a buyer's inspection — sometimes a full decade after the work was done.
What to Verify Before Signing Anything
- CSLB license status — Every general contractor in California must hold an active Class B license. Our team verifies directly through the California Contractors State License Board database. A verbal assurance from the contractor is not sufficient.
- Workers' compensation and general liability — Request certificates of insurance and call the carrier directly to confirm active coverage. An uninsured worker injured on the project creates direct homeowner liability under California law.
- Permit pull history in San Jose — Contractors who work legally in the city leave a public permit record. A contractor with no San Jose permit history is either new to the market, unlicensed, or accustomed to working around the inspection process.
- Bond status — California requires licensed contractors to carry a $25,000 contractor's bond. A lapsed bond is a CSLB violation and removes a key financial recovery option if the contractor abandons the project.
Hard rule from our team: any contractor who suggests pulling permits in the homeowner's name to "save money" or "move faster" is transferring their legal liability onto the property owner — and creating costly retroactive permit problems that are entirely the owner's burden to fix.
Permit Red Flags Specific to San Jose
- Contractor claims structural work "doesn't need a permit" — it always does in San Jose
- No mention of building code inspections or inspection scheduling in the project timeline
- Refuses to include license number on the contract or scope document
- Cannot explain the Title 24 energy compliance process for the addition footprint
- Proposes starting work before permits are approved — a common tactic used to pressure homeowners into proceeding
For anyone moving into contract review, our home renovation contract checklist for Bay Area projects covers the specific language that protects homeowners on permit responsibility, inspection obligations, and subcontractor disclosure.
How First-Time Addition Clients Get Exploited Most
First-time home addition clients and experienced renovators face entirely different risk profiles. Our team has observed that contractors with predatory practices deploy specific tactics against first-timers that rarely work on someone who has completed a full addition before. The pattern is consistent enough that our team treats it as a category of red flag on its own.
Tactics Used on First-Timers
- Urgency pressure — "I have another project starting in two weeks, so I need a decision by Friday." Legitimate contractors don't manufacture urgency. This tactic is designed to prevent comparison shopping and contract review.
- Scope bundling — Presenting a single lump-sum bid with no line items, making it impossible to compare against competitors or identify what's actually included.
- Reference avoidance — Offering online testimonials or Google reviews instead of actual client references with phone numbers. Our team always calls references directly and asks specific questions: did the project finish on schedule, how many change orders were generated, and would they hire this contractor again for structural work.
- Verbal promises — Committing to finishes, features, timelines, or warranties verbally that never appear in the contract. Under California contract law, if it isn't in writing, it doesn't exist.
- Subcontractor bait-and-switch — Presenting a highly credentialed team during the sales process, then assigning unlicensed day labor once the contract is signed.
What Clients With Prior Addition Experience Do Differently
Anyone who has completed a full home addition before typically comes in knowing these things already:
- They request a detailed scope of work before any bid discussion begins — and they verify it matches the architectural drawings
- They understand that change orders during a home remodel are a normal part of construction, but the process for approving them must be formalized in writing before work starts
- They verify that the contractor's portfolio includes structural addition work specifically — not just interior remodeling or kitchen renovations
- They confirm prior experience with San Jose's permit office, since relationships with local inspectors and familiarity with city-specific requirements affect project timelines materially
Before signing any agreement, our guide on questions to ask before signing a builder contract provides a solid baseline for screening any contractor — the principles apply equally to additions and ADU builds.
When to Walk Away vs. When to Give a Second Look

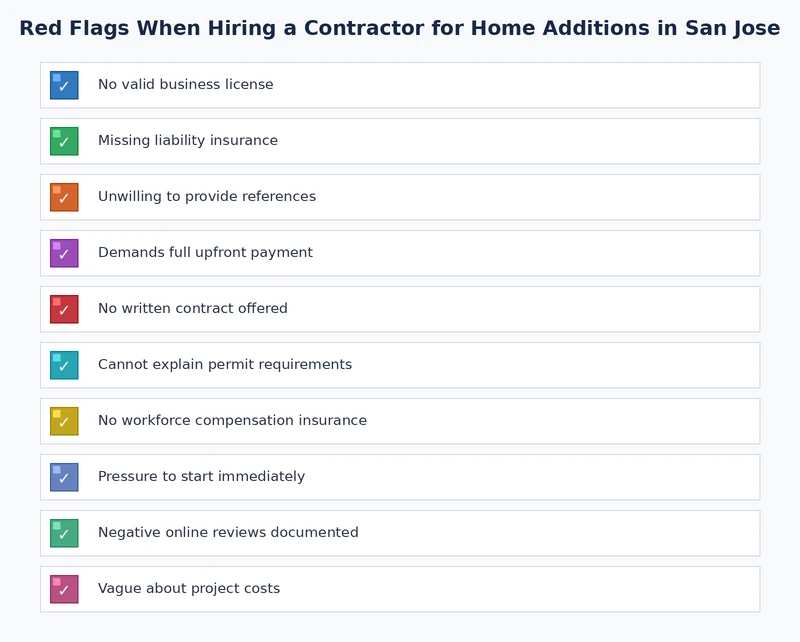

Not every warning sign ends the conversation. Our team distinguishes sharply between hard disqualifiers — things that close the door immediately — and soft flags that deserve a direct question before making a final call. Conflating the two leads to either hiring the wrong person or unnecessarily eliminating capable contractors over minor issues.
Hard Disqualifiers: No Exceptions
- No valid CSLB Class B license, expired license, or license held under a different entity name
- No workers' compensation insurance, lapsed coverage, or refusal to provide carrier verification
- Initial deposit request exceeding 10% of contract value — California law is unambiguous here
- Any suggestion that the addition can be built without permits
- No physical business address — PO box only, or a residential address with no business history
- CSLB disciplinary record showing abandoned projects, fraud findings, or bond suspension
- Pressure to sign same-day or before a written contract is provided
Soft Flags That Deserve Clarification
- New to San Jose but licensed elsewhere — Out-of-area contractors expanding into the Bay Area market can be legitimate. Our team asks for permit records from their prior jurisdiction and verifies the CSLB license was active throughout that work history.
- Slightly vague material specifications — Could reflect a template bid document. Ask for specifics in writing before proceeding to contract.
- Limited online reviews — High-quality small contractors often carry fewer reviews than volume-based firms. CSLB complaint history is a more reliable signal than star ratings.
- Higher-than-expected bid — Not a red flag. A complete, itemized bid that comes in above competitors is often the most honest estimate on the table. Our team has seen this pattern prove accurate at final accounting repeatedly.
If a dispute does arise after work begins, California provides specific legal mechanisms. Our breakdown of how to resolve a contractor dispute in California covers the CSLB complaint process, mediation through the Contractors State License Board, and small claims options for financial recovery.
Warning Signs Our Team Has Seen on San Jose Job Sites
Pattern recognition accelerates judgment. Our team has reviewed enough failed addition projects in San Jose to know that specific combinations of red flags consistently precede the worst outcomes — and that certain contractor behaviors are far more predictive of problems than initial impressions suggest.
The Abandoned Foundation Pattern
One of the most common stories our team encounters involves a contractor who poured a foundation, collected 40–50% of the total contract, then went silent. In San Jose, this scenario almost always shares the same underlying anatomy:
- The contractor held no valid Class B license, or the license was registered to a shell entity that was later dissolved
- No performance bond or payment bond was included in the contract
- Permits were pulled in the homeowner's name under an owner-builder permit — which transferred all contractor accountability to the property owner and removed standard legal protections
The owner-builder permit tactic is one our team flags immediately. Some contractors actively push homeowners toward this arrangement because it eliminates their exposure entirely. What looks like a paperwork shortcut creates unlimited liability for the homeowner if anything goes wrong structurally, legally, or with the workforce.
The Change Order Spiral
Another pattern our team sees repeatedly: a contractor wins the contract with a lean scope, then generates change orders at every decision point throughout construction. By the time framing is complete, the project is 25–40% over the original contract price — and the homeowner feels financially locked in because stopping means an unfinished structure exposed to weather.
- Change orders that weren't foreseeable should be rare on a properly scoped addition — foundation surprises and hidden utilities are exceptions, not the norm
- Any legitimate change order requires written documentation, cost breakdown, and signed client approval before work proceeds — not after
- A contractor generating three or more change orders before framing is complete is a structural problem in the project, not just an administrative one
The Insurance Gap Mid-Project
Workers' compensation insurance is expensive, and some contractors let it lapse after initial contract signing — knowing that most homeowners never re-verify. Our team recommends requesting updated certificates of insurance at three points: contract signing, after framing begins, and at the 60-day mark. A certificate that was valid on day one may not be active when a subcontractor falls off scaffolding on day 45. That gap in coverage becomes the property owner's problem under California law.
Frequently Asked Questions
Key Takeaways
- Any contractor requesting more than 10% upfront, lacking a valid CSLB Class B license, or suggesting unpermitted work is an immediate disqualifier — no exceptions in San Jose's regulatory environment.
- A bid that comes in 20–30% below all other estimates almost always signals missing scope, unlicensed subcontractors, or a deliberate low-ball strategy designed to recapture margin through change orders once work has started.
- Workers' compensation and general liability insurance should be verified directly with the carrier at contract signing and again at the 60-day mark — a valid certificate at signing does not guarantee active coverage mid-project.
- First-time addition clients are specifically targeted with urgency pressure, bundled bids, and verbal promises that never appear in contracts — every commitment that matters must exist in writing before any deposit is made.
Related Posts
How to Set a Realistic Budget with Your Bay Area Contractor
Plan your Bay Area renovation with confidence by learning how to set a realistic contractor budget t...
Read More →
How Contractor Licensing Works in California: What Homeowners Should Verify
Learn what California contractor licenses mean, how to verify them with the CSLB, and what homeowner...
Read More →
How to Compare Contractor Bids for a Kitchen Remodel in the Bay Area
Compare Bay Area kitchen remodel bids with confidence—learn what to look for in contractor quotes, r...
Read More →
