How Long Does a Garage Conversion Take in San Jose
San Jose's building department receives over 2,000 garage conversion and ADU permit applications every year — and the average applicant waits 8 to 12 weeks just for initial plan approval before a single tool comes out. If you're wondering how long does a garage conversion take in San Jose, the straight answer is 4 to 7 months for most projects. That window covers design, permitting, construction, and final inspections from start to certificate of occupancy. Start by reviewing our garage conversion services to get a clear picture of what the process involves before you commit to a timeline.
Your garage is probably the most underused space on your property. Converting it adds permanent square footage without building new footings or expanding your home's envelope. But the process has more moving parts than most homeowners expect — and underestimating any single phase can push your move-in date back by weeks or months.
This guide breaks down every phase, explains what causes delays, and tells you exactly how to protect your schedule. Whether you're planning a simple studio conversion or a full garage to ADU conversion in San Jose, the timeline mechanics are the same.

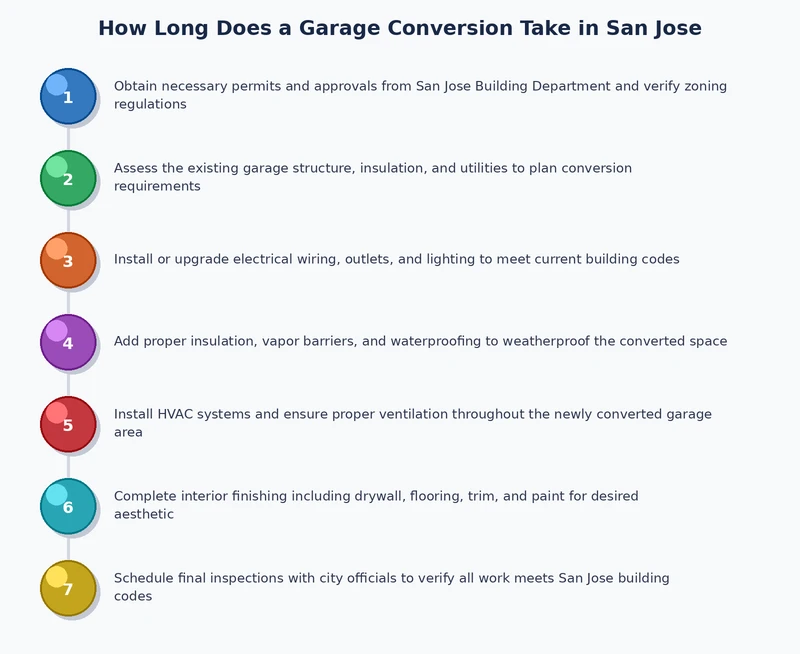

How Long Each Phase Actually Takes
A garage conversion in San Jose moves through five distinct phases. Each one has its own pace, and delays in one phase cascade into the next. Here's a realistic breakdown.
The Five-Phase Timeline
| Phase | What Happens | Typical Duration | Common Delays |
|---|---|---|---|
| 1. Design & Engineering | Architectural drawings, structural engineering, energy calcs | 3 to 6 weeks | Revision cycles, structural surprises |
| 2. Permit Submission & Approval | Plan check, corrections, final permit issuance | 8 to 16 weeks | Plan rejections, correction rounds |
| 3. Demo & Rough-In | Demolition, framing, electrical, plumbing, HVAC rough-in | 3 to 6 weeks | Subcontractor scheduling gaps |
| 4. Finishes | Insulation, drywall, flooring, fixtures, paint, trim | 3 to 5 weeks | Material lead times, change orders |
| 5. Final Inspections & CO | Final building, electrical, plumbing, fire inspections | 1 to 3 weeks | Failed inspections, PG&E coordination |
What "4 to 7 Months" Really Means
The 4-month end is achievable only under ideal conditions:
- Plans are clean and code-compliant on first submission
- Your contractor has no scheduling gaps
- No structural surprises surface during demo
- Inspections get scheduled within days of each request
The 7-month end is more realistic for most San Jose homeowners. Plan for 6 months and treat anything faster as a bonus. The homeowners who budget for 3 months are the ones calling us frustrated at month five.
Pro tip: Design and permit prep happen before your contractor ever breaks ground. Don't count on shortening the permit window — use that time to finalize your finishes and lock in subcontractors so construction starts without a single day of dead air.
What Your Timeline Will Really Cost You
Time and money are directly linked in a garage conversion. Every week of unexpected delay has a real dollar cost — in carrying costs, temporary housing, or contractor standby fees. Understanding the cost structure helps you protect both your schedule and your wallet.
Where Your Budget Goes
For a complete picture of what to expect, our guide on garage conversion costs in San Jose breaks down every line item. Here's the quick version for a standard 400–500 sq ft attached garage conversion:
- Design and engineering: $3,000 to $8,000
- Permit fees: $5,000 to $12,000 (San Jose's fees are among the highest in California)
- Demolition and framing: $4,000 to $8,000
- Electrical upgrades: $4,000 to $10,000 depending on panel capacity and subpanel needs
- Plumbing rough-in (if adding bathroom/kitchen): $5,000 to $15,000
- Insulation: $2,500 to $6,000
- Drywall, flooring, paint, fixtures: $8,000 to $18,000
- Total typical range: $60,000 to $120,000 for a livable ADU
Hidden Timeline Costs
These are the expenses most homeowners don't factor in upfront:
- Temporary housing: If the garage connects to your main living area, noise and dust may push you out during rough-in
- Contractor holding fees: Some GCs charge a standby rate if permit approval runs past their scheduled start window
- Material price movement: Lumber and copper wire pricing can shift 10–15% between your quote date and actual purchase
- Re-inspection fees: San Jose charges $150–250 per re-inspection visit after a failed check
The Honest Trade-Offs of a Garage Conversion
A garage conversion isn't the right call for every homeowner. Know the real trade-offs before you commit months of your life and tens of thousands of dollars to the process.
What Works in Your Favor
- Faster timeline than a room addition — no new foundation, no exterior framing from scratch
- Lower cost per square foot than any other square footage expansion option
- ADU rental income in San Jose averages $1,800 to $2,800 per month — meaningful mortgage offset
- California state law (AB 2221) has significantly streamlined the permitting process compared to pre-2023
- Adds permanent, appraised square footage to your home's market value
Still deciding between a conversion and a room addition? Our comparison of garage conversion vs room addition for Bay Area homes breaks down the timeline and cost differences in detail.
Where You'll Run Into Friction
- You lose parking: San Jose no longer requires replacement parking for ADUs, but your household still loses a spot
- Ceiling height is often marginal — many garages sit at 7'6", just barely above the 7' code minimum for habitable space
- An uninsulated concrete slab floor and metal garage door frame require significant thermal envelope work
- Utility upgrades (electrical panel, gas line, sewer connection) can add unexpected cost and weeks to the schedule
- If you're creating a rental unit, ongoing property management adds to your long-term responsibility load
Insider note: Most homeowners badly underestimate the insulation work a garage conversion requires. Walls, floor, and ceiling all need attention. Read our guide on insulating a garage conversion in the Bay Area before you finalize your budget — it will change your numbers.
Permits: When to Start — and When to Wait
The permit process is the single biggest variable in your entire timeline. In San Jose, the permit window runs 8 to 16 weeks for most garage conversions. That's not construction time. That's just waiting for paper approvals. Getting the timing right on your submission protects everything downstream.
When You're Ready to Submit Permits
Pull permits when all of these are true:
- You have stamped, code-compliant architectural plans — not sketches, not CAD drafts
- You've verified your lot coverage, setback requirements, and owner-occupancy status with the City of San Jose Planning Division
- Your general contractor has reviewed the plans and confirmed your target start date works with their schedule
- You've budgeted for permit fees — $5,000 to $12,000 is typical for a full ADU conversion
When You Should Wait
Hold off on submitting if any of these apply:
- Your plans aren't finalized — revisions after submission restart your position in the review queue
- Your contractor isn't locked in and confirmed for your target construction window
- Your property has any outstanding code violations — those must be cleared before ADU permits are issued
- You haven't consulted a licensed electrician about your panel capacity — plan revisions triggered by electrical surprises are common and costly
Understanding the electrical requirements for a San Jose garage conversion early in the design phase is one of the highest-leverage things you can do to prevent plan revision cycles that reset your permit clock.
Timeline Killers: Mistakes That Add Months
The most avoidable delays share a common thread: they're caused by decisions made — or not made — before construction starts. Most timeline blowouts are entirely self-inflicted. Here's what to watch for.
Design Phase Mistakes
- Hiring a designer who isn't current on San Jose's ADU regulations — their plans come back rejected
- Skipping a pre-application meeting with the building department on complex or non-standard projects
- Failing to confirm setback requirements and lot coverage limits before finalizing your floor plan
- Using a floor plan template from another city — code details differ at the municipal level
Construction Phase Mistakes
- Ordering materials late: Windows, exterior doors, and HVAC equipment have lead times of 6 to 10 weeks. Order them the week you submit permits, not the week construction starts.
- Not scheduling inspections immediately after each rough-in phase — waiting a week at each stage adds a month to your project
- Changing the floor plan after framing is complete — this triggers plan revisions and forces a re-inspection of work already done
- Hiring a GC who over-relies on subcontractors without personally managing their schedules
Post-Construction Mistakes
- Missing final inspection checklist items — a single missing GFCI outlet or smoke detector can delay your CO by weeks
- Failing to coordinate the PG&E meter upgrade in advance — PG&E has its own queue that doesn't care about your contractor's schedule
Warning: Never begin construction before your permits are physically in hand. San Jose code enforcement is active, and a stop-work order doesn't add days to your project — it adds months.
How to Shave Weeks Off Your Project
You can't control the permit office's review speed. But you can control everything that touches your project before and after that window. These moves consistently cut 2 to 6 weeks off a typical garage conversion.
Before You Submit Permits
- Ask about over-the-counter plan check: San Jose offers same-day or next-day review for simple, qualifying projects. Ask your designer if your project qualifies before assuming standard queue timing.
- Hire a designer with a documented track record of first-time San Jose approvals — ask them specifically how often their plans get kicked back.
- Order long-lead materials (windows, exterior doors, HVAC) the same week you submit permits — they'll arrive just as construction is ready to start.
- Finalize your flooring and interior finish selections before demo day. Our guide on garage conversion flooring options for Bay Area homes walks you through the choices — make them early and move on.
During Construction
- Schedule your inspection the morning after each phase completes — don't wait two or three days
- Keep a single point of contact available to respond to inspector questions the same day they're raised
- Stock common inspection fail items on-site before the inspector arrives: GFCI outlets, combination smoke/CO detectors, draft stop material
- Do not start drywall until all rough-in inspections are signed off — opening up finished drywall is expensive and slow
The Long Game
A well-planned conversion always finishes faster than a rushed one. The homeowners who pressure contractors to skip steps are the ones calling six months later about failed inspections and code violations. Slow is smooth. Smooth is fast. Every corner you cut in weeks one through four will cost you double in weeks twelve through twenty.
When Your Project Stalls: Getting Back on Track
Even well-planned projects hit walls. Here's how to diagnose the stall and recover without losing more time than necessary.
If Permits Are Delayed
- Call the building department directly and ask for your plan checker by name — get a specific status, not a generic timeline estimate
- If your plans were rejected, request a written correction list before leaving the counter — vague verbal feedback wastes your next resubmission
- For projects stuck in a second or third review cycle, consider hiring a permit expediter who has existing relationships with the department
- Verify that your architect or designer has responded to every single correction item — partial responses fail again automatically
If Your Contractor Goes Quiet
- Require written weekly status updates — verbal commitments disappear when things get complicated
- Review your contract's milestone payment structure before writing the next check — don't pay ahead of completed milestones
- If a subcontractor is the bottleneck, it's entirely reasonable to ask your GC to bring in a backup sub
- Document every delay in writing — if the relationship deteriorates, you'll need that paper trail
If You're Failing Inspections
- Ask the inspector for a complete written correction list before they leave the site
- Fix every item on the list — not most of them — before scheduling a re-inspection
- For complex corrections, bring your GC and the relevant subcontractor together to the re-inspection so questions get answered on the spot
If your project involves a detached structure, our guide on converting a detached garage into a rental unit in San Jose covers the specific permitting and construction differences that catch homeowners off guard.
Final Thoughts
Knowing how long a garage conversion takes before you start is the single biggest advantage you can give yourself in San Jose's competitive building environment. Plan for 4 to 7 months, protect your permit submission with clean plans, and choose a contractor who treats the inspection schedule as seriously as the construction schedule. If you're ready to get a real, project-specific timeline for your garage, contact 9Builders for a free consultation — we'll walk you through every phase and tell you exactly what to expect for your property and your goals.
Related Posts
Garage Conversion Building Codes and Setback Rules in San Jose
Navigate San Jose's garage conversion building codes and setback rules to ensure your ADU project me...
Read More →
Converting Your Garage into a Home Office in San Jose
Transform your San Jose garage into a productive home office with expert tips on permits, insulation...
Read More →
Garage Conversion Ventilation and HVAC Solutions for Bay Area Climate
Upgrade your Bay Area garage conversion with the right ventilation and HVAC solutions to stay comfor...
Read More →
