Earthquake Retrofit Permits in Santa Clara County: A Complete Guide
Nearly 70% of homes in Santa Clara County were built before modern seismic codes took effect in 1980. That means hundreds of thousands of structures sit on foundations never designed to handle the kind of shaking the Hayward or San Andreas faults can deliver. If you own one of these homes, securing an earthquake retrofit permit in Santa Clara County is the critical first step toward protecting your investment — and your family. Before you pick up the phone to call a contractor, you need to understand what the county requires, what it costs, and how to avoid the delays that trip up most homeowners. If you're unsure whether your property even needs seismic work, start with our guide on how to know if your Bay Area home needs earthquake retrofitting.
Santa Clara County's permitting process for seismic retrofits is more straightforward than most homeowners expect — but only if you submit the right documents the first time. The county's Department of Planning and Development reviews residential retrofit permits under prescriptive standards for most single-family homes. You don't always need a full structural engineering report. However, skipping steps or filing incomplete plans leads to rejections that add weeks to your timeline.
This guide walks you through every stage of the permit process: required documents, fee breakdowns, inspection checkpoints, and the strategies that experienced contractors use to keep projects on track.
Why Santa Clara County Requires Retrofit Permits
Santa Clara County sits within one of the most seismically active regions on the planet. The permitting requirement exists to ensure that every retrofit actually improves a home's survivability — not just cosmetically patches a crawl space. An earthquake retrofit permit in Santa Clara County triggers a plan review and at least one structural inspection, both of which catch mistakes that could prove fatal during a major quake.
The Seismic Risk Driving Local Policy
The USGS Earthquake Hazards Program estimates a 72% probability of a magnitude 6.7+ earthquake hitting the Bay Area before 2043. Santa Clara County specifically faces threats from multiple fault systems:
- Hayward Fault — runs through the eastern edge of the county, overdue for a major rupture
- San Andreas Fault — western boundary, capable of magnitude 8.0+ events
- Calaveras Fault — bisects the county through Milpitas and south San Jose
These aren't theoretical risks. The 1989 Loma Prieta earthquake caused over $6 billion in damage across the Bay Area. Homes without seismic retrofits suffered disproportionate structural failures.
Legal Framework and Code Standards
California Building Code (CBC) Chapter 34 governs existing building retrofits. Santa Clara County enforces these standards through its building division. Most residential retrofits fall under prescriptive standards, which means you follow a pre-approved set of construction details rather than hiring an engineer to design a custom solution.
The county accepts two primary retrofit standards:
- FEMA P-1100 — the federal prescriptive standard for cripple wall bracing and foundation bolting
- ICC Existing Building Code (IEBC) — broader scope, covers more complex retrofit scenarios
- Engineered plans — required when prescriptive standards don't apply to your home's configuration
Earthquake Retrofit Permit Fees and Budget Breakdown
Permit costs represent a small fraction of your total retrofit budget, but they're the piece most homeowners underestimate. The county charges fees at multiple stages, and third-party costs can exceed the permit fees themselves. For a deeper look at total project costs, see our breakdown of earthquake retrofitting costs in the Bay Area.
County Fee Schedule
| Fee Category | Typical Range | Notes |
|---|---|---|
| Building permit (prescriptive) | $300–$600 | Based on project valuation |
| Building permit (engineered) | $500–$1,200 | Higher valuation triggers higher fees |
| Plan review fee | $200–$500 | 65% of permit fee (standard formula) |
| Technology/records surcharge | $50–$100 | Fixed surcharge added to all permits |
| SMIP (seismic monitoring) fee | $10–$30 | State-mandated, based on valuation |
| Structural engineering report | $1,500–$4,000 | Only if prescriptive path doesn't apply |
| Soils/geotechnical report | $2,000–$5,000 | Required for hillside or liquefaction zones |
Total permit-related costs for a standard bolt-and-brace retrofit typically run $600–$1,200. Engineered projects with geotechnical requirements can push that to $5,000+ before any construction begins.
Hidden Costs Most Homeowners Miss
- Expedited review fees — Santa Clara County offers expedited plan review for an additional 50–100% surcharge. Worth it when your contractor's schedule is tight.
- Re-inspection fees — if your work fails inspection, each return visit costs $150–$250.
- Permit extension fees — permits expire after 180 days. Extensions run $100–$200 each.
- Contractor markup — most licensed contractors include permit pulling in their bid. Verify whether this is included or billed separately.
Pro tip: Ask your contractor whether they pull the permit themselves or expect you to do it. A contractor who handles permitting has done it before and knows how to avoid common rejection triggers at the counter.
When You Need an Earthquake Retrofit Permit — and When You Don't
Not every piece of seismic work requires a permit. The distinction comes down to whether you're modifying structural elements or simply maintaining existing conditions.
Work That Triggers a Permit
You need a building permit for any of these retrofit activities:
- Installing new foundation anchor bolts (foundation bolting)
- Adding plywood shear panels to cripple walls
- Replacing or reinforcing a damaged mudsill
- Installing steel moment frames in garage or soft-story openings
- Adding hold-down hardware or Simpson connectors to the framing-to-foundation connection
- Pouring a new perimeter foundation to replace a failed one
- Any work that alters the lateral force-resisting system
If you're dealing with cripple wall bracing, you're firmly in permit territory. These projects involve structural sheathing that directly affects how your home transfers seismic loads to the foundation.
Exempt Repairs and Maintenance
These tasks generally do not require a permit:
- Replacing damaged siding or stucco without altering structure
- Caulking or sealing foundation cracks under 1/4 inch
- Installing earthquake straps on water heaters
- Securing furniture and appliances with anchoring kits
- Minor cosmetic repairs to crawl space access doors
The line gets blurry with certain foundation crack repairs. If you're injecting epoxy into a structural crack, the county may classify that as structural repair requiring a permit. When in doubt, call the building department — a five-minute phone call saves weeks of enforcement headaches.
Lessons from Real Retrofit Projects
Permit requirements look clean on paper. Real projects get messy. Here's what actually happens when homeowners in Santa Clara County pull retrofit permits and start construction.
Pre-1940 Homes with Unreinforced Foundations
Older homes in neighborhoods like Willow Glen, Rose Garden, and Naglee Park present the toughest retrofit scenarios. These properties often have:
- Unreinforced brick or stone foundations with no rebar
- Original redwood mudsills with termite damage or dry rot
- No existing anchor bolts connecting the frame to the foundation
- Irregular floor plans that don't fit prescriptive standards
For these homes, you'll almost certainly need an engineered retrofit plan. A structural engineer evaluates the existing foundation, designs a connection strategy, and produces stamped drawings that the county reviews. Plan review for engineered projects takes 3–6 weeks — significantly longer than the 1–2 weeks for prescriptive submittals.
One common discovery during construction: the existing foundation is too deteriorated to accept new anchor bolts. When this happens, the contractor needs to pour a new reinforced concrete stem wall alongside the old foundation. This triggers a plan revision and potentially a supplemental permit, adding $3,000–$8,000 to the project.
Raised Foundation and Cripple Wall Retrofits
Homes with raised foundations and cripple walls (short wood-framed walls between the foundation and the first floor) are the most common retrofit candidates in Santa Clara County. The prescriptive path works well for these projects when:
- The cripple wall height is 4 feet or less
- The home is two stories or fewer
- The floor area is under 2,000 square feet per story
- The foundation is in sound condition
Projects that exceed these parameters require engineered plans. The county is strict about these thresholds — a cripple wall measured at 4 feet 2 inches pushes you into the engineered category.
Raised foundation retrofits typically require two inspections: one for the anchor bolt installation (before concrete cures or epoxy sets) and one final inspection after shear panels and hardware are installed. Schedule your inspections at least 48 hours in advance through the county's online portal.
Long-Term Value and Insurance Benefits
An earthquake retrofit permit does more than authorize construction. It creates a permanent record that your home has been seismically upgraded to current standards. That record pays dividends for years.
Impact on Property Value
Permitted seismic retrofits directly affect your home's marketability:
- Disclosure advantage — California's Natural Hazard Disclosure (NHD) report flags seismic zones. A permitted retrofit shows buyers you've addressed the risk.
- Appraisal recognition — appraisers in Santa Clara County account for seismic improvements, especially in competitive neighborhoods.
- Buyer confidence — in a market where buyers routinely order seismic inspections, a finaled retrofit permit eliminates a major negotiation point.
- Avoid enforcement issues — unpermitted structural work can derail a sale during escrow. The county can require you to open walls and prove compliance.
Homes with documented seismic upgrades sell faster in earthquake-conscious markets. Bay Area buyers increasingly ask about retrofit status during their initial home tours.
Insurance Premium Reductions
Earthquake insurance through the California Earthquake Authority (CEA) offers premium discounts of 5–25% for homes with qualifying retrofits. To claim the discount, you need:
- A finaled building permit showing the retrofit scope
- Compliance with CEA's Brace + Bolt program standards
- Documentation from your insurer confirming the discount eligibility
The CEA's Brace + Bolt program has historically offered grants up to $3,000 for qualifying homeowners in designated ZIP codes. Several Santa Clara County ZIP codes have been included in past program cycles. Check eligibility before you start — the grant application must be approved before construction begins.
Over a 10-year period, insurance savings alone can recover 30–50% of a standard retrofit's cost. Combined with the property value benefit, the return on investment makes retrofit permitting one of the most financially sound decisions you can make as a Santa Clara County homeowner.
Common Retrofit Scenarios in Santa Clara County
Different home types require different permit approaches. Here's how the most common retrofit scenarios play out in the county's permitting system.
Foundation Bolting Projects
Foundation bolting is the most straightforward retrofit and the easiest to permit. You're adding steel anchor bolts that connect your home's wooden mudsill to the concrete foundation. For a detailed cost breakdown of this specific work, review our guide on foundation bolting costs in San Jose.

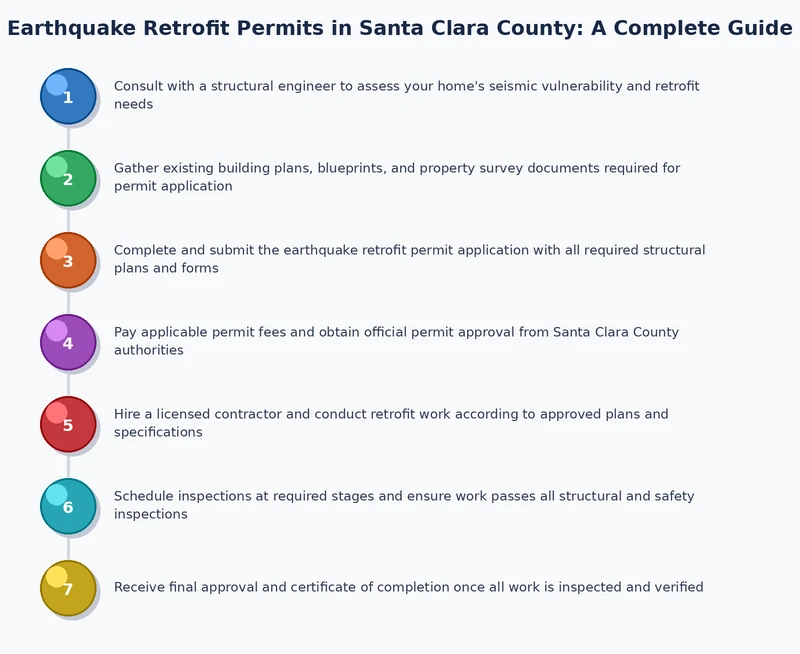

The permit process for foundation bolting:
- Submit application — include a site plan showing the foundation perimeter, bolt spacing, and hardware specifications
- Plan review — typically 5–10 business days for prescriptive plans
- Permit issuance — pick up at the county building department or receive electronically
- Pre-cover inspection — inspector verifies bolt placement, embedment depth, and washer/nut installation before any finish work covers the bolts
- Final inspection — confirms all work matches approved plans and passes code
Most foundation bolting projects use either expansion bolts (drilled into existing concrete) or adhesive anchors (epoxy-set into drilled holes). The county accepts both methods when installed per manufacturer specifications. Adhesive anchors require a special inspection for the epoxy installation — factor this into your timeline and budget.
Soft-Story and Multi-Unit Retrofits
Soft-story buildings — typically multi-unit residential structures with parking or commercial space on the ground floor — face additional permitting requirements. San Jose has a mandatory soft-story retrofit program that applies to qualifying buildings.
Key differences from single-family retrofit permits:
- Engineered plans required — no prescriptive path exists for soft-story retrofits
- Higher permit fees — project valuations for steel moment frames push fees into the $2,000–$5,000 range
- Special inspections — welding, concrete placement, and steel connections each require a certified special inspector
- Longer plan review — expect 4–8 weeks for complex multi-unit projects
- Phased construction — some buildings require temporary shoring during retrofit, which needs its own permit
If you own a multi-unit property, start the permit process at least 6 months before your compliance deadline. Engineering design alone takes 4–8 weeks, and plan review adds another month or more. Our advisory services can help you navigate the timeline and coordinate between engineers, contractors, and the county.
Frequently Asked Questions
The permit isn't the obstacle — it's the proof that your retrofit was done right, and the only document that stands between your home and an insurance denial after the next big quake.
Related Posts
Earthquake Retrofit Tax Credits and Rebates for Bay Area Homeowners
Discover available tax credits, rebates, and financial incentives for earthquake retrofitting your B...
Read More →
How Long Does Earthquake Retrofitting Take in the Bay Area
Earthquake retrofitting in the Bay Area typically takes 2 to 6 weeks depending on your home's founda...
