ADU Permit Process in San Jose: Timeline, Fees, and Tips

What if the biggest obstacle to building an ADU isn't the foundation, the framing, or the finishes — it's the permit stack? The ADU permit San Jose process is one of the most layered approval workflows in the Bay Area, and our team at 9Builders has watched well-planned projects stall for months because of missing documents or miscommunicated city requirements. The solution isn't to dread the process — it's to understand it completely before breaking ground, and that's exactly what this guide delivers.

ADU permit San Jose process overview showing a detached accessory dwelling unit under construction in a residential backyard
Figure 1 — A detached ADU mid-construction in San Jose — the permit process behind a project like this involves multiple city departments, utility coordination, and sequential inspection stages.

San Jose has made real strides in streamlining ADU approvals, partly driven by California's push to ease the housing shortage. But "streamlined" is relative — most people still encounter multiple review stages, competing agency requirements, and fee structures that feel opaque until they know where to look. Our team has distilled everything learned from real San Jose ADU projects into this breakdown of timelines, fees, common delays, and the specific steps that separate smooth approvals from drawn-out ones.

For anyone already thinking about budget, our companion post on how much it costs to build an ADU in San Jose puts permit fees in the context of the full project investment — a useful starting point before diving into the approval process itself.

Bar chart comparing ADU permit approval timelines in San Jose by project type — garage conversion, attached ADU, and detached ADU
Figure 2 — Typical ADU permit approval timelines in San Jose by project type, from application submission to permit issuance.

Why the ADU Permit Landscape in San Jose Has Changed

San Jose sits inside Santa Clara County, where local zoning laws once made ADU construction genuinely difficult — minimum lot sizes were large, setback requirements were strict, and owner-occupancy mandates attached to nearly every permit category. California's state legislature stepped in with a wave of ADU-friendly legislation, and local jurisdictions including San Jose had no choice but to align their rules with the new state standards.

State Law Setting the Stage

Several California bills — AB 68, AB 881, SB 13, and AB 3182 among the most impactful — dismantled the barriers that had kept ADU production low across the state. Key outcomes relevant to San Jose ADU applicants include:

  • Elimination of owner-occupancy requirements for most ADU categories
  • Reduced setbacks for detached ADUs, often down to 4 feet from rear and side property lines
  • Streamlined ministerial approval for ADUs that meet objective standards, removing discretionary review
  • Impact fee exemptions for ADUs under 750 square feet
  • Mandatory 60-day approval timelines for qualifying applications

For a broader look at how state law is reshaping Bay Area development options, our guide on the SB 9 lot split process in the Bay Area covers adjacent legislation that many ADU owners consider alongside their project.

How San Jose's Local Rules Layer On Top

San Jose's municipal code works on top of California's state minimums. The city has its own Planned Development zoning overlays, historic district rules, and neighborhood-specific design standards that can affect ADU placement, height limits, and exterior materials. Our team consistently finds that properties in older San Jose neighborhoods — particularly those with pre-1960 homes — benefit from an early pre-application meeting with the city's Development Services Department to surface any overlay restrictions before design begins. Skipping that pre-application step is the single most common source of late-stage redesigns our team encounters on San Jose ADU projects.

ADU Types and the Permit Requirements That Apply to Each

Not every ADU project triggers the same permit pathway in San Jose. The type of unit being built — and how it relates to the existing structure — determines which review track applies, which fees are assessed, and how long the approval process takes.

Detached and Attached ADUs

Detached ADUs are standalone structures built separately from the primary home, while attached ADUs share one or more walls with the main dwelling. Both require a full building permit in San Jose, including architectural plans, structural calculations, and coordinated review by Building, Planning, and Fire. Maximum size for detached ADUs in San Jose is 1,200 square feet, subject to lot coverage limits.

Key permit requirements for detached and attached ADUs:

  • Architectural drawings stamped by a licensed architect or engineer
  • Site plan showing setbacks, lot coverage, and utility connections
  • Title 24 energy compliance documentation
  • Structural plans and calculations for new construction
  • Separate utility connection documentation or shared service agreement

JADUs and Garage Conversions

Junior ADUs (JADUs) are carved out of existing living space within the primary dwelling and are capped at 500 square feet. Garage conversions can qualify as either a JADU or a standard ADU depending on size and configuration. Our team finds that garage conversions are often the fastest path through the ADU permit San Jose process because they leverage existing foundation and structure, significantly simplifying structural review. For anyone thinking about how spatial layout affects livability in smaller footprints, our post on open floor plan ADU designs that maximize small spaces offers practical strategies that work especially well in converted garages.

The ADU Permit Process in San Jose, Step by Step

The permit pathway for an ADU permit San Jose project moves through five distinct stages, and each one has specific deliverables that determine how quickly the next stage begins. Our team maps this out for every client at the start of a project so nothing comes as a surprise mid-process.

Pro tip: San Jose's Development Services Department offers optional pre-application conferences — scheduling one before submitting plans routinely catches issues that would otherwise return as plan check corrections, saving two to four weeks of review time on the first cycle.

Pre-Application and Plan Preparation

Stage 1: Pre-Application Research

  • Pull the property's zoning designation and any overlay districts from San Jose's GIS portal
  • Confirm lot size, existing lot coverage, and available square footage for ADU construction
  • Identify setback requirements based on ADU type and zoning district
  • Check for utility easements, deed restrictions, or CC&Rs that may affect placement

Stage 2: Design and Plan Development

  • Engage a licensed architect or designer experienced in San Jose ADU applications specifically
  • Prepare site plan, floor plans, elevations, and Title 24 energy compliance report
  • Coordinate utility service connections with PG&E and the relevant water provider early in design — not after permit submission

Plan Check and Agency Review

Stage 3: Application Submission

  • Submit plans through San Jose's online PermitCenter portal
  • Pay initial plan check fees at the time of submission
  • Applications are routed simultaneously to Building, Planning, and Fire review departments

Stage 4: Plan Check and Corrections

  • First plan check typically returns within 2–4 weeks for standard ADU applications; complex projects may take 6–8 weeks
  • Correction letters require a complete written response before the next review cycle begins
  • Minor corrections often resolve in a single resubmission; major structural issues require revised engineering documents
  • Each correction cycle adds 2–4 weeks to the overall timeline — which is why complete, coordinated applications matter so much at submission

Final Inspections and Certificate of Occupancy

Stage 5: Construction Inspections

  • Required inspections occur during construction in sequence: foundation, framing, rough electrical, rough plumbing, insulation, and final
  • Each inspection must be requested, scheduled, and passed before proceeding to the next construction phase
  • The Certificate of Occupancy is the legal green light for occupancy and is issued only after the final inspection passes without deficiencies

Our team handles all inspection scheduling as part of our standard construction process, and we build inspection windows into the project timeline from day one to avoid idle periods between phases.

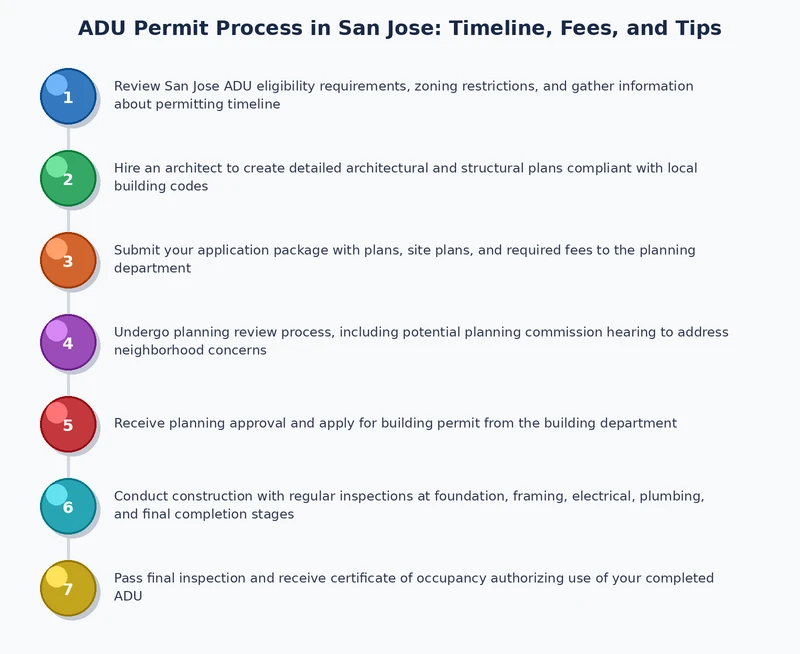

Process diagram showing the five stages of the ADU permit process in San Jose from pre-application through Certificate of Occupancy
Figure 3 — The five-stage ADU permit process in San Jose, from initial pre-application research through final inspection and Certificate of Occupancy issuance.

ADU Permit Fees and Realistic Timelines in San Jose

Understanding the full fee picture before applying for an ADU permit in San Jose prevents budget surprises that derail project financing mid-stream. Fees in San Jose are calculated on a formula basis tied to project valuation, square footage, and utility work scope — not a simple flat rate that applies to every project.

Fee Category Typical Range Notes
Building Permit (Plan Check + Issuance)$3,000 – $8,000Based on project valuation; split between plan check and permit issuance fees
Fire Review Fee$300 – $800Required for new construction ADUs; lower for simple garage conversions
School Impact Fee$0 – $4,500+Waived for ADUs under 500 sq ft; tiered above that threshold
Sewer Connection / Capacity Fee$2,000 – $6,000Depends on unit size and whether connection is new or shared
Electrical / PG&E Service Upgrade$500 – $3,000Varies by panel capacity, meter configuration, and distance from existing service
Planning / Zoning Review (if required)$200 – $1,500May apply in overlay districts or for projects requiring administrative hearings
Total Estimated Permit Costs$6,000 – $22,000+Varies significantly by ADU type, size, and existing utility infrastructure

The City of San Jose's Development Services Department publishes updated fee schedules on their official site — our team cross-references these at the start of every project to build accurate budgets before design begins. For broader guidance on structuring the full project budget, our post on setting a realistic budget with a Bay Area contractor walks through the planning process from initial estimates through contract signing.

What Delays the Timeline Most

Most ADU permit timelines in San Jose run 3–6 months from application submission to permit issuance for a straightforward project. Complex projects — those requiring variance requests, geotechnical reports, or historic district review — routinely run 6–12 months. The delays our team observes most consistently:

  • Incomplete application packages — missing Title 24 report, missing structural calculations, or uncoordinated plan sheets
  • Slow responses to plan check correction letters, since each correction cycle adds 2–4 weeks
  • Utility coordination delays, particularly for new meter installations that require PG&E scheduling
  • Underestimating the fire review timeline for two-story ADUs or those with unusual egress configurations
  • Lot coverage issues discovered late in design that require a full redesign before resubmission

Staying Compliant After the ADU Is Approved

Getting the Certificate of Occupancy issued isn't the end of the compliance story for ADU owners in San Jose. An unpermitted modification to an approved ADU can trigger complications when the property is sold and may affect the ability to pull future permits on the same parcel — a problem our team has helped clients navigate more than once.

Utility Connections and Metering

San Jose allows ADUs to share utility connections with the primary dwelling or to have separate meters installed. Most lenders require proof of separate utility metering for ADU rental income to count toward mortgage qualification — something worth confirming with a lender before the permit application is even submitted. Key items to address at permit closeout:

  • Water meter: document whether service is shared or separate with the relevant water provider
  • Gas meter: PG&E requires separate applications for meter additions, which have their own lead times
  • Electrical panel: confirm sub-panel sizing is documented in the permit record for future reference
  • Sewer lateral: inspect and document shared versus separate connection at project close

Our team also recommends that ADU owners add the new structure to their homeowner's insurance policy within 30 days of receiving the Certificate of Occupancy — most carriers require written notice, and coverage gaps during the transition period create unnecessary liability exposure.

Ongoing Owner Responsibilities

After approval, ADU owners in San Jose carry ongoing compliance responsibilities that aren't always spelled out in the permit documentation itself. Our post on the seasonal home maintenance checklist for San Jose homeowners covers the broader maintenance calendar that keeps both the primary home and ADU in good shape over time — including HVAC filter changes, smoke detector testing, and weatherproofing tasks that directly affect occupancy compliance.

Additional ongoing responsibilities to stay current on:

  • Maintaining smoke and carbon monoxide detectors per California residential code
  • Keeping egress windows clear, operable, and compliant with minimum opening dimensions
  • Notifying the city of any change in use — for example, from rental occupancy to owner-occupied
  • Retaining all permit records, inspection reports, and the Certificate of Occupancy in a permanent property file

Insider Tips for Faster ADU Permit Approval in San Jose

Our team has identified consistent patterns that separate ADU permit applications that sail through San Jose's review process from those that bounce back with correction after correction. Most of the difference comes down to documentation quality and contractor selection — two factors that are entirely within a project owner's control before the application is submitted.

Documentation That Moves Reviews Faster

Applications that come back clean on first plan check share a consistent set of characteristics:

  • Fully coordinated plan sets — architectural, structural, MEP, and Title 24 all submitted together with no conflicts between sheets
  • A detailed site plan drawn to scale showing all setbacks, utility easements, and lot coverage calculations
  • A soils report when the lot has any slope or sits in a liquefaction hazard zone — San Jose's seismic hazard maps are publicly available from the city
  • Pre-approval from utility providers before permit submission, not after — this catches service capacity issues before they become construction-phase surprises
  • A written narrative explaining any design exceptions or deviations from standard requirements, submitted alongside the plans

Confirming the contractor's licensing credentials before signing any agreement is equally critical. Our guide on how contractor licensing works in California explains what property owners should verify — and why an unlicensed contractor can void permit coverage and insurance protection entirely.

Choosing the Right Builder From the Start

A contractor's specific experience with San Jose's permit office matters more than most people realize when navigating the ADU permit San Jose process. A builder who has submitted dozens of ADU applications in San Jose understands which plan checkers prefer which documentation formats, how to write effective responses to correction comments, and when a direct call to the city is more productive than waiting for an online status update.

Before committing to any contractor, our guide on questions to ask before signing an ADU builder contract covers permit responsibility allocation, timeline expectations, and contingency clauses for permit delays — all of which belong in the contract before a shovel touches the ground. Asking specifically whether the contractor has completed permitted ADU projects in San Jose is one of the most reliable quality signals available, and our team considers local permit track record a core qualification, not a bonus credential.

The permit isn't the finish line — it's the foundation, and getting it right the first time determines how smoothly every phase of the build runs from here.

Related Posts

Two-Story ADU in the Bay Area: Design Ideas, Costs, and Regulations

Two-Story ADU in the Bay Area: Design Ideas, Costs, and Regulations

Plan, permit, and build a two-story ADU in the Bay Area with expert design ideas, cost breakdowns, a...

Read More →
ADU Size Limits and Setback Requirements in Bay Area Cities

ADU Size Limits and Setback Requirements in Bay Area Cities

Discover ADU size limits and setback requirements across Bay Area cities to plan your accessory dwel...

Read More →
How to Finance an ADU in the Bay Area: Loans, HELOCs, and Grants

How to Finance an ADU in the Bay Area: Loans, HELOCs, and Grants
