SB 9 Lot Split in the Bay Area: Requirements, Process, and Costs

An SB 9 lot split in the Bay Area gives qualifying single-family homeowners the legal right to divide their parcel into two separate lots without discretionary review — meaning no planning commission hearings, no neighborhood opposition votes, and no subjective approval criteria standing in the way. That one fact changes the math on Bay Area land ownership in a meaningful way. For property owners who have already worked through what it costs to build an ADU in San Jose, an SB 9 lot split opens a parallel path — one that creates an entirely new legal address rather than a subordinate unit on the same parcel.

SB 9 lot split Bay Area property diagram showing single-family parcel divided into two legal lots
Figure 1 — A qualifying single-family lot in the Bay Area divided into two separate legal parcels under California SB 9.

Senate Bill 9, now state law applicable across California, created two distinct rights for qualifying residential property owners: the right to split a single-family lot into two parcels and the right to build up to two units on each resulting parcel. In the Bay Area, where a bare lot in a desirable city routinely commands $500,000 or more, that combination carries serious financial weight. The law was designed to increase housing production without requiring formal rezoning, and it accomplishes that by removing discretionary approval from the process entirely — for applications that actually qualify.

What makes the process work, and what trips up applicants, is the eligibility checklist. Cities must approve a qualifying application by rule, but only when every requirement is satisfied. A single missing item doesn't just delay the project — it disqualifies it until the deficiency is resolved. Understanding those requirements before spending money on surveys and applications is the most important preparation any property owner can do.

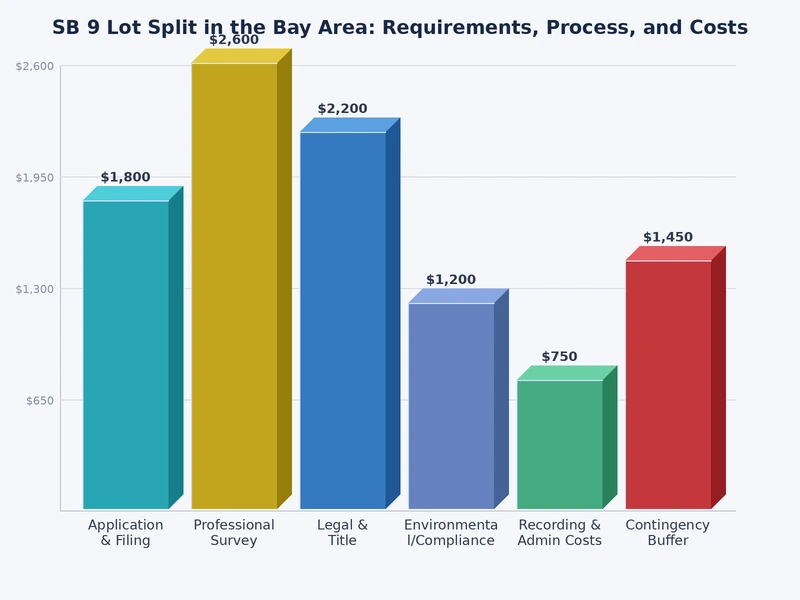

Bar chart showing SB 9 lot split cost breakdown across Bay Area cities including survey, fees, and utility separation
Figure 2 — Typical cost breakdown for an SB 9 lot split in the Bay Area, from survey through utility separation.

What SB 9 Lot Splitting Actually Allows

The law creates two rights that can be used together or independently. The urban lot split divides one single-family parcel into two, each of which must be at least 1,200 square feet. The two-unit right allows up to two units on each resulting parcel, which means a qualifying lot could theoretically support four units total. Most Bay Area applicants pursue the lot split specifically because it creates a new Assessor's Parcel Number (APN) — a legal address that can be sold, mortgaged, or developed completely independently of the original property.

SB 9 Split vs. an ADU: A Critical Distinction

An ADU sits on the same parcel as the primary home and cannot be sold separately as its own real estate. An SB 9 lot split eliminates that limitation by creating a second legal parcel with its own title, its own financing eligibility, and its own tax assessment. For homeowners whose goal is to monetize equity without becoming long-term landlords, this distinction is fundamental — the split path creates an asset that can be sold outright, while an ADU creates an asset permanently attached to the primary residence.

What Cities Can and Cannot Control

Cities retain authority over objective design standards: minimum lot dimensions, setback distances, maximum lot coverage, and parking requirements. What they cannot do is apply subjective review criteria — neighborhood character, compatibility with surrounding homes, or community opposition — to an SB 9 application. A complete and compliant SB 9 application must be approved ministerially, which is the defining legal protection the law provides. Several Bay Area cities tested that boundary early on and faced legislative pushback; the ministerial requirement has held firm.

The Requirements Every Bay Area Property Must Meet

For an SB 9 lot split in the Bay Area to qualify for ministerial processing, the property must satisfy a defined list of eligibility criteria established by state law. Cities can add objective standards on top of the state floor, but they cannot create eligibility requirements that conflict with or contradict state criteria.

Parcel Size and Configuration Rules

The original parcel must be large enough to produce two lots of at least 1,200 square feet each, and neither resulting parcel can be less than 40% of the original lot's total area. In practice, the original parcel generally needs to be at least 2,400 to 3,000 square feet, depending on its shape and existing structures. The property must also be zoned single-family residential (SFR) — the SB 9 lot split right applies specifically to SFR zones, not multi-family or mixed-use designations.

Location Restrictions That Can Disqualify a Property

Several overlay zones exclude properties from SB 9 eligibility regardless of zoning or lot size. These include high-fire hazard severity zones (HFHSZ) designated by the state, Alquist-Priolo earthquake fault zones, wetlands, prime farmland, and historic districts. In the Bay Area, the most common disqualifier is the Wildland-Urban Interface (WUI) overlay, which affects hillside neighborhoods in Berkeley, Oakland, and portions of San Jose. Checking parcel overlays through the county assessor's GIS portal before commissioning a survey prevents the most expensive kind of surprise.

The Owner-Occupancy Certification

The applicant must certify that they have occupied one of the units on the property as their primary residence for at least three years immediately prior to the application date. This is the most restrictive requirement in the law and the one that most effectively limits the program to genuine owner-occupants rather than investors. There is no waiver pathway — applicants who don't meet the three-year threshold must simply wait until they do.

How the Application Process Works

The ministerial nature of SB 9 approval doesn't mean the process is fast or simple — it means the city cannot say no to a qualifying application. The work of making that application complete and compliant falls entirely on the applicant, and the preparation phase before formal submission is where most projects succeed or fail.

Pre-Application Preparation

Before filing anything formal, property owners need a boundary survey to confirm existing lot lines and identify encumbrances — easements, setback violations, or utility crossings that could affect the proposed split line. A feasibility assessment with a qualified contractor or land-use professional at this stage is not optional for anyone serious about the project. Discovering a disqualifying overlay or an impossible utility separation after paying for a full survey is a costly way to learn what a preliminary check would have revealed for a fraction of the price.

Submitting a Complete Application

The formal submission goes to the city planning or building department, depending on the jurisdiction. Most Bay Area cities maintain dedicated SB 9 checklists that list required documents: parcel map, site plan, title report, proof of owner-occupancy, and completed application forms. Cities must act within 60 days of a complete submission. If the city misses that window, the application is automatically deemed approved — a provision that carries real weight in jurisdictions where permit processing runs slow.

Recordation and Utility Separation

After city approval, the parcel map is recorded with the county recorder's office, which officially creates the new legal parcel. The next phase — utility separation — is often the longest part of the entire project. Water, sewer, gas, and electric service each require independent connections to the new parcel, and coordinating four separate utility providers in dense Bay Area neighborhoods can take months. Property owners planning to build on the new parcel afterward benefit from reviewing the key questions to ask before signing a construction contract well before any builder engagement begins.

Understanding the True Costs

Most SB 9 lot splits in the Bay Area cost between $30,000 and $80,000 from start to recorded parcel map, but the actual figure for any given project depends heavily on city-specific fees, existing site conditions, and the complexity of utility separations. The table below breaks down where that money typically goes.

Cost CategoryTypical RangeNotes
Boundary Survey$3,500–$8,000Required before application; cost varies by lot complexity and city
Parcel Map Preparation$4,000–$10,000Civil engineer or licensed surveyor; includes recordation documents
City Application Fees$2,000–$8,000Varies significantly by city; some jurisdictions have waived certain fees
Impact Fees (new parcel)$5,000–$25,000+School, park, and infrastructure fees; can be the largest single line item
Utility Separation$8,000–$30,000Water, sewer, gas, electric; trenching cost depends heavily on site conditions
Legal and Title Work$3,000–$7,000Title report, deed preparation, lender consent if an existing mortgage applies

The Cost That Surprises Nearly Every Applicant

City impact fees — charges assessed on new development to fund schools, parks, and infrastructure — are routinely the largest single surprise in an SB 9 project budget. Some Bay Area cities treat the new SB 9 parcel as equivalent to a new residential lot for impact fee purposes, which can add $15,000 to $25,000 in one line item. Requesting an impact fee estimate from the city planning department before submitting an application is a simple step that most applicants skip and later regret deeply.

When an SB 9 Lot Split Makes Financial Sense

The financial case is strongest in high-demand Bay Area cities where bare land commands premium prices. In cities like Sunnyvale, San Jose, or Fremont, a new legal parcel with enough footprint for a full home routinely sells in the $500,000 to $900,000 range, depending on neighborhood and lot size. Against an all-in split cost of $50,000 to $70,000, that return is compelling — and the project requires no construction whatsoever on the new parcel.

Before running the numbers on any SB 9 lot split, confirm the resulting parcel is large enough to attract a buyer — a parcel under 3,000 square feet in a setback-heavy city may be technically legal but commercially unattractive to most builders.

Property Types Where the Numbers Work

Property owners with large corner lots, wide rectangular parcels, or lots deeper than 120 feet tend to have the strongest cases. These configurations allow both resulting parcels to have independent street access and adequate setbacks on all sides, leaving enough buildable area for a full-sized home on each. Adding a structure to the new parcel rather than selling it bare multiplies the return considerably. That same value-creation logic applies directly to compact parcels, explored in detail in resources on open floor plan ADU designs that maximize small spaces.

When the Numbers Don't Justify the Effort

Smaller lots in lower-demand zip codes, lots with significant slope, or properties near the edges of disqualifying overlays often don't generate enough value on the new parcel to justify the cost and complexity of the split. If the resulting parcel is constrained by setbacks to the point where only a modest structure fits, buyers discount the price accordingly. Running a conservative value estimate before starting — not an optimistic one — is the discipline that separates financially successful SB 9 projects from disappointing ones.

Common Obstacles and How to Overcome Them

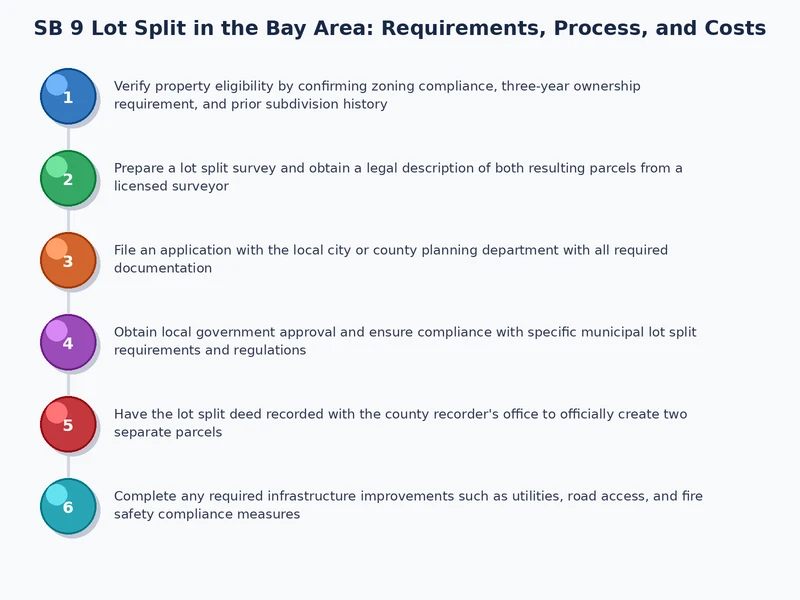

SB 9 lot split Bay Area application process flow diagram from feasibility check through county parcel map recordation
Figure 3 — The SB 9 lot split process from initial feasibility through county recordation of the new parcel.

Most SB 9 projects that stall do so for predictable reasons, and nearly all of them could have been caught before the formal application was filed. The most common problems fall into three categories: utility complications, documentation gaps, and financing friction.

Utility Connection Problems

In established Bay Area neighborhoods, utility laterals (the pipes and conduits connecting a property to the street) were installed decades ago to serve a single address. Splitting them into two independent service connections sometimes requires more work than the original survey suggested. Discovering that a sewer lateral runs diagonally under a concrete driveway — or that water main pressure is insufficient to support two meters — after the parcel map has been submitted can halt a project for months. A utility pre-feasibility check with each provider before the application is filed costs nothing and prevents the most common hard-cost surprises.

HOA and Neighbor Friction

Homeowners' associations cannot legally block an SB 9 lot split — state law preempts HOA CC&Rs (covenants, conditions, and restrictions) on this specific issue. HOAs can still enforce design standards that apply to structures built on both parcels after the split, which may constrain what gets built on the new lot. Neighbors have no formal standing to object during ministerial review, but they can file complaints or request additional inspections that slow the construction phase. A complete, professionally prepared application that gives the city nothing to question is the most effective response to that kind of pressure.

Financing and Title Complications

Property owners with an existing mortgage need lender consent before adjusting lot lines, and some lenders process these requests slowly because SB 9 transactions remain uncommon in standard lending workflows. Working with a title company and a real estate attorney who have closed SB 9 transactions before is worth the added cost. The learning curve on a novel transaction type falls on whoever goes through it first, and experienced professionals have already paid that cost on someone else's project.

An SB 9 lot split in the Bay Area is one of the most powerful land-value tools available to long-term homeowners — but only for those who do the eligibility homework before they do anything else.

Related Posts

Two-Story ADU in the Bay Area: Design Ideas, Costs, and Regulations

Two-Story ADU in the Bay Area: Design Ideas, Costs, and Regulations

Plan, permit, and build a two-story ADU in the Bay Area with expert design ideas, cost breakdowns, a...

Read More →
ADU Size Limits and Setback Requirements in Bay Area Cities

ADU Size Limits and Setback Requirements in Bay Area Cities

Discover ADU size limits and setback requirements across Bay Area cities to plan your accessory dwel...

Read More →
How to Finance an ADU in the Bay Area: Loans, HELOCs, and Grants

How to Finance an ADU in the Bay Area: Loans, HELOCs, and Grants

Explore ADU financing options in the Bay Area, including home equity loans, HELOCs, construction loa...

Read More →

Ready to Start Your Project?

Contact us today for a free consultation and estimate.

Get Started
