How Long Does a Bathroom Remodel Take in the Bay Area?

Planning a renovation and wondering how long does a bathroom remodel take before the dust settles and life returns to normal? The honest answer: anywhere from one week to three months—depending on scope, permits, and contractor availability in the Bay Area. Understanding the full picture upfront helps homeowners budget their time, not just their money. A good starting point is reviewing the complete range of bathroom remodeling options available before setting any timeline expectations.

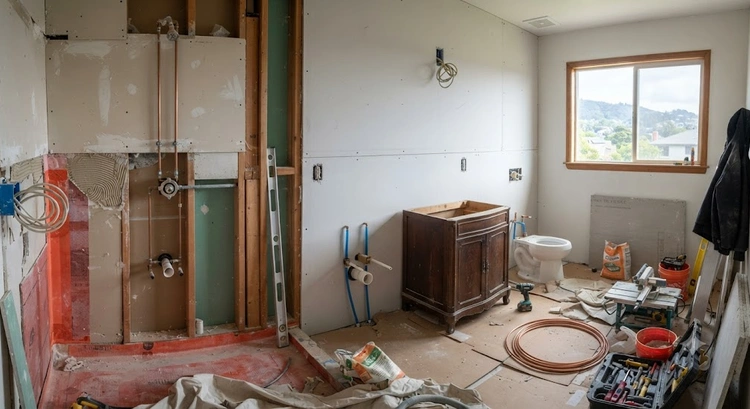

bathroom remodel timeline in the Bay Area showing phases from planning through final inspection
Figure 1 — A Bay Area bathroom remodel moves through distinct phases, each with its own timeline variables and local permit requirements.

A cosmetic refresh—new fixtures, paint, and a vanity swap—wraps in five to seven business days. A full gut renovation touching plumbing, electrical, tile, and layout stretches to eight or ten weeks. The difference lies entirely in the decisions made before demolition begins. This guide breaks down realistic timelines for every scope of bathroom remodel in the Bay Area, from a quick powder room facelift to a primary suite transformation, and explains what drives the schedule at each stage.

The Bay Area's older housing stock—much of it built between the 1940s and 1980s—adds another layer of complexity. Lead paint, galvanized pipes, and outdated electrical panels frequently surface once walls open up, adding days or weeks to any schedule. Knowing the most common surprises before they happen is half the battle.

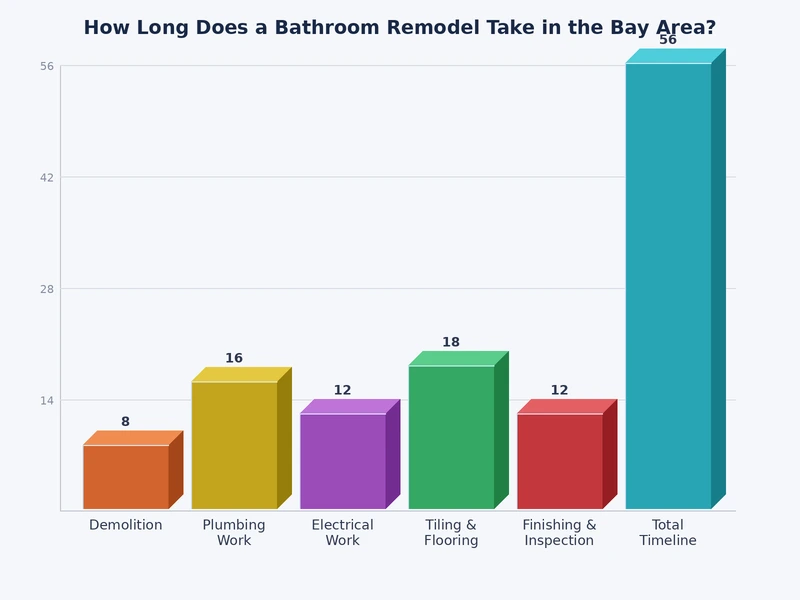

chart showing average bathroom remodel duration by project scope in Bay Area homes
Figure 2 — Average bathroom remodel duration by project scope in Bay Area homes, from cosmetic refresh to full gut renovation.

How Long Does a Bathroom Remodel Take? A Scope-by-Scope Breakdown

The most common question Bay Area contractors field is: how long does a bathroom remodel take for a project like mine? The answer depends almost entirely on scope. There is no universal timeline, but there are reliable ranges tied to project complexity and permit requirements.

Project Scope Typical Duration Permit Required? Common Bay Area Complications
Cosmetic refresh (fixtures, paint, vanity) 5–7 business days Usually no Aged hardware requiring special-order parts
Mid-range tile + fixtures (no layout change) 2–4 weeks Sometimes Tile lead times, subfloor rot
Full gut with plumbing/electrical relocation 6–10 weeks Yes Permit delays, inspector scheduling gaps
Primary suite expansion or structural addition 3–4 months Yes Structural work, utility rerouting, plan check

These ranges assume a contractor is already booked and materials are selected. Factor in a pre-construction lead time of two to six weeks before any physical work begins—this window covers design finalization, permit applications, and material procurement. Skipping this phase is the single most common reason projects run long.

The Permit Factor in Bay Area Cities

In cities like San Jose, Oakland, and San Francisco, permit timelines vary meaningfully. San Jose's Building Division typically processes over-the-counter permits in one to three business days for straightforward bathroom work. Projects requiring plan check—those involving structural changes, plumbing relocation, or electrical panel work—can wait three to six weeks for approval. That waiting period is dead time on the project calendar, and it cannot be compressed by the contractor.

Bay Area Project Timelines: What Homeowners Actually Experience

Real projects rarely match textbook estimates. Here are three representative scenarios from Bay Area homes that illustrate what realistic timelines look like on the ground.

The Powder Room Flip

A half-bath in a 1960s Sunnyvale ranch home received a new vanity, faucet, mirror, and fresh tile floor. No plumbing relocation, no structural changes, no permit required. The contractor completed the project in six business days. The only delay: waiting three days for a specialty faucet that was backordered from the distributor. The lesson—confirm stock availability before the contractor shows up on day one.

The Tile-and-Fixtures Overhaul

A full bathroom in a San Jose split-level received new tile throughout, a walk-in shower conversion from an existing tub-shower combo, and a new double vanity. No walls moved. The permit took four business days. Total project duration: three and a half weeks. The contractor attributed the efficiency to having all materials delivered to the site before demolition day—zero waiting for supply deliveries mid-project.

The Full Gut in an Older Oakland Home

A primary bathroom in a 1952 Oakland bungalow required galvanized pipe replacement, a GFCI electrical upgrade, new cement board subfloor, full tile installation, and a custom shower niche. Permit approval took 18 business days due to the plumbing scope. Once approved, active construction ran six weeks. Total timeline: nine weeks from permit submission to final inspection. The extended permit wait was unavoidable given the scope—but having materials pre-ordered meant zero idle time once work began.

Pro tip: Always maintain access to a secondary bathroom during a full gut remodel—Bay Area permit inspections routinely create three to five-day gaps between work phases while waiting for an inspector's available slot.

Matching Remodel Scope to the Right Situation

Not every bathroom needs a full gut renovation. Choosing the right level of intervention saves time and money—and prevents over-building for the neighborhood or the home's current condition.

When a Cosmetic Refresh Makes Sense

  • The existing plumbing layout works well and pipes are in good condition
  • The homeowner plans to sell within a few years and wants a quick value boost
  • Budget is constrained but visual impact is the priority
  • The tile is dated but structurally sound—paint, fixtures, and lighting can transform the feel without touching the substrate

For smaller bathrooms, a cosmetic refresh paired with smart design choices delivers outsized impact. The guide on small bathroom remodel ideas for Bay Area homes covers practical strategies that maximize space without expanding square footage or triggering a full permit process.

When a Full Gut Is the Right Call

  • Persistent moisture damage, mold, or soft spots in the subfloor are present
  • Plumbing is galvanized or cast iron and approaching the end of its service life
  • The layout is functionally inefficient—awkward door swings, undersized shower, cramped fixture arrangement
  • The homeowner is planning a broader home remodel and the bathroom is already part of the disruption

Older Bay Area homes frequently reveal hidden moisture issues once demolition opens the walls. Understanding how to prevent mold in Bay Area homes applies both during the construction phase and for long-term protection of the finished remodel.

What Speeds Up—and What Delays—a Bay Area Remodel

Timeline control comes down to managing variables on both sides: the factors that accelerate a project and the ones that stall it before a nail is driven.

Factors That Accelerate the Timeline

  • Pre-selected and pre-ordered materials — tile, fixtures, and vanities ordered before demolition eliminate the most common mid-project delay
  • A single general contractor managing all trades reduces scheduling friction between plumbing, electrical, and tile subcontractors
  • Simple rectangular layouts with standard fixture sizes require less custom cutting and fitting time
  • Over-the-counter permits for non-structural work are issued same-day at some Bay Area building departments

Factors That Slow the Timeline

  • Permit delays — plan-check projects in congested municipal queues can wait three to six weeks for approval, and that time cannot be recaptured
  • Discovery of asbestos-containing floor tile (common in Bay Area homes built before 1980) triggers mandatory abatement before demolition can continue
  • Special-order tile or custom vanities with eight to twelve-week lead times push start dates out significantly
  • Mid-project design changes—the most avoidable delay category—add one to two weeks per change order as materials are returned, reordered, and rescheduled
  • Inspector scheduling gaps between rough-in and finish phases insert non-working days into the calendar that no contractor can control

Keeping Your Project on Schedule: A Step-by-Step Approach

A well-managed bathroom remodel follows a predictable sequence. Deviating from this order—or skipping steps to save time upfront—is the primary cause of avoidable delays.

Step 1: Finalize All Design Selections Before Breaking Ground

Every tile, fixture, vanity, faucet, and accessory should be selected and ordered before demolition begins. Material procurement is the most controllable delay variable in any remodel, and it is entirely avoidable with advance planning. Give tile orders a minimum of four weeks before the scheduled installation date and confirm availability in writing with the supplier.

Step 2: Pull the Permit Before the Start Date

Submit permit applications as soon as construction documents are ready—before the contractor's scheduled start date. In most Bay Area cities, applications can be submitted online. The permit clock starts on submission day, not on contractor start day. Projects that submit permits in parallel with final design work instead of sequentially after it can save two to four weeks of calendar time.

Step 3: Schedule Inspections Proactively

Bay Area building departments often book inspections several days out. Contractors who request inspections the moment a phase is complete—rather than waiting until the next phase is ready to start—compress the dead time between phases. This habit alone can save up to a week on a full gut project.

Step 4: Build a One-Week Contingency Buffer Into Every Timeline

Every bathroom remodel timeline should include a written contingency buffer for discovery issues—cracked joists, outdated wiring, or supply delays. Homeowners who treat the estimated completion date as a floor rather than a ceiling avoid the friction that turns a single unexpected day into a week-long setback in attitude and contractor relations.

Step 5: Communicate Daily with the Lead Contractor

A brief daily update—even a text summary of what was completed and what comes next—keeps both parties aligned and surfaces issues while they are still small. Problems caught on day two cost far less to resolve than problems discovered on day fourteen when work has already built on a flawed assumption.

Caring for Your New Bathroom After the Remodel

The remodel timeline ends at final inspection, but protecting the investment requires consistent maintenance in the months and years that follow. A well-maintained bathroom holds its value; a neglected one repeats the cycle prematurely.

Grout and Caulk Maintenance

Grout lines in shower enclosures should be sealed within 30 days of installation and resealed annually. Caulk at the tub-wall junction is the first line of defense against water infiltration—inspect it every six months and replace any cracked or separating sections immediately. This single maintenance step prevents the subfloor damage that leads to another costly renovation ahead of schedule.

Ventilation Requirements

Bathroom exhaust fans should run for 15 to 20 minutes after every shower to evacuate moisture from the space. Inadequate ventilation is the leading cause of mold growth in remodeled bathrooms, particularly in the Bay Area's mild but occasionally humid climate. Replace the fan if it is more than ten years old or audibly struggling—modern units move more air at lower noise levels and draw less electricity.

Fixture and Hardware Care

  • Clean showerheads with a vinegar soak every six months to prevent mineral buildup from Bay Area water
  • Check supply line connections under vanities annually for slow drips before they become visible water damage
  • Lubricate hinges on frameless glass shower enclosures twice a year to prevent rust streaks on tile
  • Inspect grout along the floor perimeter annually and re-grout any cracking sections before moisture finds a path beneath the tile

Best Practices Bay Area Contractors Recommend

Experienced Bay Area contractors have refined their approaches through hundreds of projects. The practices below separate smooth, on-schedule remodels from drawn-out, dispute-prone ones—consistently.

Prioritize Contractors with Local Permit Experience

A contractor familiar with San Jose's building department workflow, Oakland's inspection scheduling quirks, or San Francisco's permit portal submits accurate applications that avoid rejection-and-resubmission cycles. Local experience is not a luxury—it is a measurable, quantifiable timeline advantage that shows up in days saved during the permit phase alone.

Use a Detailed Contract with Milestone-Based Payment

The contract should specify materials by manufacturer, model number, and finish. Payment terms should be tied to project milestones—demolition complete, rough-in inspected, tile set, final inspection passed—not to calendar dates. Vague contracts are the leading cause of both disputes and project delays in residential remodeling. A contract that describes tile as "white subway tile" without specifying size, manufacturer, and grout color leaves room for expensive disagreements.

Verify Licensing and Insurance Before Signing Anything

California requires all general contractors to hold a valid CSLB license. Verify license status at the CSLB website and confirm the contractor carries general liability and workers' compensation insurance. Unlicensed contractors cannot legally pull permits—meaning any work completed without permits cannot be inspected, and that unpermitted work will surface as a liability at the time of sale.

Never Rush the Sequencing of Trades

Plumbing rough-in must pass inspection before walls close. Electrical rough-in follows. Tile cannot go on walls until cement board is installed and waterproofing is applied and fully cured. Rushing any of these sequences to save a single day creates a defect that costs a week to correct—plus the cost of undoing finished work to access the problem beneath it.

Frequently Asked Questions

Does a bathroom remodel add value to a Bay Area home?

A mid-range bathroom remodel typically returns 60 to 70 percent of its cost in added home value in Bay Area markets, according to industry data. Full gut renovations in primary bathrooms tend to deliver the strongest returns, particularly in neighborhoods where comparable homes already feature updated bathrooms.

Can a bathroom remodel be done while the home is occupied?

Yes, in most cases—provided the home has at least one additional functioning bathroom. Full gut remodels make the primary bathroom unusable for the duration of active construction, typically four to eight weeks. Cosmetic refreshes may restore functionality within a day or two between phases.

What is the most common cause of bathroom remodel delays in the Bay Area?

Permit processing time for projects requiring plan check is the most common source of schedule delays that contractors cannot control. Material lead times—particularly for special-order tile and custom vanities—rank second. Both are manageable with advance planning before the contractor's start date is set.

Next Steps

  1. Determine the project scope—cosmetic refresh, mid-range tile and fixtures, or full gut renovation—before contacting any contractors. This single decision sets the realistic timeline range and the permit requirements that will govern the project calendar.
  2. Research permit requirements for the specific Bay Area city where the project will occur. Check the local building department's website to confirm whether the planned scope triggers a building permit and what current processing times look like for over-the-counter versus plan-check submissions.
  3. Select and order all materials—tile, fixtures, vanity, faucet, and accessories—before signing a construction contract. Confirm lead times with suppliers in writing and verify that preferred items are in stock or can arrive before the scheduled installation date.
  4. Request itemized bids from at least three licensed Bay Area contractors, verify each contractor's CSLB license status online, and confirm that workers' compensation and general liability insurance are current before signing any agreement.
  5. Schedule a walkthrough consultation with a bathroom remodeling specialist to assess the existing space, identify hidden risks specific to the home's age and construction, and establish a realistic project timeline before any commitments are made.

Related Posts

Master Bathroom Remodel Ideas for Bay Area Homes

Master Bathroom Remodel Ideas for Bay Area Homes

Transform your master bathroom with Bay Area-inspired remodel ideas that blend modern design, natura...

Read More →
Kitchen Flooring Options: Best Materials for Bay Area Homes

Kitchen Flooring Options: Best Materials for Bay Area Homes

Discover the best kitchen flooring options for Bay Area homes, from durable hardwood to moisture-res...

Read More →
Permits for Bathroom Remodeling in San Jose: What You Need to Know

Permits for Bathroom Remodeling in San Jose: What You Need to Know

Navigating San Jose bathroom remodel permits doesn't have to be stressful—learn exactly which permit...

Read More →

Ready to Start Your Project?

Contact us today for a free consultation and estimate.

Get Started
