Solar Panel Integration When Building an ADU in San Jose

Can you power a brand-new ADU entirely from rooftop solar in San Jose? Yes — and the real question is why you'd build one without it. Solar panels ADU San Jose permit applications are stacking up fast across Willow Glen, Blossom Valley, and East San Jose. PG&E's time-of-use rates keep climbing. California's energy code already nudges new construction toward greater efficiency. A solar-integrated ADU isn't just greener — it rents higher, appraises better, and costs less to operate every single month. If you're building with 9Builders, solar belongs in the conversation from day one — not as a last-minute add-on, but as a core design decision.

This guide walks you through the long-term financial case, the step-by-step integration process, the mistakes that cost owners real money, the honest tradeoffs, and what to do when things go sideways after installation.

Solar panels installed on a detached ADU rooftop in a San Jose residential neighborhood
Figure 1 — Rooftop solar array on a newly completed detached ADU in San Jose's Willow Glen neighborhood
Chart comparing estimated solar energy production versus typical ADU energy demand by season in San Jose
Figure 2 — Seasonal solar production versus estimated ADU energy demand in San Jose for a typical 3–4 kW system

Why Solar Is a Long-Term Win for Your ADU

The Financial Case

PG&E's E-ELEC time-of-use rates have increased significantly over the past decade, and there's no structural reason to expect that trend to reverse. When you add solar at build time, you're locking in your energy cost now. Think of it as prepaying decades of electricity at a fixed rate, minus the compounding increases you'd otherwise absorb year after year.

A typical one-bedroom ADU in San Jose draws roughly 6–8 kWh per day. A 3–4 kW rooftop system offsets most of that load during daylight hours. Under NEM 3.0, the economics shifted significantly — export compensation dropped about 75% compared to NEM 2.0. That changes the optimal strategy. Self-consumption is where the value lives now, not grid export. Size your system to cover your ADU's actual usage, not to push excess into the grid at low rates.

Your ADU is an income-generating asset. A solar-powered unit lets you market lower utility costs to prospective tenants — or absorb the bill and bake it into the rent. Either approach strengthens your rental position. Our guide on designing ADU floor plans for maximum rental income covers the layout decisions that compound this advantage further.

Property Value Impact

Lawrence Berkeley National Laboratory research consistently shows California solar systems adding $3–4 per watt of installed capacity to home value. On a 4 kW system, that's $12,000–$16,000 in added value. Your ADU doesn't have a separately assessed value from the main parcel in most cases, but appraisers factor in rental income potential and energy performance when evaluating the full property. The well-documented impact of improvements on Bay Area property value is especially strong when a solar system is visible, modern, and warrantied.

Solar added during construction costs 20–30% less than a retrofit after the fact. The conduit runs, roof penetrations, and electrical panel upgrades are already open — that window closes the moment your ADU is dried in.

How to Integrate Solar Panels for Your ADU in San Jose, Step by Step

Design Phase Decisions

Start with roof orientation. South-facing planes at 15–25° pitch maximize annual output at San Jose's latitude (37°N). West-facing slopes are a solid second choice — they shift peak production into PG&E's peak TOU window (4–9 PM), which carries value under NEM 3.0's export rate structure. Flat roofs accept adjustable ballasted racking with no structural modification required.

Decide on battery storage early. A 10–13.5 kWh AC-coupled battery — Enphase IQ5P, Tesla Powerwall 3, or Franklin WH — pairs well with a small ADU system. Batteries buffer NEM 3.0's low export credits and provide backup during the grid outages that have grown more common across the South Bay. This is also the right phase to coordinate your insulation spec, window glazing, and HVAC sizing — a tighter building envelope means you can right-size the PV system downward without sacrificing comfort. Our overview of eco-friendly building materials for Bay Area homes is a good reference for envelope decisions that interact with solar load calculations.

Permit Coordination in San Jose

San Jose Building Division processes solar permits through the ePlans portal. For new ADU construction, include the solar system in the original permit set — not as a separate application filed later. One plan set, one review cycle. Your contractor submits structural, electrical, and PV layout drawings together. This is cleaner and typically faster than pulling a standalone solar permit after the ADU certificate of occupancy is issued.

CALGreen compliance and Title 24 energy requirements apply to all new ADUs in San Jose. A properly sized PV array can offset other prescriptive compliance requirements in the Title 24 energy calculations — work with an energy consultant who knows how San Jose's plan checkers interpret the compliance worksheets. Before finalizing your design, also confirm your siting against ADU setback requirements in the Bay Area — rear yard constraints can limit where a detached unit sits and, by extension, which direction its roof faces. If an HOA has jurisdiction over your property, check HOA approval requirements for ADUs early; California's Solar Rights Act limits an HOA's ability to block solar outright, but aesthetic conditions can add review cycles.

System Sizing Reference

ADU Size Daily Usage Recommended System Installed Cost (pre-ITC) Est. Annual Savings
Studio (under 400 sq ft) 4–5 kWh 2–2.5 kW $8,000–$10,500 $600–$900
1-Bedroom (400–650 sq ft) 6–8 kWh 3–4 kW $12,000–$16,000 $900–$1,350
2-Bedroom (650–1,000 sq ft) 9–12 kWh 4–5 kW $16,000–$20,000 $1,200–$1,800
2-Bed + Battery Storage 9–12 kWh 4–5 kW + 10 kWh battery $26,000–$32,000 $1,400–$2,200

Don't let a contractor undersize the system to lower the bid price. A 2.5 kW array on a 700 sq ft ADU with a mini-split sounds plausible on paper — but it leaves you fully grid-dependent every evening at peak rates.

Solar Mistakes ADU Owners Regret

Ignoring the Roof in the Design Phase

Treating solar as a finish item is the most common and most costly mistake. By the time your roof is framed, sheathed, and dried in, the orientation and pitch are fixed. If those decisions weren't made with a PV array in mind, you're stuck with a compromised layout for the life of the system. East-facing slopes, excessive penetrations from HVAC equipment, or shading from an adjacent two-story structure can cut annual output by 20–40%.

Detached ADUs give you the most flexibility. The roof is fully independent of the main house, so you control the ridge orientation entirely. Raise this with your designer before any structural drawings are finalized. It costs nothing at the design stage and makes a compounding difference over a 25-year system lifespan. The green building requirements for Bay Area new construction also reward passive solar orientation decisions that naturally dovetail with PV placement.

Misreading NEM 3.0

NEM 3.0 took effect for new interconnection applications in April 2023. Export compensation dropped roughly 75% from NEM 2.0 levels. That doesn't kill solar economics for ADU owners — it reshapes them. Under NEM 2.0, oversizing and exporting excess power was financially smart. Under NEM 3.0, self-consumption drives the returns. Right-size your system to your actual load profile. Add a battery if your rate structure supports the added cost. Don't let a solar company quote a 6 kW system for a 450 sq ft studio — that oversizing won't pay back under current export rates.

Weighing the Solar Tradeoffs

What Works in Your Favor

San Jose gets over 260 sunny days per year. That's a meaningful production advantage over the coastal fog belt, and it means your system consistently produces close to its rated annual output. The federal Investment Tax Credit covers 30% of installed costs through 2032 — on a $15,000 system, that's $4,500 back on your federal return. California's property tax exclusion applies to solar equipment, so the value it adds to your home isn't taxed back at assessment time.

Financing solar through your ADU construction loan is often the most efficient path. You're borrowing at construction-to-perm rates rather than higher solar-specific financing products. Our overview of home addition and ADU financing options in the Bay Area covers the construction-to-perm loan structures that absorb solar costs cleanly alongside the ADU build budget.

What to Watch Out For

Solar adds permit complexity and typically 8–12% to your ADU construction budget at current installed prices. PG&E's interconnection queue can add 4–12 weeks to your timeline after inspection. If you sell the property within five to seven years of installation, you may not fully recapture the upfront investment — though the property value premium and ITC offset much of that risk. The U.S. Department of Energy's homeowner guide to the federal solar tax credit lays out exactly which costs qualify and how to claim the credit correctly.

If your ADU tenant uses most of their electricity at night, rooftop solar alone won't reduce their bill much. Pair the system with a battery or structure the lease so utilities remain the owner's responsibility.

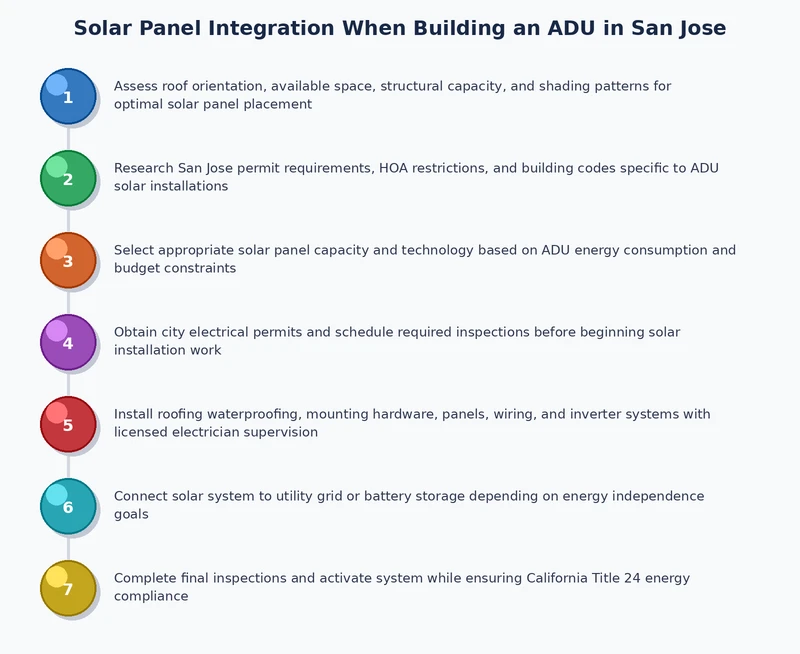

Step-by-step process diagram showing solar panel integration phases during ADU construction in San Jose
Figure 3 — Solar integration process from initial ADU design through PG&E Permission to Operate

When Solar Doesn't Go As Planned

PTO Delays from PG&E

Permission to Operate (PTO) is PG&E's final authorization to activate your solar system. Their interconnection queue has historically run 4–12 weeks after the building inspection sign-off. Your ADU is fully occupiable before PTO is granted — tenants can move in, appliances run on grid power as normal — but the solar system must stay physically off until PG&E issues the PTO letter. Build a buffer into your lease start date. Don't promise a tenant "solar from move-in" unless you have PTO documentation in hand.

Shading and Output Gaps

If post-installation shading from a neighbor's new addition, a maturing tree, or a rooftop HVAC condenser is cutting into your production, your options after installation are expensive. Microinverters or DC optimizers — Enphase IQ8 series or SolarEdge power optimizers — handle partial shading far better than traditional string inverters. Specify module-level power electronics at the design stage for any roof with foreseeable shading risk. A professional shading analysis during design runs a few hundred dollars. Repositioning a mounted and wired array costs several thousand. The math on prevention is obvious.

Frequently Asked Questions

California's Title 24 energy code mandates solar-ready construction for most new low-rise residential buildings, including ADUs that meet certain size thresholds. Whether a full PV system is required depends on the ADU's square footage, configuration, and whether it shares a meter with the primary dwelling. Attached ADUs under 500 sq ft often benefit from exemptions. Your designer and energy consultant will run the compliance calculations to determine exactly what's required for your specific project in San Jose.
A 600 sq ft one-bedroom ADU with a mini-split heat pump, efficient appliances, and LED lighting typically uses 6–8 kWh per day. A 3–3.5 kW system covers most of that load during daylight hours in San Jose's climate. Under NEM 3.0, the goal is to match system size to self-consumption, not to maximize export. If you add a 10 kWh battery, a 3 kW array effectively covers most of the unit's 24-hour load cycle.
Expect solar to add 8–12% to your ADU's total construction budget, depending on system size and whether you include battery storage. A standalone 3–4 kW system runs $12,000–$16,000 installed before the 30% federal ITC, which brings your net cost to $8,400–$11,200. Adding a 10 kWh battery adds $10,000–$14,000 before the ITC (batteries also qualify). When solar is bundled into a construction loan, the effective monthly cost is often lower than you'd expect given the financing rate.
Yes. Construction-to-perm loans, HELOCs, and cash-out refinance products all accommodate solar costs when they're part of the ADU project scope. The cleanest approach is including solar in your original construction contract so it draws from the same loan as the rest of the build. Lenders evaluate the full project value, and a solar-equipped ADU supports a stronger appraisal, which can help with loan sizing. Standalone solar financing products like Mosaic or GoodLeap are also available but typically carry higher rates than construction financing.
NEM 3.0 (Net Energy Metering 3.0) is PG&E's current export compensation structure, effective April 2023 for new interconnection applications. It reduced the retail credit for solar power exported to the grid by approximately 75% compared to NEM 2.0. The financial impact is that oversizing a solar system to export excess power is no longer profitable. Systems should be sized to maximize self-consumption. Battery storage becomes more attractive under NEM 3.0 because it shifts daytime solar production into peak evening hours when grid power is most expensive.
A battery isn't strictly required, but it adds significant value under NEM 3.0. Without storage, any solar power your ADU doesn't consume immediately gets exported at low NEM 3.0 rates. With a 10–13.5 kWh battery, that same power is stored and discharged during evening peak hours, effectively replacing grid power at full retail rates. The ROI on battery storage improved materially when NEM 3.0 took effect. If your ADU tenants are home in the evenings, battery storage is worth a serious look.
When solar is included in the original ADU permit set, review timelines mirror the ADU permit itself — typically 4–10 weeks for San Jose Building Division depending on project complexity and current queue volume. After construction is complete and the system passes final inspection, PG&E's interconnection (Permission to Operate) process adds another 4–12 weeks. Your ADU can be occupied during the PTO wait, but the solar system must remain off until PG&E issues the PTO authorization letter. Total timeline from permit submission to live solar: plan for 4–6 months.
California's Solar Rights Act (Civil Code §714) significantly limits HOA authority to block solar installations. An HOA cannot outright prohibit solar panels on your property. They can impose reasonable aesthetic restrictions — panel placement, color of mounting hardware, wiring visibility — as long as those conditions don't increase cost by more than $1,000 or reduce system output by more than 10%. In practice, most HOAs in San Jose process solar approvals routinely. Submit your plans proactively, show clean mounting details, and most HOA review boards approve without issue.

Next Steps

  1. Talk to your ADU designer or architect now — before any structural drawings are finalized — about roof orientation, ridge direction, and eliminating any potential shading sources from the layout.
  2. Get two or three bids from licensed California solar contractors who have experience with new ADU construction; ask specifically about NEM 3.0 system sizing and module-level power electronics for shading mitigation.
  3. Run a construction loan scenario that includes solar and battery storage costs so you can compare the all-in monthly payment against your projected rental income and utility savings.
  4. If your property is in an HOA, submit a preliminary solar layout to the architectural review committee early — before permit submission — to surface any aesthetic conditions that could require redesign.
  5. Confirm your Title 24 energy compliance path with an energy consultant who knows San Jose's plan check process, and verify how a properly sized PV array interacts with your ADU's prescriptive compliance requirements.

Related Posts

Title 24 Energy Code Compliance for Bay Area Home Additions

Title 24 Energy Code Compliance for Bay Area Home Additions

Meet Bay Area Title 24 energy code requirements for your home addition with expert guidance on insul...

Read More →
