San Jose Building Permits: Requirements, Fees & Timeline
Navigating building permits in San Jose is a critical part of any construction or remodeling project. Permits protect homeowners by ensuring work meets safety codes, they protect property values, and they are required by law. Yet the permit process is one of the most misunderstood and frequently underestimated aspects of construction projects in the Bay Area.
This guide explains what permits are required for common residential projects, how much they cost in San Jose, how long the process takes, and how to avoid the most common permit pitfalls.
What Requires a Permit in San Jose?
The following projects almost always require building permits in San Jose. This list is representative, not exhaustive — when in doubt, contact the San Jose Building Division or ask your licensed contractor.
- New construction of any kind
- Additions — room additions, second stories, ADUs
- Structural changes — removing or adding walls, modifying load-bearing elements
- Electrical work — new circuits, panel upgrades, service changes, EV charger installations
- Plumbing work — new plumbing, relocating fixtures, water heater replacements
- Mechanical work — new HVAC systems, ductwork changes, new gas appliances
- Roofing — full replacements (re-roofing over existing layers typically does not, but a full tear-off does)
- Pools and spas
- Decks over 30 inches above grade
- Retaining walls over 3 feet
- Solar panel installations
- Window replacements if they change the opening size
What Does NOT Require a Permit?
Many common homeowner projects do not require permits in San Jose:
- Interior painting
- Floor covering replacement (carpet, hardwood, LVP on existing subfloor)
- Cabinet replacement (same location, no plumbing or electrical changes)
- Fixture replacements in-kind (same location, same capacity)
- Fences under 6 feet
- Simple landscaping without drainage modifications
- Like-for-like window replacements in the same opening
How Much Do Permits Cost?
How Fees Are Calculated
San Jose building permit fees are primarily based on the valuation of the work being done. The city uses a fee schedule that applies a percentage to the declared construction value, with additional flat fees for plan review, inspections, and various ancillary charges (school fees, seismic, green building, traffic impact in some cases). For residential projects, total permit fees typically run 3 to 10 percent of declared construction value, depending on project type.
ADU Permit Fees
California state law caps ADU permit fees at the actual cost of providing the service for ADUs under certain size thresholds. San Jose has implemented reduced fee structures for ADUs consistent with state requirements. A standard detached ADU under 1,000 square feet can expect permit fees of $4,000 to $9,500 — significantly lower than fees for a comparable room addition of the same size.
Permit Timeline
Understanding permit timelines is critical for project scheduling. San Jose Building Division review times vary significantly by project type:
- Simple residential permits (electrical, plumbing, mechanical replacements) — Over-the-counter approval or 1 to 5 business days for online submission review.
- Kitchen and bathroom remodels (with structural changes) — 4 to 8 weeks for plan check.
- Room additions and ADUs — 8 to 14 weeks for standard plan check. Applicants who submit complete, code-compliant plans on first submission significantly reduce total review time.
- New construction and second story additions — 10 to 18 weeks for standard plan check.
San Jose offers an expedited plan review program for an additional fee, which can reduce review time by 30 to 50%. For time-sensitive projects, the expedited fee is often worth paying.

The Permit Application Process
The typical permit application process in San Jose follows these steps:
- Prepare construction documents. Your architect or designer produces permit-ready drawings per San Jose's submittal requirements.
- Submit application. San Jose accepts online submissions through the building portal for most project types. Paper submittals are accepted at City Hall for complex projects.
- Plan review. Building Division staff review plans for code compliance. First-round comments are common — responsive resubmittals are key to staying on schedule.
- Permit issuance. Once plans are approved, the permit is issued and fees are collected. Work may begin after permit issuance.
- Inspections during construction. Various inspections are required at specific milestones (foundation, framing, rough-in, insulation, final). Do not close up walls before required inspections are signed off.
- Final inspection and sign-off. A final inspection confirms all work matches approved plans and meets code. The final sign-off closes the permit.

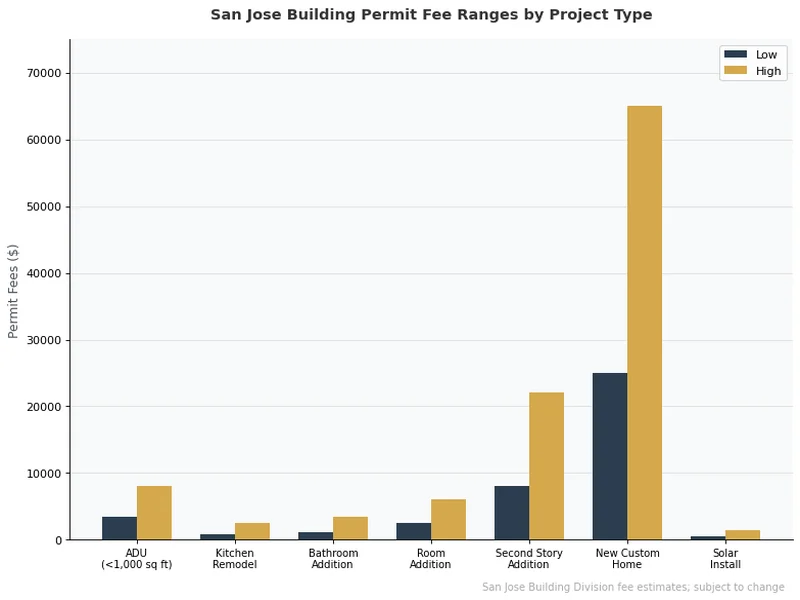

Permit Fee Reference Table
| Project Type | Estimated Permit Fees | Plan Check Required | Typical Review Time |
|---|---|---|---|
| ADU (<1,000 sq ft) | $4,000 – $9,500 | Yes | 8 – 14 weeks |
| Kitchen remodel (with electrical/plumbing) | $950 – $2,800 | Often | 4 – 8 weeks |
| Bathroom addition | $1,400 – $4,000 | Yes | 4 – 8 weeks |
| Room addition | $2,800 – $7,000 | Yes | 8 – 14 weeks |
| Second story addition | $9,000 – $25,000 | Yes | 10 – 18 weeks |
| New custom home | $28,000 – $72,000 | Yes | 12 – 20 weeks |
| Solar installation | $600 – $1,800 | Sometimes | 1 – 5 business days |
| EV charger (dedicated circuit) | $250 – $700 | No | Over-the-counter |
Fee estimates are approximate. Actual fees depend on construction valuation, project scope, and current fee schedules. Contact the San Jose Building Division for current fee estimates.
Unpermitted Work — The Risks
Skipping permits is a significant risk that no legitimate contractor will recommend. The consequences of unpermitted work include:
- Required demolition. Cities can require unpermitted work to be torn out and redone correctly — at the homeowner's expense — years after completion.
- Insurance gaps. Homeowner's insurance may not cover damage from unpermitted work. A fire caused by unpermitted electrical work may not be covered.
- Title and sale complications. Unpermitted additions and remodels are discovered during title searches and real estate transactions. They can kill a sale, require price reductions, or require retroactive permitting (which is more expensive and slower than permitted work upfront).
- Lender issues. Refinancing a home with significant unpermitted work can be difficult or impossible.
- Safety. Permits exist because the required inspections catch real problems — structural deficiencies, electrical hazards, and plumbing failures that can injure or kill occupants. This is the most important reason of all.
