Custom Home Build Process: What to Expect at Each Stage in the Bay Area

By Raven Vuong

Building a custom home in the Bay Area is one of the most rewarding investments a homeowner can make, but the process involves many stages that require careful planning and coordination. Understanding the custom home build process from start to finish helps you set realistic expectations, avoid costly surprises, and make informed decisions at every milestone. Whether you are building on a vacant lot in Los Gatos or replacing an existing structure in Palo Alto, the fundamental phases remain the same.

This guide walks you through each stage of the custom home build process in the Bay Area, covering timelines, key decisions, and what to expect from your builder along the way.

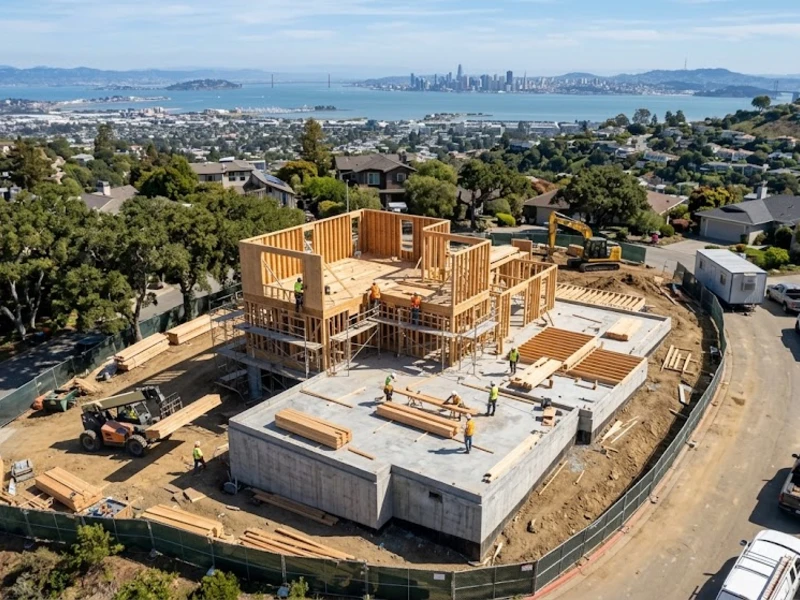

Custom home under construction in the Bay Area showing framing and structural work in progress
Figure 1 — A custom home build in progress in the Bay Area, showing the framing stage with structural elements taking shape.

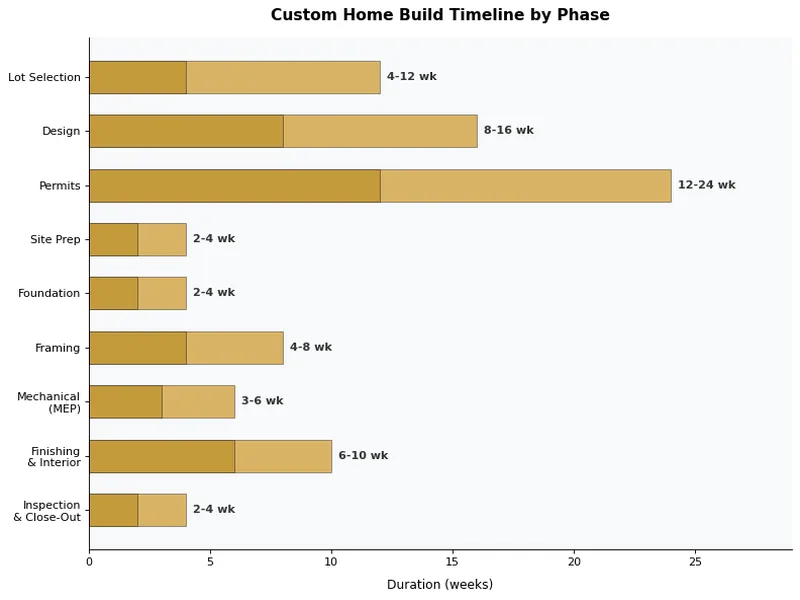

Horizontal bar chart showing custom home build timeline by phase in the Bay Area
Figure 2 — Estimated timeline for each phase of the custom home build process in the Bay Area.

Lot Selection and Land Acquisition

Every custom home project begins with finding the right piece of land. In the Bay Area, lot selection is often the most competitive phase of the process. Desirable neighborhoods in cities like Saratoga, Cupertino, and Mountain View have limited inventory, and many lots come with existing structures that need to be demolished before new construction can begin.

During lot selection, you and your builder should evaluate several critical factors: zoning regulations, setback requirements, slope and grading conditions, soil quality, utility access, and any local design restrictions or historic preservation overlays. A thorough feasibility study at this stage can save months of delays later. Bay Area lots also require environmental and geological assessments, especially in hillside areas where seismic considerations are paramount.

This phase typically takes one to three months, depending on market conditions and how quickly you find a suitable property.

Design and Architectural Planning

Once you have secured a lot, the design phase begins. This is where your vision takes shape through architectural plans, floor layouts, material selections, and engineering specifications. In the Bay Area, most custom homes require the involvement of a licensed architect, a structural engineer, and often a civil engineer for site-specific grading and drainage plans.

The design phase includes several rounds of revision as you refine the layout, select finishes, and ensure the plans comply with local building codes. Bay Area jurisdictions have specific requirements for energy efficiency (Title 24), fire safety, and accessibility that must be incorporated into the design. Your architect will also prepare elevation drawings, landscaping plans, and interior specification sheets that guide the construction team.

Expect the design phase to take two to four months. Larger or more complex homes with custom architectural features may require additional time for specialized engineering and material sourcing.

Permits and Approvals

The permitting phase is often the longest and most unpredictable stage of the custom home build process in the Bay Area. Local building departments review your plans for compliance with zoning laws, building codes, fire safety regulations, and environmental standards. Many Bay Area cities also require design review approval, which adds another layer of evaluation by a planning commission or architectural review board.

In cities like Palo Alto, the design review process alone can take several months. San Jose has streamlined its permitting process in recent years, but complex custom home projects still require three to six months for full plan review and approval. Your builder should submit permit applications as early as possible and maintain close communication with the building department to address any corrections or requests for additional information promptly.

All contractors working on your custom home must hold valid licenses through the Contractors State License Board (CSLB), which oversees new construction licensing in California. Verify your builder and all subcontractors before construction begins.

Site Preparation and Foundation

Grading and Excavation

Once permits are in hand, site preparation begins with demolition of any existing structures, followed by grading and excavation. The site must be leveled to the specifications outlined in the civil engineering plans, and underground utilities (water, sewer, gas, electrical) are roughed in to their designated connection points. In Bay Area hillside locations, retaining walls and specialized drainage systems may be required before the foundation can be poured.

Site preparation typically takes two to four weeks, though challenging terrain or unexpected soil conditions can extend this timeline.

Foundation Pour

The foundation is the structural base of your entire home. In the Bay Area, most custom homes use either a slab-on-grade foundation or a raised foundation with a crawl space, depending on the lot conditions and design requirements. Seismic engineering is a critical component, as all Bay Area foundations must meet stringent earthquake resistance standards.

The foundation phase involves forming, rebar installation, inspection, and the concrete pour itself. After the pour, the concrete must cure for a minimum period before framing can begin. This phase takes two to four weeks from start to completion.

Framing and Structural Work

Framing is the stage where your custom home begins to take its recognizable shape. The structural skeleton of the house goes up, including walls, floors, roof trusses, and window and door openings. This is one of the most visually dramatic phases of the build, and it gives you the first real sense of how the spaces will feel.

In the Bay Area, framing typically uses wood-frame construction, though steel framing is becoming more common in areas with higher fire risk. Your builder will coordinate a framing inspection with the building department once the structural skeleton is complete, verifying that all elements meet the engineered plans and local code requirements. Any modifications to the framing plan must be approved by the structural engineer before proceeding.

Framing takes four to eight weeks for a typical Bay Area custom home, depending on the size and complexity of the design.

Mechanical Systems (MEP)

After framing is complete and inspected, the mechanical, electrical, and plumbing (MEP) rough-in phase begins. This is when all the systems that make your home functional are installed inside the walls, floors, and ceilings before they are closed up with drywall.

  • Electrical: All wiring, outlet boxes, switch locations, panel connections, and low-voltage wiring for networking, security, and audio/video systems are installed.
  • Plumbing: Supply lines, drain lines, vent pipes, and fixture rough-ins for kitchens, bathrooms, and laundry rooms are run through the framing.
  • HVAC: Ductwork, furnace placement, and air conditioning lines are installed. Bay Area homes increasingly incorporate energy-efficient heat pump systems and smart thermostats.
  • Fire sprinklers: Many Bay Area jurisdictions require residential fire sprinkler systems in new construction.

Each trade requires a separate rough-in inspection before the walls can be closed. The MEP phase takes three to six weeks, with inspections scheduled between each trade.

Finishing and Interior Work

The finishing phase is the longest single stage of the custom home build process. Once all rough-in inspections pass, the walls are insulated (meeting Bay Area Title 24 energy requirements) and closed with drywall. From there, the interior finishes are installed in a carefully sequenced order:

  1. Drywall, taping, and texture — Walls and ceilings are finished to a smooth or textured surface ready for paint.
  2. Interior painting — All walls, ceilings, trim, and doors receive primer and finish coats.
  3. Cabinetry and millwork — Kitchen cabinets, bathroom vanities, built-in shelving, and custom trim are installed.
  4. Flooring — Hardwood, tile, carpet, or other flooring materials are laid throughout the home.
  5. Countertops and fixtures — Kitchen and bathroom countertops are templated and installed, followed by plumbing fixtures, lighting, and hardware.
  6. Appliances and final connections — Kitchen appliances, HVAC equipment, water heater, and electrical panels receive their final hookups.

Exterior finishing happens in parallel, including siding, stucco or stone veneer, roofing completion, exterior painting, and landscaping. The finishing phase takes six to ten weeks for most Bay Area custom homes.

Final Inspection and Close-Out

The final phase involves a series of inspections by the local building department to verify that all work meets code and matches the approved plans. The building inspector will check structural elements, electrical systems, plumbing, HVAC, fire safety, energy compliance, and accessibility features. Once all inspections pass, the city issues a Certificate of Occupancy (CO), which officially authorizes you to move into your new home.

Your builder will also conduct a detailed walkthrough with you to create a punch list of any items that need correction or completion. Common punch-list items include paint touch-ups, hardware adjustments, minor trim work, and appliance calibration. A reputable builder will address all punch-list items before the final handoff.

The inspection and close-out phase takes two to four weeks, including time for punch-list completion.

Timeline and Cost Overview

The table below provides a comprehensive overview of each phase, including typical timelines and the approximate percentage of total project cost allocated to each stage:

PhaseTimelineCost %What Happens
Lot Selection1 – 3 months30 – 50%Land purchase, feasibility study, soil and environmental testing
Design & Architecture2 – 4 months5 – 8%Architectural plans, engineering, material selections, Title 24 compliance
Permits & Approvals3 – 6 months2 – 4%Plan review, design review, permit fees, corrections and resubmittals
Site Prep2 – 4 weeks3 – 5%Demolition, grading, excavation, utility rough-in
Foundation2 – 4 weeks5 – 8%Forming, rebar, inspection, concrete pour, curing
Framing4 – 8 weeks10 – 15%Structural skeleton, walls, roof, windows, doors
Mechanical (MEP)3 – 6 weeks10 – 15%Electrical, plumbing, HVAC, fire sprinklers, inspections
Finishing & Interior6 – 10 weeks20 – 30%Drywall, paint, cabinets, flooring, countertops, fixtures, landscaping
Inspection & Close-Out2 – 4 weeks1 – 2%Final inspections, Certificate of Occupancy, punch list, handoff

In total, a custom home build in the Bay Area typically takes twelve to eighteen months from the start of design to move-in, with some projects extending longer depending on permitting timelines and complexity. Working with an experienced custom home builder who understands Bay Area regulations and construction practices is the best way to keep your project on track and within budget.

At 9Builders, we guide our clients through every phase of the custom home build process, from lot evaluation and design coordination through permitting, construction, and final walkthrough. Our team handles the complexity so you can focus on the exciting decisions that make your home uniquely yours. Contact us to start planning your custom home in the Bay Area.

Frequently Asked Questions

Common questions about the custom home build process in the Bay Area.

A custom home build in the Bay Area typically takes twelve to eighteen months from the start of design to move-in. The permitting phase alone can take three to six months, with construction taking an additional six to twelve months depending on the size and complexity of the project.

Land acquisition is often the largest single cost, accounting for 30 to 50 percent of the total project budget in the Bay Area. Among construction phases, finishing and interior work (drywall, cabinetry, flooring, fixtures) typically represents the highest construction cost at 20 to 30 percent.

Yes. Building a custom home requires multiple permits, including a building permit, grading permit, electrical permit, plumbing permit, and mechanical permit. Many Bay Area cities also require a design review approval. All permits must be obtained before construction begins.

Evaluate zoning regulations, setback requirements, slope conditions, soil quality, utility access, and any local design restrictions. A thorough feasibility study conducted with your builder and architect can identify potential issues before you commit to a purchase.

Look for a builder with a valid California contractor license, extensive experience with custom homes in your target Bay Area city, strong references, transparent pricing, and a proven track record of managing the permitting process. At 9Builders, we specialize in custom home building throughout the Bay Area. Contact us to discuss your project.

Changes during construction are possible but can add cost and delay. Minor adjustments to finishes or fixtures are usually straightforward. Structural changes or modifications that affect the approved plans may require revised permits and additional engineering review, which can add weeks to the timeline.

Related Posts

SB 9 Lot Split Guide: How to Split Your Property in the Bay Area

SB 9 Lot Split Guide: How to Split Your Property in the Bay Area

Learn how to split your Bay Area property under SB 9 with our step-by-step lot split guide covering ...

Read More →
Walk-In Shower vs Bathtub: Which Adds More Value to Your Bay Area Home?

Walk-In Shower vs Bathtub: Which Adds More Value to Your Bay Area Home?

Compare walk-in showers and bathtubs for Bay Area bathroom remodels. Covers costs, resale value, pro...

Read More →
Kitchen Layout Design Guide: Best Layouts for Bay Area Homes

Kitchen Layout Design Guide: Best Layouts for Bay Area Homes

Guide to kitchen layouts for Bay Area homes. Covers L-shaped, U-shaped, galley, island, and open-con...

Read More →

Ready to Start Your Project?

Contact us today for a free consultation and estimate.

Get Started
